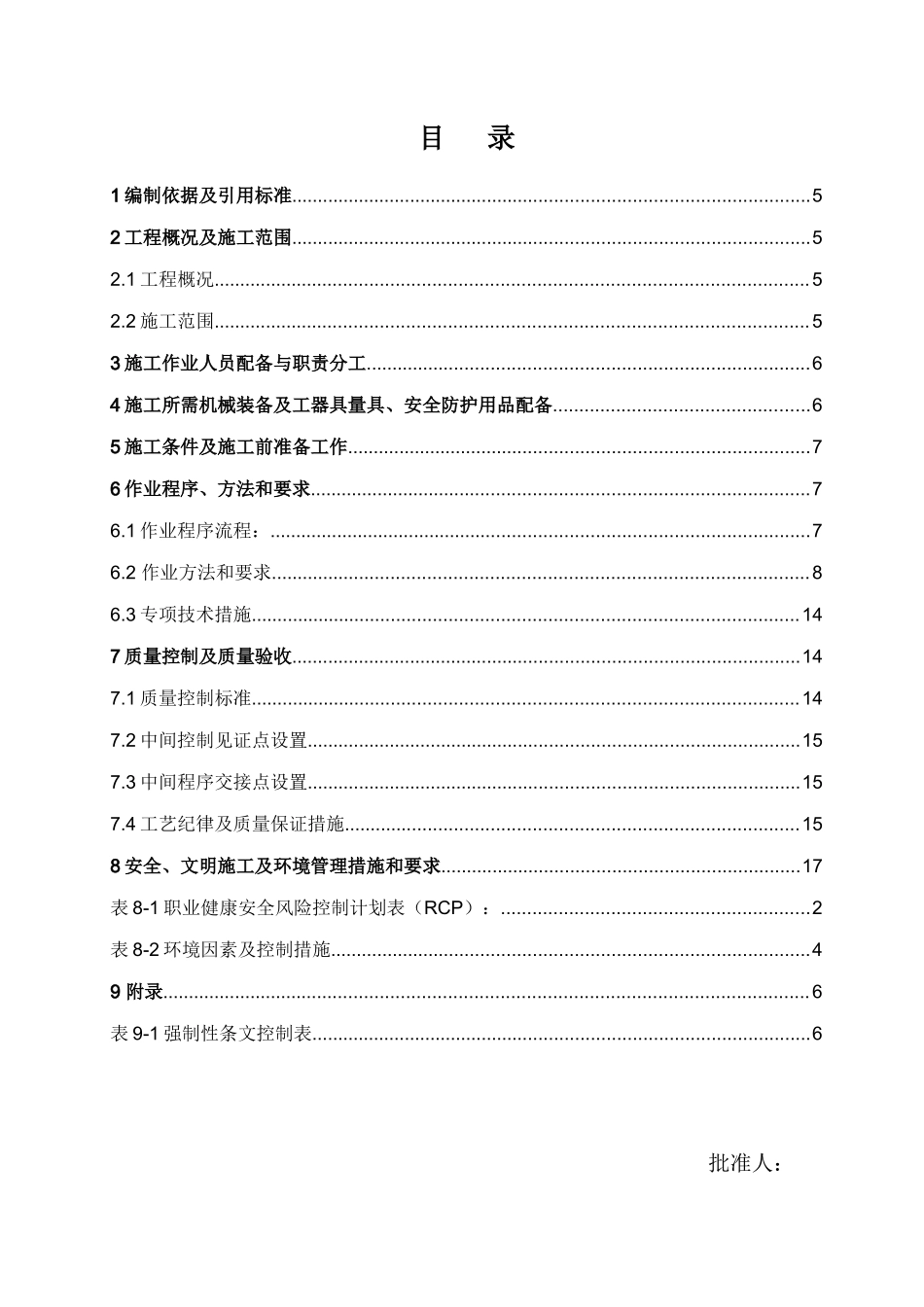

A实施REV版次签名日期签名日期签名日期MODI.修改STATUS状态编写AUTH审核CHK'DBY批准APP'DBYGUANGDONGPOWERENGINEERINGCORPORATION广东火电工程总公司平海工程项目部文件号:GPEC/PHP/GL/EP/0102/011施工方案脱硝施工方案版权所有COPYRIGHT:广东火电平海工程项目部。任何人未经我项目部书面许可不得擅自使用、复制、传递或泄露本文件。Page1of14目录1编制依据及引用标准....................................................................................................52工程概况及施工范围....................................................................................................52.1工程概况..................................................................................................................52.2施工范围..................................................................................................................53施工作业人员配备与职责分工.....................................................................................64施工所需机械装备及工器具量具、安全防护用品配备.................................................65施工条件及施工前准备工作.........................................................................................76作业程序、方法和要求................................................................................................76.1作业程序流程:........................................................................................................76.2作业方法和要求.......................................................................................................86.3专项技术措施.........................................................................................................147质量控制及质量验收..................................................................................................147.1质量控制标准.........................................................................................................147.2中间控制见证点设置...............................................................................................157.3中间程序交接点设置...............................................................................................157.4工艺纪律及质量保证措施.......................................................................................158安全、文明施工及环境管理措施和要求.....................................................................17表8-1职业健康安全风险控制计划表(RCP):...........................................................2表8-2环境因素及控制措施............................................................................................49附录............................................................................................................................6表9-1强制性条文控制表................................................................................................6批准人:作业指导书/技术措施/施工方案控制页:配置发放签收表配置配置岗位电子版纸质版签收项目总工项目工程部项目质管部项目安保部项目专工项目主管工程师/班长*班组工程师施工组长*注:班组工程师负责在项目完成后将施工文件包中得作业指导书/技术措施/施工方案上交,此作业指导书/技术措施/施工方案应完善并有完整签名。作业指导书(技术措施、施工方案)级别重要签名一般√技术交底记录检查项目总工程师专责工程师重大方案执行情况项目总工程师项目生产经理重要工序过程监控表序号重要工序名称执行情况质检工程师签名1反应器支座安装2反应器承重墙及进、出口罩3催化剂安装4吹灰器安...
