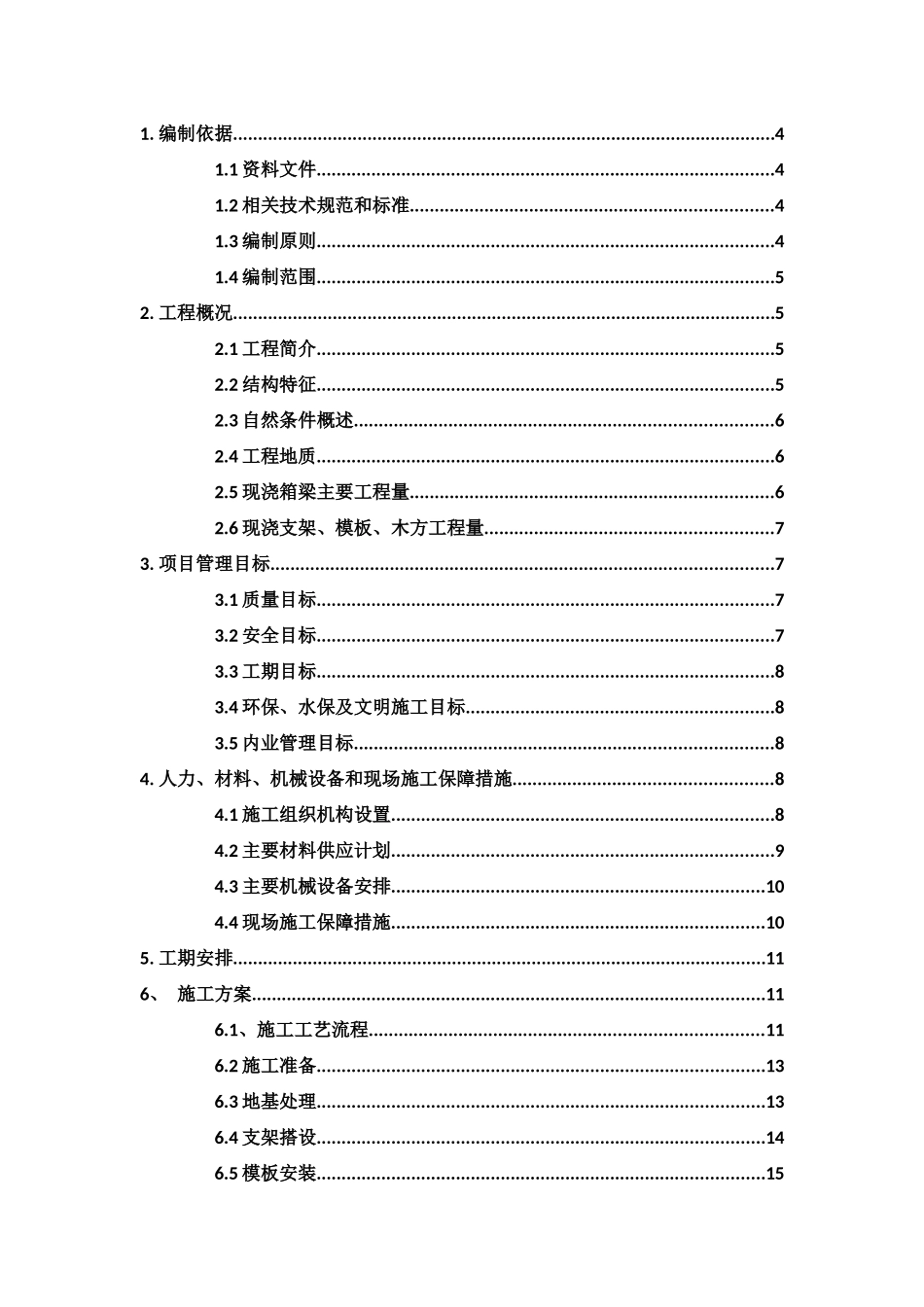

惠新大道及梅湖大道建设工程01标现浇连续预应力箱梁施工方案编制人:审核人:批准人:1.编制依据.............................................................................................................41.1资料文件............................................................................................41.2相关技术规范和标准.........................................................................41.3编制原则............................................................................................41.4编制范围............................................................................................52.工程概况.............................................................................................................52.1工程简介............................................................................................52.2结构特征............................................................................................52.3自然条件概述....................................................................................62.4工程地质............................................................................................62.5现浇箱梁主要工程量.........................................................................62.6现浇支架、模板、木方工程量..........................................................73.项目管理目标.....................................................................................................73.1质量目标............................................................................................73.2安全目标............................................................................................73.3工期目标............................................................................................83.4环保、水保及文明施工目标..............................................................83.5内业管理目标....................................................................................84.人力、材料、机械设备和现场施工保障措施....................................................84.1施工组织机构设置.............................................................................84.2主要材料供应计划.............................................................................94.3主要机械设备安排...........................................................................104.4现场施工保障措施...........................................................................105.工期安排...........................................................................................................116、施工方案.......................................................................................................116.1、施工工艺流程...............................................................................116.2施工准备..........................................................................................136.3地基处理..........................................................................................136.4支架搭设..........................................................................................146.5模板安装..........................................................................................156.6支架预压..........................................................................................156.7支座安装.......................................................
