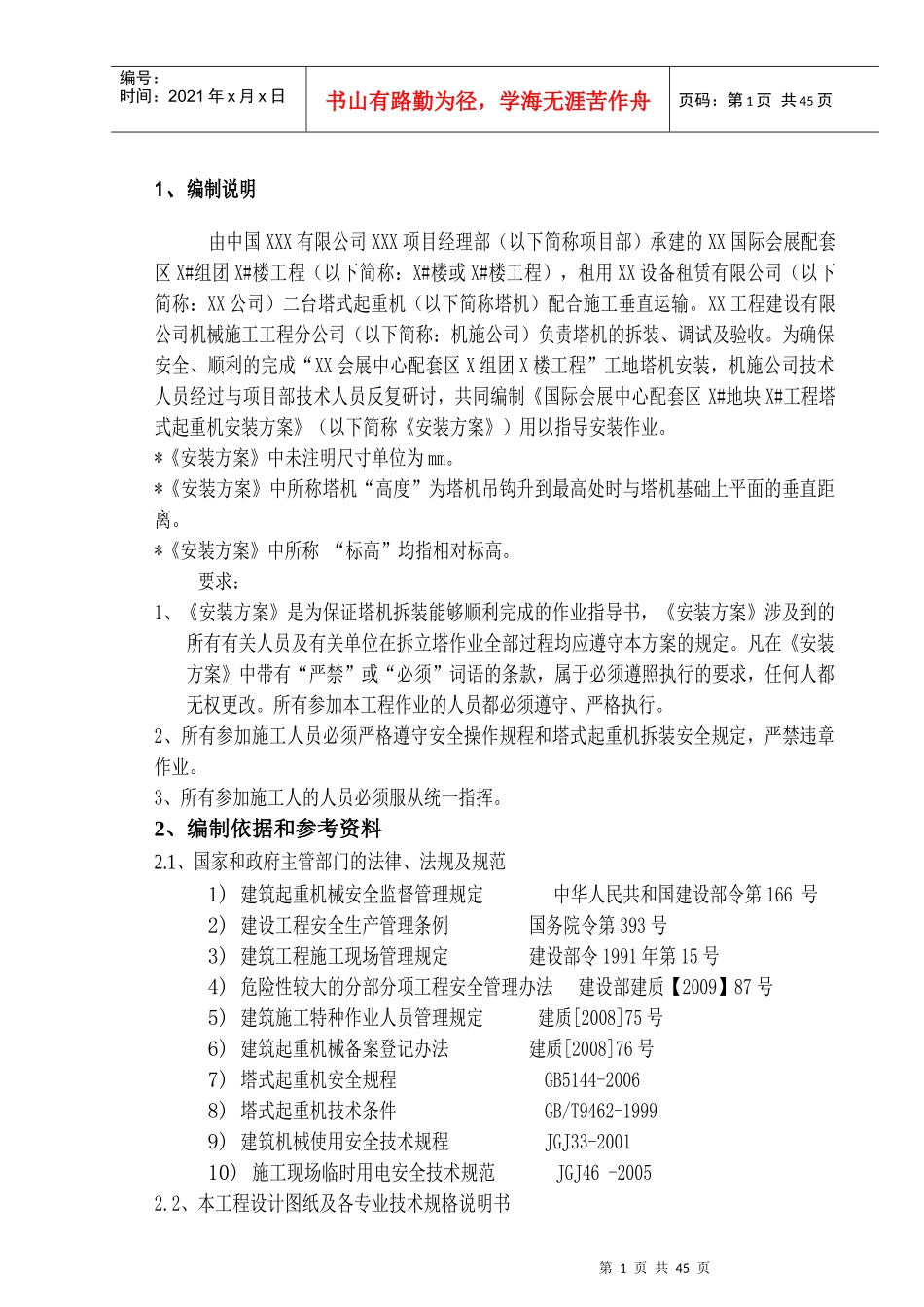

塔式起重机安装施工方案目录1、编制说明·····································································································12、编制依据和参考资料····················································································13、工程概况···································································································23.1、工程概况(参见附件现场示意图)····························································23.2、塔机型号选择及定位··············································································23.3、塔机基本参数···························································································34、工期及工程量··································································································54.1塔机的安装的时间安排···················································································54.2全部工程量·······························································································65、塔机基础方案:·······························································································65.1基本准备································································································65.2塔吊基础施工··························································································75.3塔吊基础施工··························································································76、施工准备···································································································96.1组织机构·······························································································96.2塔吊操作和指挥人员岗位职责···································································106.3技术准备············································································...
