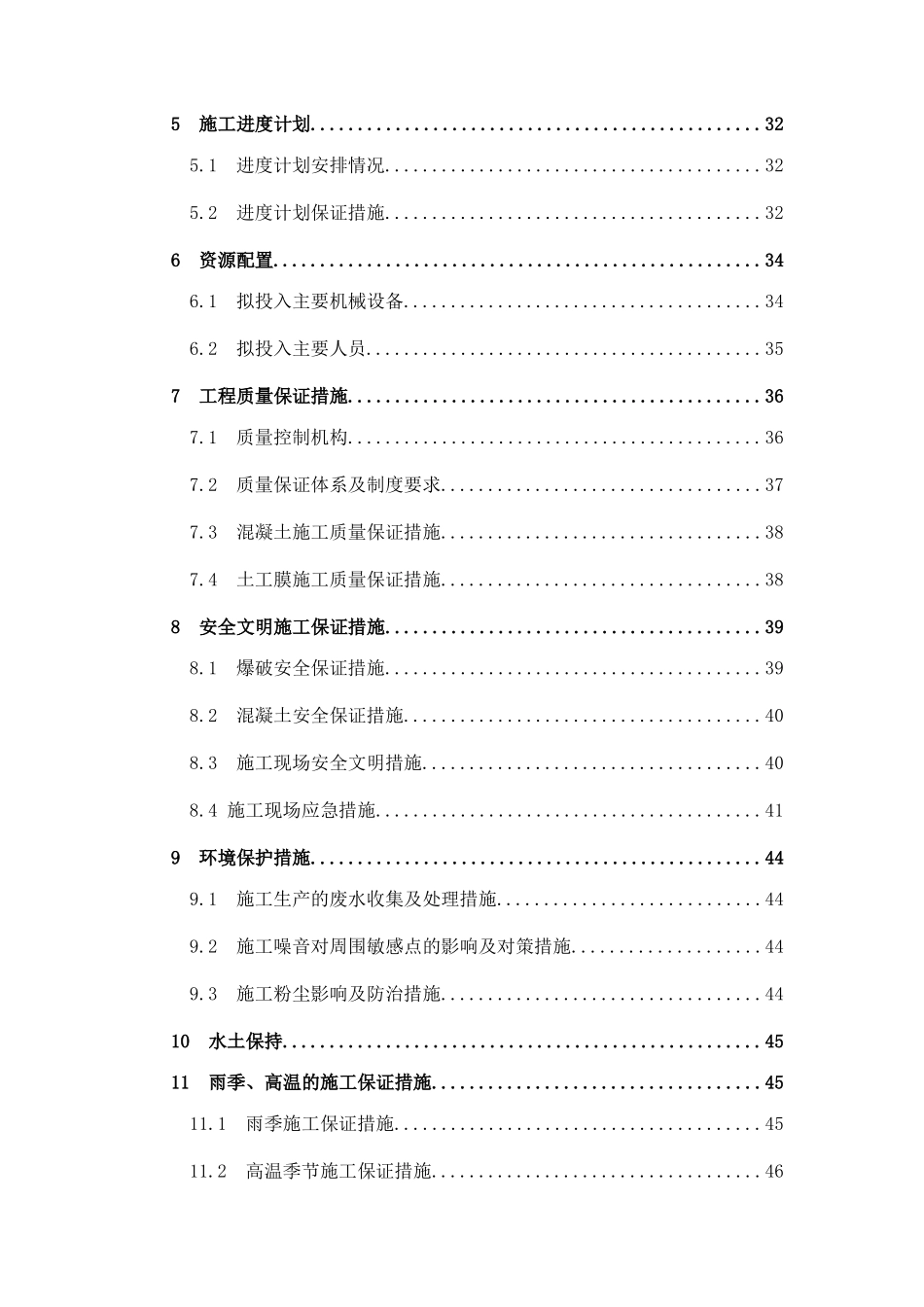

四川省都江堰灌区毗河供水一期工程中兴支渠明渠施工方案编写:校核:批准:中国电力建设股份有限公司四川省都江堰灌区毗河供水一期工程施工总承包部目录1工程概况及编制依据...........................................11.1编制依据:.................................................11.2工程概况...................................................12施工布置.....................................................32.1施工供水.................................................32.2施工供电.................................................32.3施工供风.................................................32.4施工排水.................................................42.5施工交通布置.............................................42.6渣场、生活区布置.........................................52.7拌合系统布置.............................................53施工重点、难点分析及应对措施.................................64施工方法.....................................................64.1土石方开挖施工...........................................64.2支护施工................................................104.3填筑施工................................................164.4土工合成材料施工........................................194.5明渠混凝土衬砌浇筑施工..................................224.6浆砌石砌筑施工..........................................274.7泥结碎石施工............................................284.8伸缩缝施工..............................................294.9、矩形明渠施工工艺........................................315施工进度计划................................................325.1进度计划安排情况........................................325.2进度计划保证措施........................................326资源配置....................................................346.1拟投入主要机械设备......................................346.2拟投入主要人员..........................................357工程质量保证措施............................................367.1质量控制机构............................................367.2质量保证体系及制度要求..................................377.3混凝土施工质量保证措施..................................387.4土工膜施工质量保证措施..................................388安全文明施工保证措施........................................398.1爆破安全保证措施........................................398.2混凝土安全保证措施......................................408.3施工现场安全文明措施....................................408.4施工现场应急措施.........................................419环境保护措施................................................449.1施工生产的废水收集及处理措施............................449.2施工噪音对周围敏感点的影响及对策措施....................449.3施工粉尘影响及防治措施..................................4410水土保持...................................................4511雨季、高温的施工保证措施...................................4511.1雨季施工保证措施.......................................4511.2高温季节施工保证措施...................................4612成本控制措施...............................................4612.1材料控制...............................................4612.2材料用量控制...........................................4612.3材料价格控制...........................................4712.4费用控制...............................................47第1页共51页编号:时间:2021年x月x日书山有路勤...
