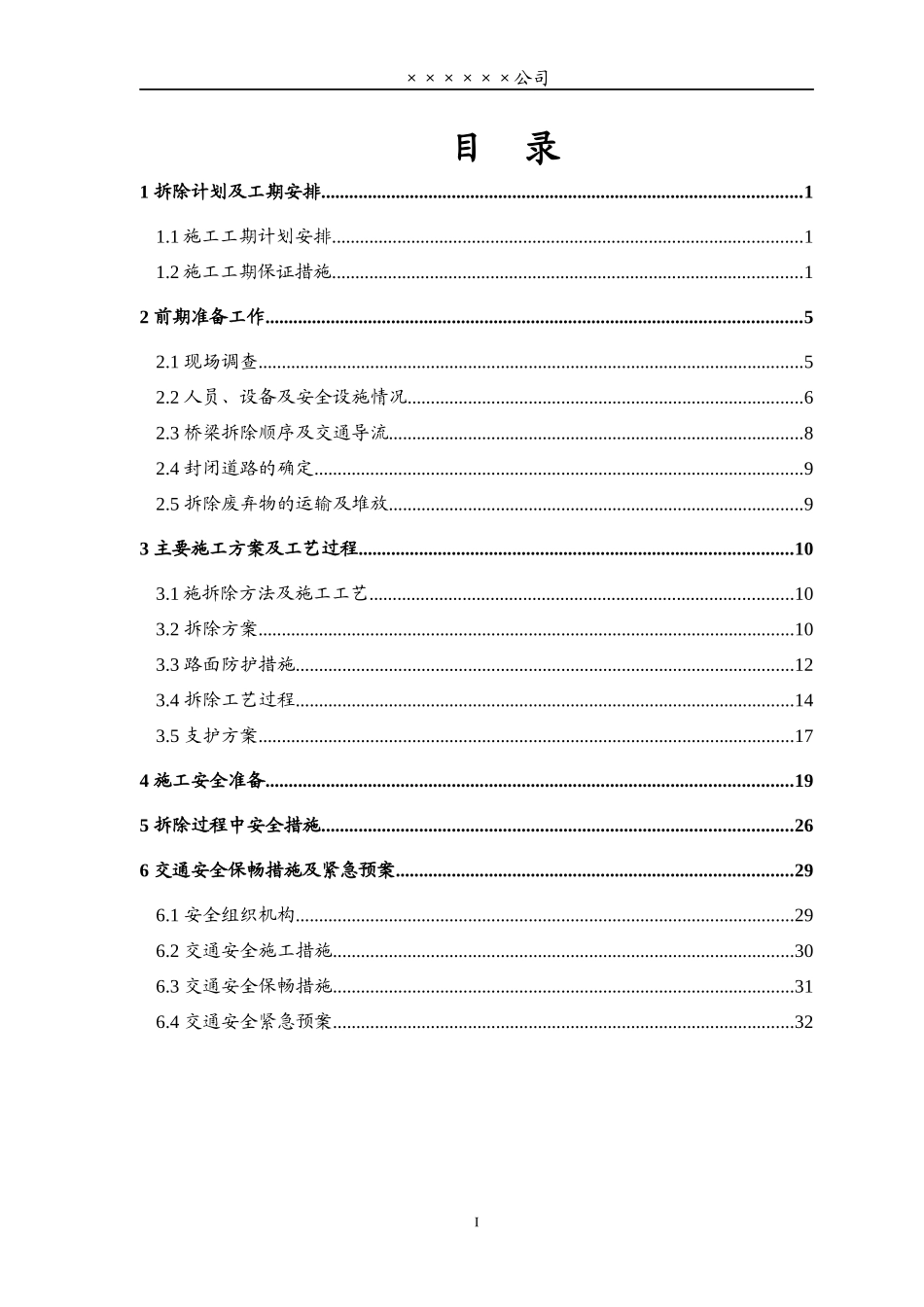

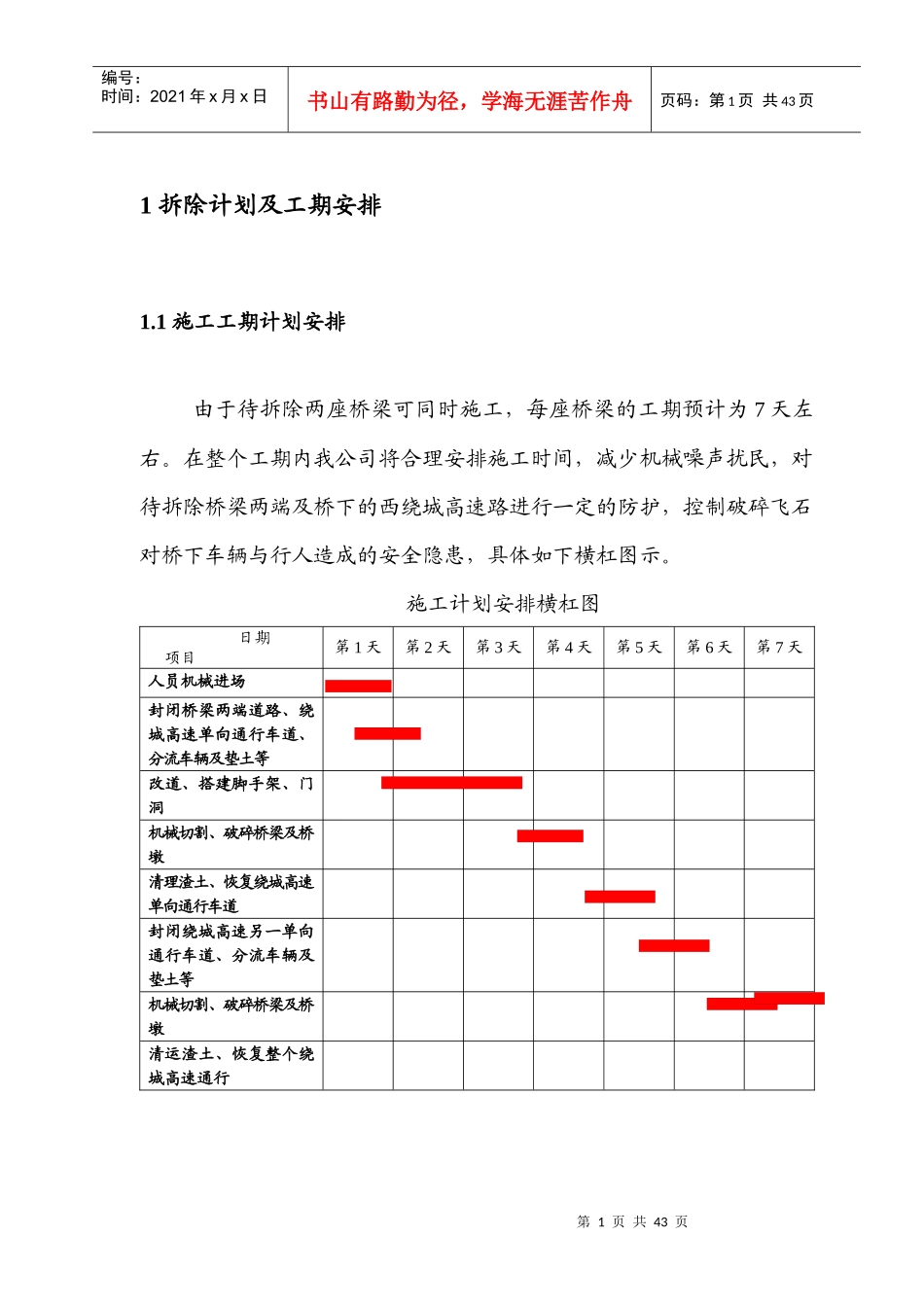

西安市西绕城高速路上桥群机械拆除工程施工方案设计单位:时间:2011年3月××××××公司目录1拆除计划及工期安排.......................................................................................................11.1施工工期计划安排.....................................................................................................11.2施工工期保证措施.....................................................................................................12前期准备工作...................................................................................................................52.1现场调查.....................................................................................................................52.2人员、设备及安全设施情况.....................................................................................62.3桥梁拆除顺序及交通导流.........................................................................................82.4封闭道路的确定.........................................................................................................92.5拆除废弃物的运输及堆放.........................................................................................93主要施工方案及工艺过程.............................................................................................103.1施拆除方法及施工工艺...........................................................................................103.2拆除方案...................................................................................................................103.3路面防护措施...........................................................................................................123.4拆除工艺过程...........................................................................................................143.5支护方案...................................................................................................................174施工安全准备.................................................................................................................195拆除过程中安全措施.....................................................................................................266交通安全保畅措施及紧急预案.....................................................................................296.1安全组织机构...........................................................................................................296.2交通安全施工措施...................................................................................................306.3交通安全保畅措施...................................................................................................316.4交通安全紧急预案...................................................................................................32I第1页共43页编号:时间:2021年x月x日书山有路勤为径,学海无涯苦作舟页码:第1页共43页1拆除计划及工期安排1.1施工工期计划安排由于待拆除两座桥梁可同时施工,每座桥梁的工期预计为7天左右。在整个工期内我公司将合理安排施工时间,减少机械噪声扰民,对待拆除桥梁两端及桥下的西绕城高速路进行一定的防护,控制破碎飞石对桥下车辆与行人造成的安全隐患,具体如下横杠图示。施工计划安排横杠图日期项目第1天第2天第3天第4天第5天第6天第7天人员机械进场封闭桥梁两端道路、绕城高速单向通行车道、分流车辆及垫土等改道、搭建脚手架、门洞机械切割、破碎桥梁及桥墩清理渣土、恢复绕城高速单向通行车道封闭绕城...
