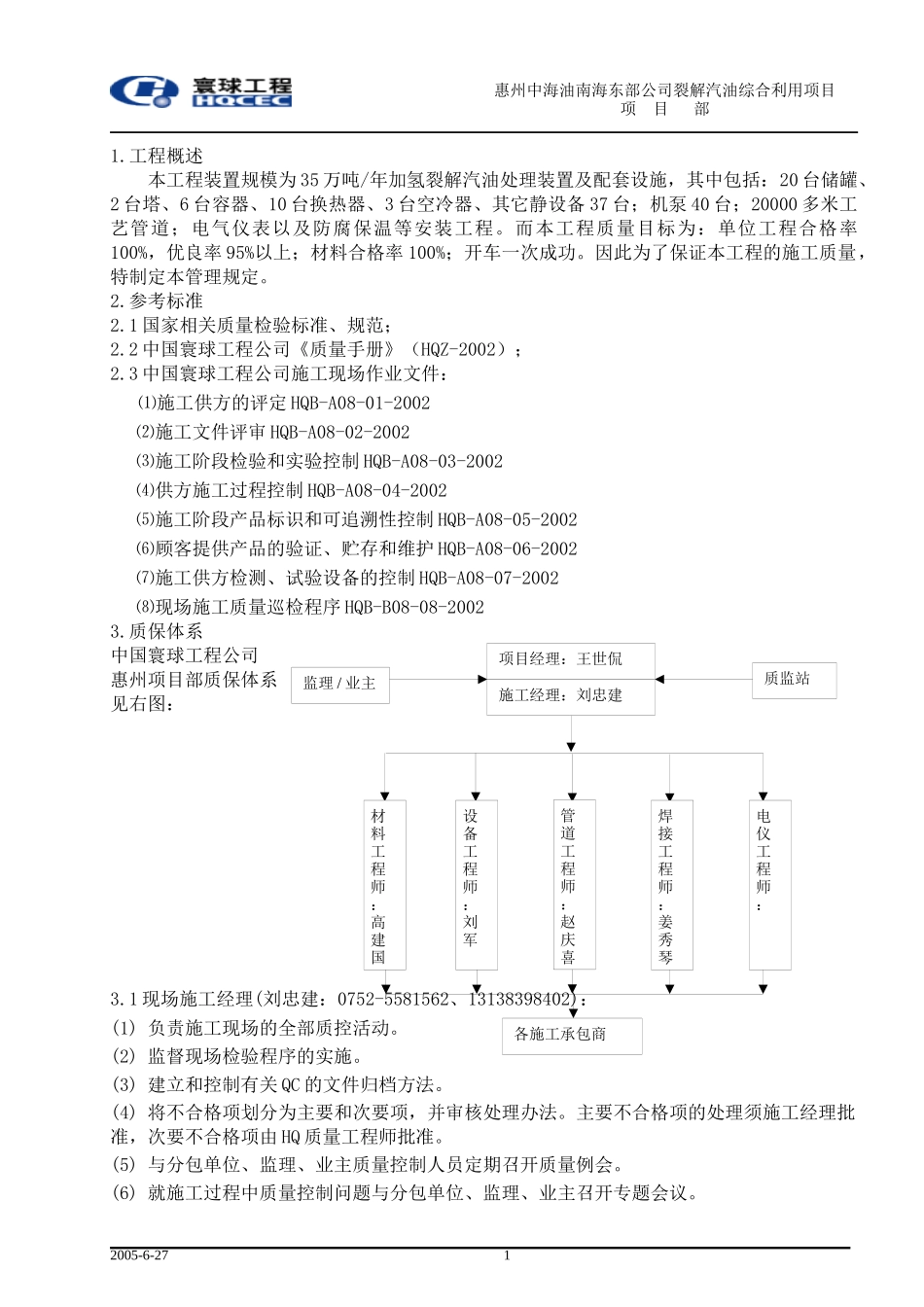

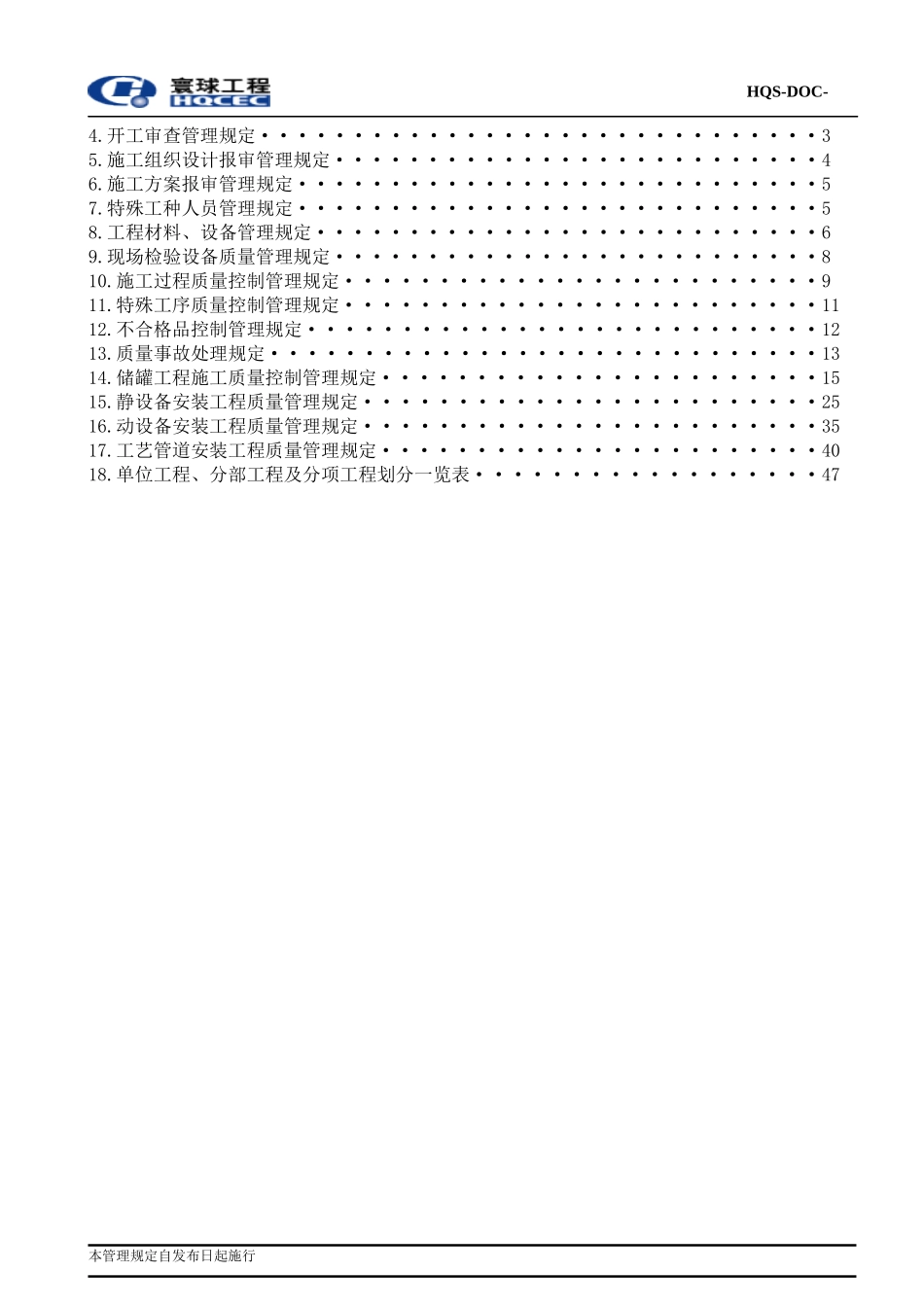

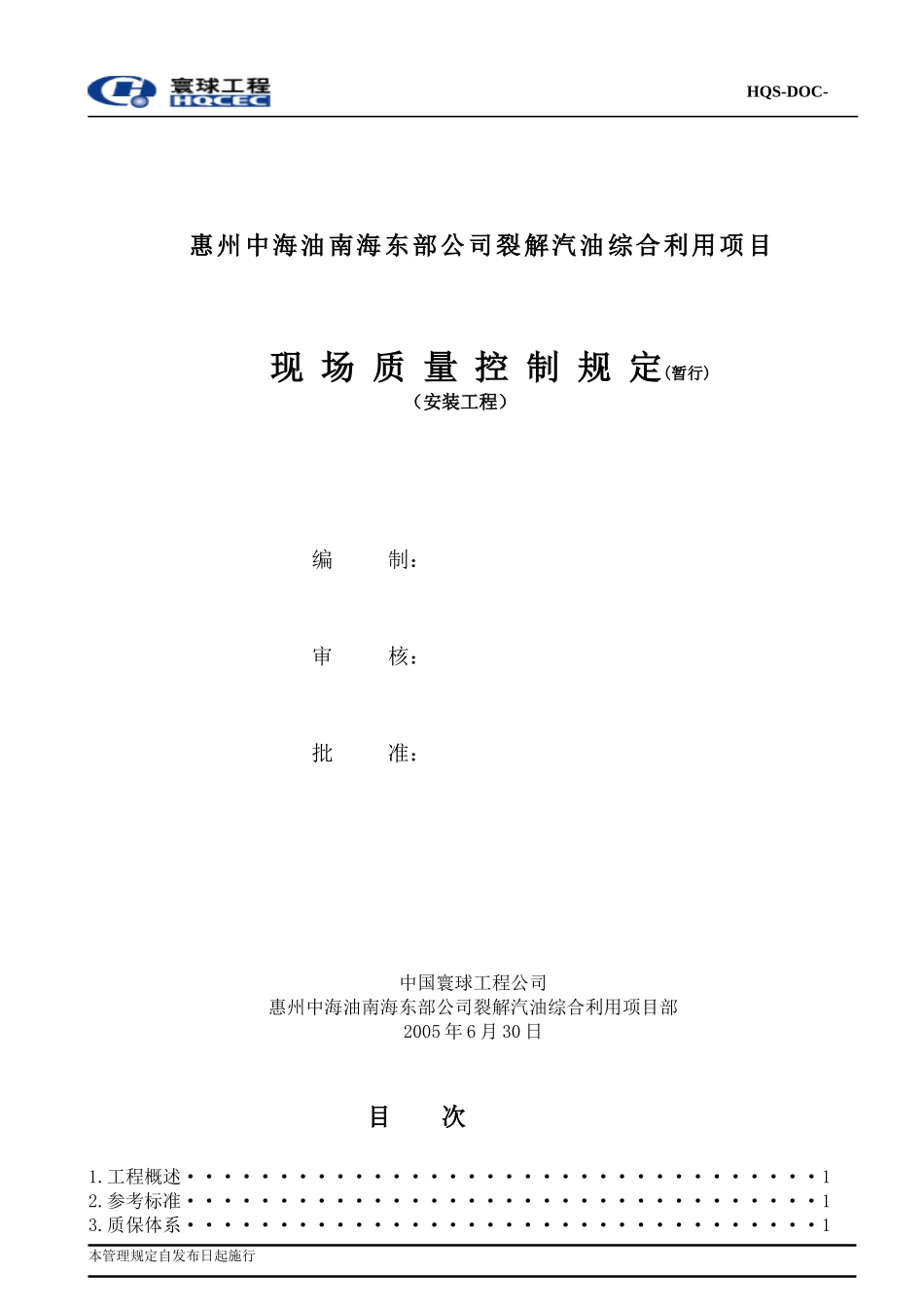

HQS-DOC-惠州中海油南海东部公司裂解汽油综合利用项目现场质量控制规定(暂行)(安装工程)编制:审核:批准:中国寰球工程公司惠州中海油南海东部公司裂解汽油综合利用项目部2005年6月30日目次1.工程概述··································12.参考标准··································13.质保体系··································1本管理规定自发布日起施行HQS-DOC-4.开工审查管理规定······························35.施工组织设计报审管理规定··························46.施工方案报审管理规定····························57.特殊工种人员管理规定····························58.工程材料、设备管理规定···························69.现场检验设备质量管理规定··························810.施工过程质量控制管理规定·························911.特殊工序质量控制管理规定·························1112.不合格品控制管理规定···························1213.质量事故处理规定·····························1314.储罐工程施工质量控制管理规定·······················1515.静设备安装工程质量管理规定························2516.动设备安装工程质量管理规定························3517.工艺管道安装工程质量管理规定·······················4018.单位工程、分部工程及分项工程划分一览表··················47本管理规定自发布日起施行惠州中海油南海东部公司裂解汽油综合利用项目项目部项目经理:王世侃施工经理:刘忠建质监站监理/业主材料工程师:高建国设备工程师:刘军焊接工程师:姜秀琴电仪工程师:各施工承包商管道工程师:赵庆喜1.工程概述本工程装置规模为35万吨/年加氢裂解汽油处理装置及配套设施,其中包括:20台储罐、2台塔、6台容器、10台换热器、3台空冷器、其它静设备37台;机泵40台;20000多米工艺管道;电气仪表以及防腐保温等安装工程。而本工程质量目标为:单位工程合格率100%,优良率95%以上;材料合格率100%;开车一次成功。因此为了保证本工程的施工质量,特制定本管理规定。2.参考标准2.1国家相关质量检验标准、规范;2.2中国寰球工程公司《质量手册》(HQZ-2002);2.3中国寰球工程公司施工现场作业文件:⑴施工供方的评定HQB-A08-01-2002⑵施工文件评审HQB-A08-02-2002⑶施工阶段检验和实验控制HQB-A08-03-2002⑷供方施工过程控制HQB-A08-04-2002⑸施工阶段产品标识和可追溯性控制HQB-A08-05-2002⑹顾客提供产品的验证、贮存和维护HQB-A08-06-2002⑺施工供方检测、试验设备的控制HQB-A08-07-2002⑻现场施工质量巡检程序HQB-B08-08-20023.质保体系中国寰球工程公司惠州项目部质保体系见右图:3.1现场施工经理(刘忠建:0752-5581562、13138398402):(1)负责施工现场的全部质控活动。(2)监督现场检验程序的实施。(3)建立和控制有关QC的文件归档方法。(4)将不合格项划分为主要和次要项,并审核处理办法。主要不合格项的处理须施工经理批准,次要不合格项由HQ质量工程师批准。(5)与分包单位、监理、业主质量控制人员定期召开质量例会。(6)就施工过程中质量控制问题与分包单位、监理、业主召开专题会议。2005-6-271惠州中海油南海东部公司裂解汽油综合利用项目项目部YES返回整改返回整改施工承包商整理有关资料总承包商初审资料的有效性监理工程师审查相关资料批准开工YESNONO3.2专业质量控制工程师(赵庆喜、刘军:0752-5581595):(1)监督和指导施工承包商采用最新版的规范、标准和施工图。(2)监督施工分包商落...
