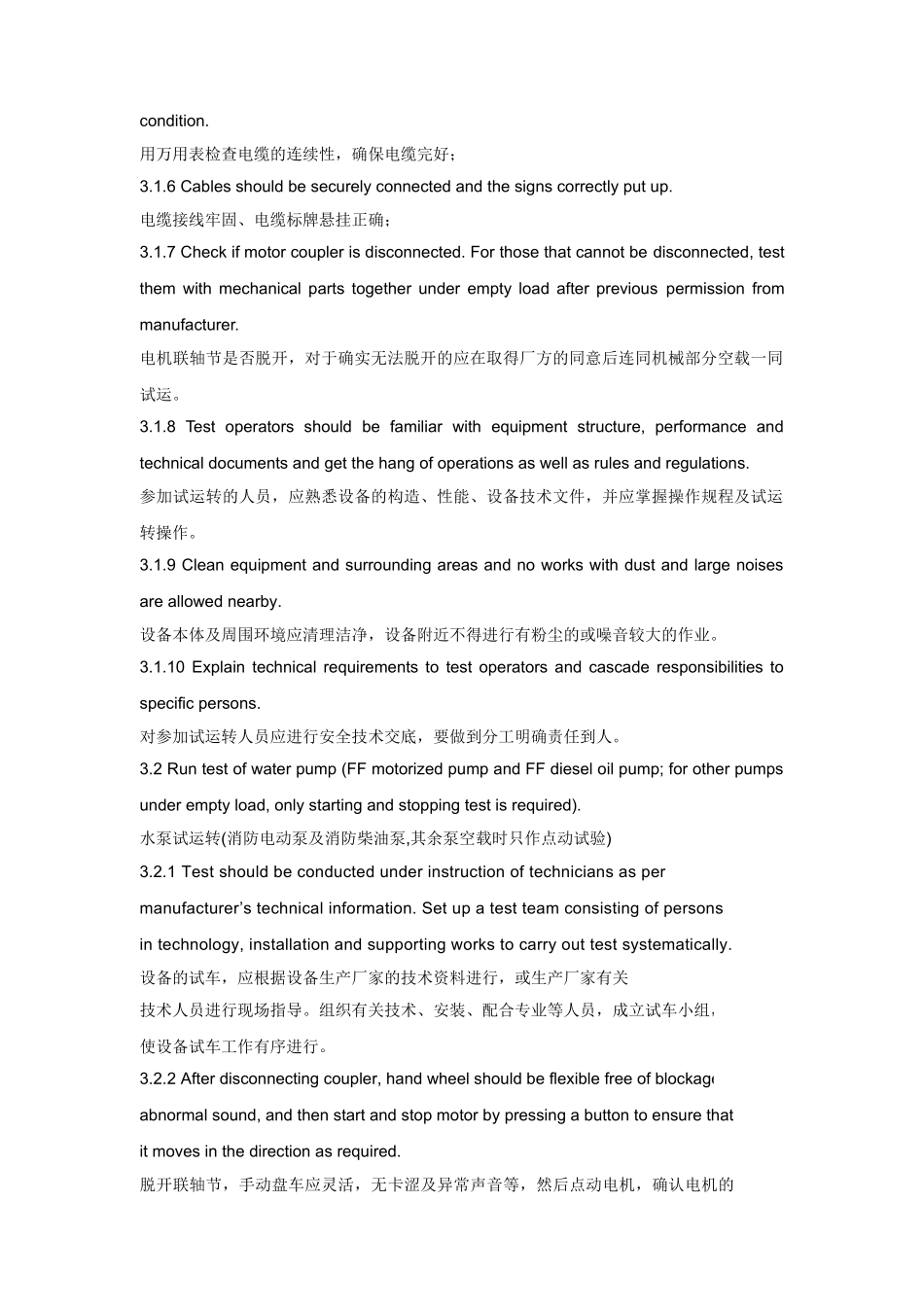

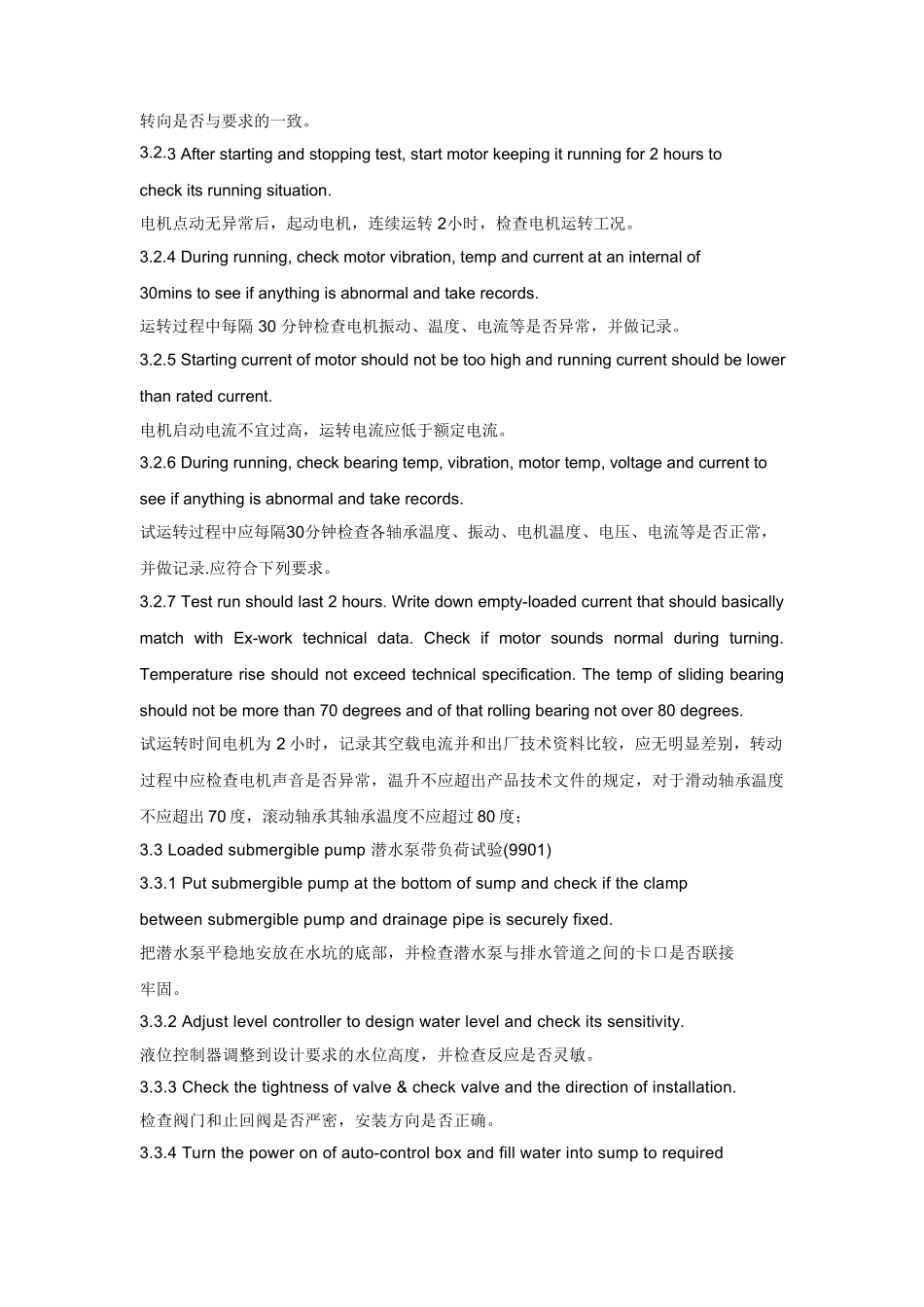

Test Run Plan for Pump Equipment泵设备单机试车方案1. Description 编制说明Pump equipment in this project is mainly used for fire fighting system and 9902 and 9901 water systems. This plan mainly describes unit test run of pump, with the presence of Owner, Supervision Company, Equipment Supplier and Contractor. 本工程泵设备主要用于消防系统及 9902、9901 水系统,本方案主要阐述泵的单机试运行。本试车由施工单位;监理单位;建设单位及设备供应商一起参加.2. Reference 编制依据2.1 Construction drawings provided by East China Engineering Technology Co., Ltd. 东华工程科技股份有限公司提供的施工图2.2 Product instructions and supporting information 产品说明书及随机资料。2.3 Universal Code for Construction and Acceptance of ME Installation Project《机械设备安装工程施工及验收通用法律规范》GB50231-982.4 Code for Construction and Acceptance of Compressor, Fan, Pump Installation Project《压缩机、风机、泵安装工程施工及验收法律规范》GB50275-983. Test run 试车3.1Technical preparation 技术准备3.1.1 Preparation before test run 试车前应检查下列工作是否完成;3.1.2 Check all running equipment by moving with hand. They should be flexible without blockage. And check if distribution cabinet and motor terminal meet requirements. 检查各转动设备,用手盘动,应灵活,无卡滞现象,配电柜是否符合要求,及电机接线端子是否符合产品要求。3.1.3 Test motor winding and insulation resistance of cables with megger ensuring min resistance of 0.5MΩ. 用兆欧表测试电机绕组及电缆绝缘电阻,确保绝缘电阻值不得低于 0.5MΩ;3.1.4 Check if motor winding matches with motor nameplate. 检查电机绕组接法是否与电机铭牌相符;3.1.5 Check continuity of cables with multi-meter to ensure they are under good condition. 用万用表检查电缆的连续性,确保电缆完好;3.1.6 Cables should be securely connected and the signs correctly put up.电缆接线牢固、电缆标牌悬挂正确;3.1.7 Ch...

1、当您付费下载文档后,您只拥有了使用权限,并不意味着购买了版权,文档只能用于自身使用,不得用于其他商业用途(如 [转卖]进行直接盈利或[编辑后售卖]进行间接盈利)。
2、本站所有内容均由合作方或网友上传,本站不对文档的完整性、权威性及其观点立场正确性做任何保证或承诺!文档内容仅供研究参考,付费前请自行鉴别。
3、如文档内容存在违规,或者侵犯商业秘密、侵犯著作权等,请点击“违规举报”。

碎片内容

泵设备单机试车方案

确认删除?
VIP
微信客服
  • 扫码咨询
会员Q群
  • 会员专属群点击这里加入QQ群
客服邮箱
回到顶部
