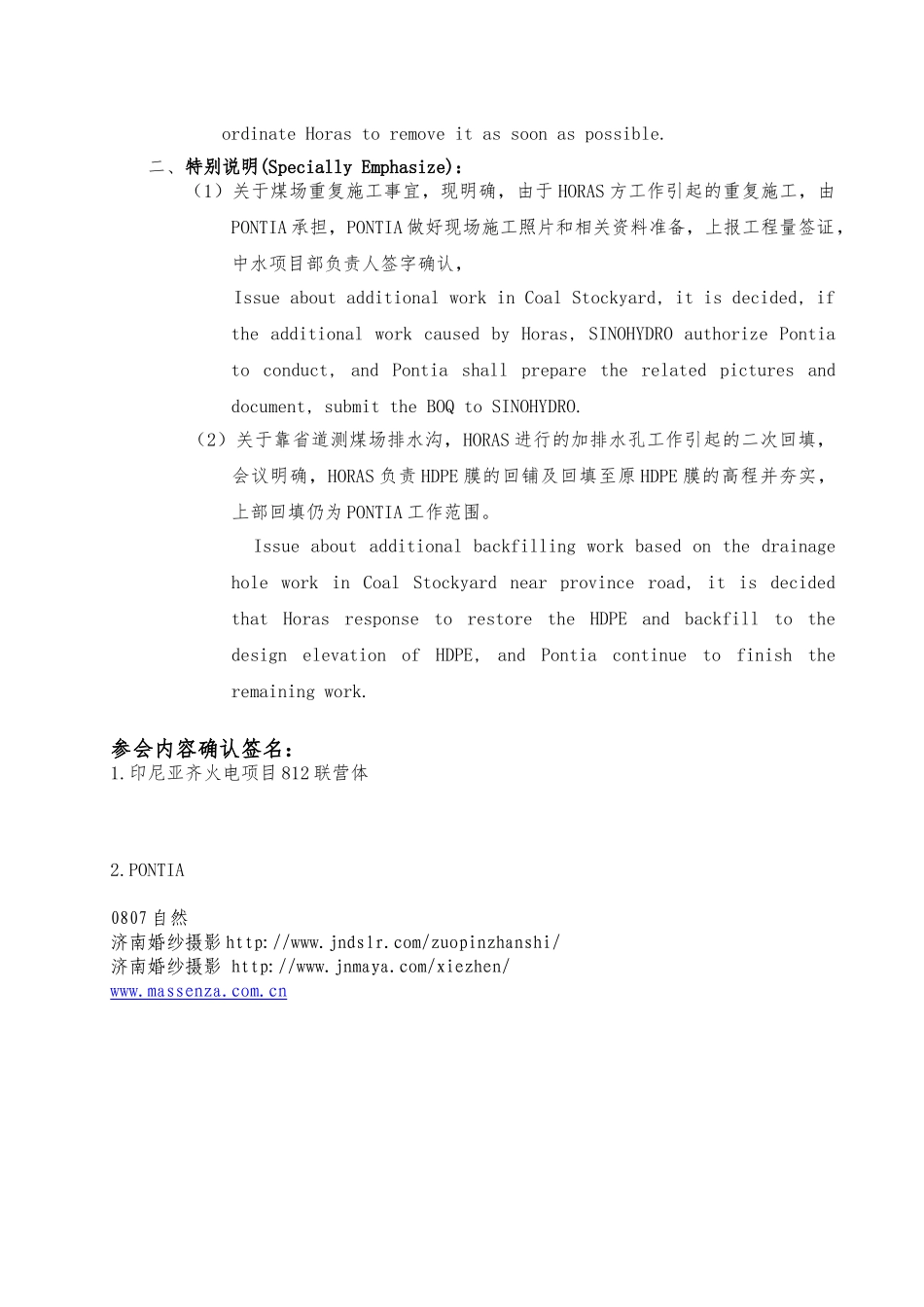

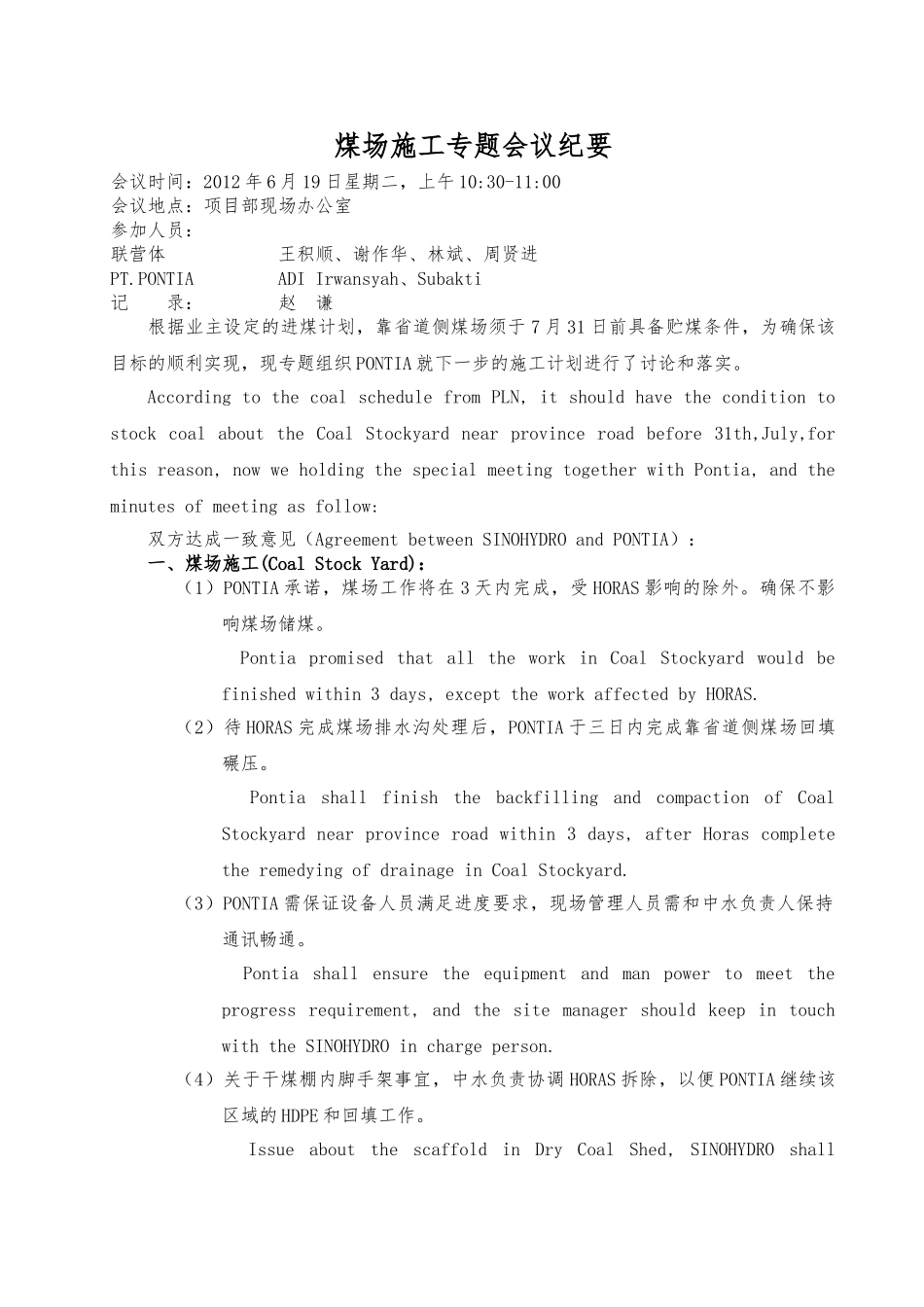

煤场施工专题会议纪要会议时间:2012 年 6 月 19 日星期二,上午 10:30-11:00会议地点:项目部现场办公室参加人员:联营体 王积顺、谢作华、林斌、周贤进PT
PONTIA ADI Irwansyah、Subakti记 录: 赵 谦根据业主设定的进煤计划,靠省道侧煤场须于 7 月 31 日前具备贮煤条件,为确保该目标的顺利实现,现专题组织 PONTIA 就下一步的施工计划进行了讨论和落实
According to the coal schedule from PLN, it should have the condition to stock coal about the Coal Stockyard near province road before 31th,July,for this reason, now we holding the special meeting together with Pontia, and the minutes of meeting as follow: 双方达成一致意见(Agreement between SINOHYDRO and PONTIA):一、煤场施工(Coal Stock Yard):(1)PONTIA 承诺,煤场工作将在 3 天内完成,受 HORAS 影响的除外
确保不影响煤场储煤
Pontia promised that all the work in Coal Stockyard would be finished within 3 days, except the work affected by HORAS
(2)待 HORAS 完成煤场排水沟处理后,PONTIA 于三日内完成靠省道侧煤场回填碾压
Pontia shall finish the backfilling and compactio
