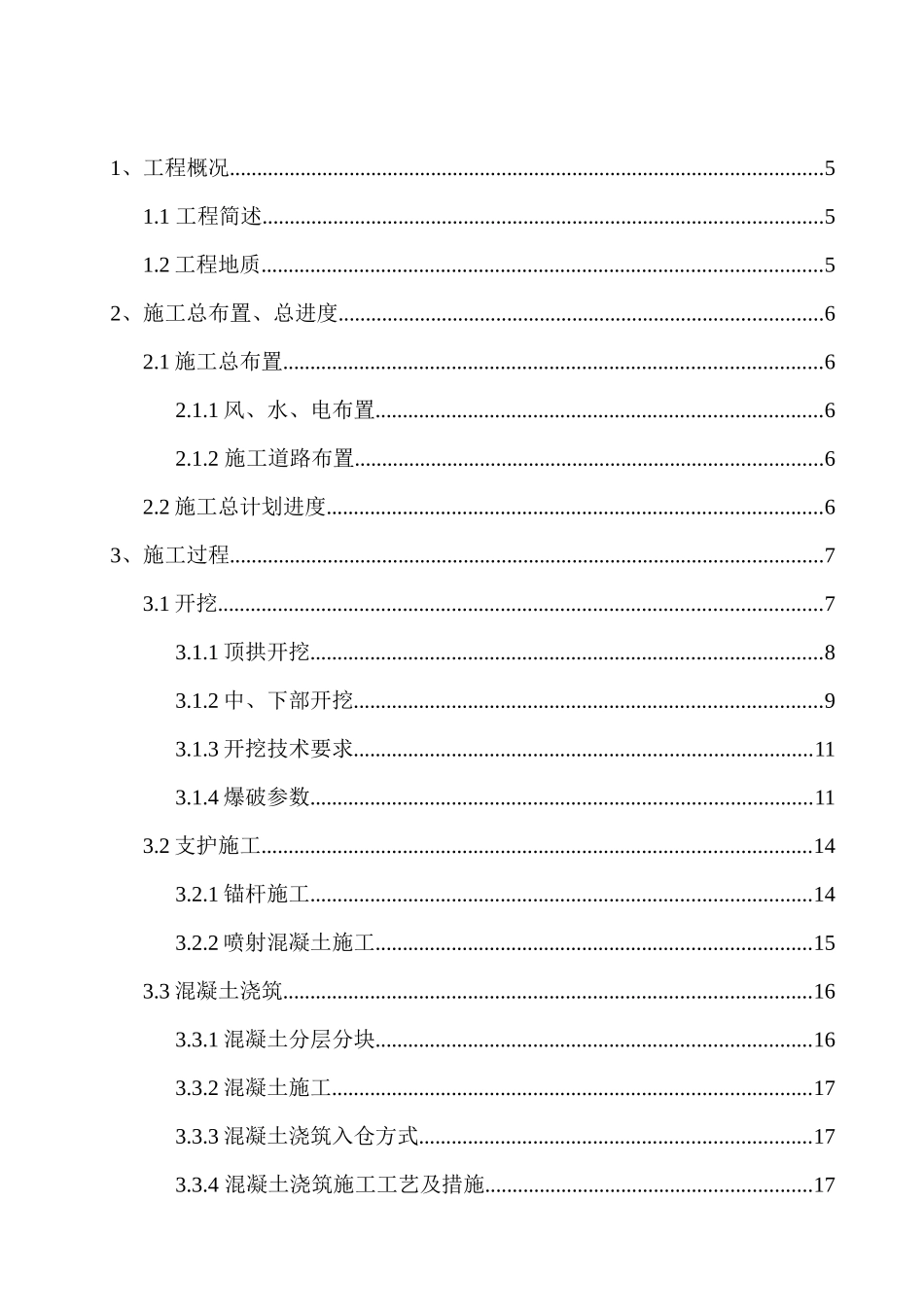

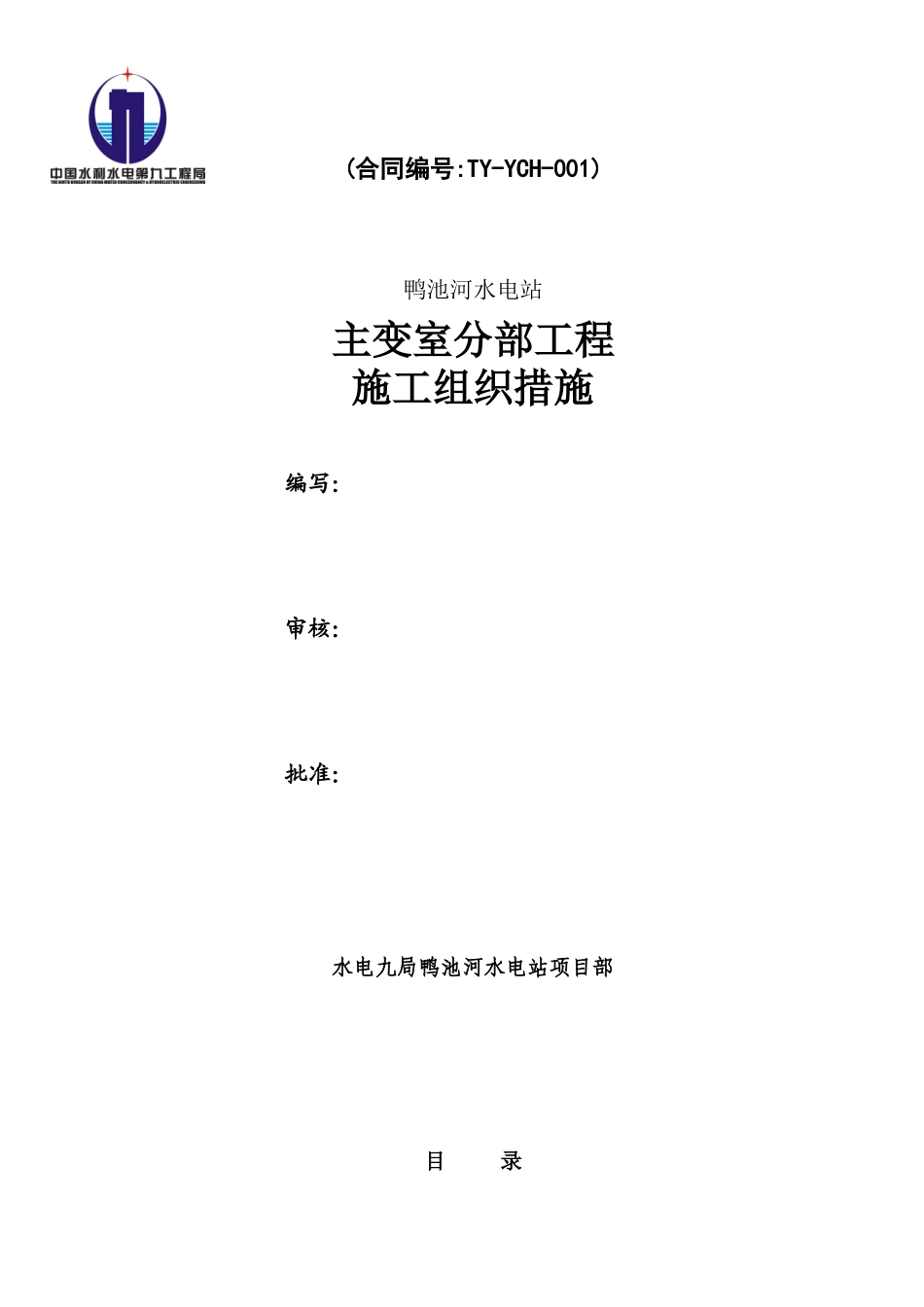

(合同编号:TY-YCH-001)鸭池河水电站主变室分部工程施工组织措施编写:审核:批准:水电九局鸭池河水电站项目部目录1、工程概况.............................................................................................................51.1工程简述.......................................................................................................51.2工程地质.......................................................................................................52、施工总布置、总进度.........................................................................................62.1施工总布置...................................................................................................62.1.1风、水、电布置..................................................................................62.1.2施工道路布置......................................................................................62.2施工总计划进度...........................................................................................63、施工过程.............................................................................................................73.1开挖...............................................................................................................73.1.1顶拱开挖..............................................................................................83.1.2中、下部开挖......................................................................................93.1.3开挖技术要求....................................................................................113.1.4爆破参数............................................................................................113.2支护施工.....................................................................................................143.2.1锚杆施工............................................................................................143.2.2喷射混凝土施工................................................................................153.3混凝土浇筑.................................................................................................163.3.1混凝土分层分块................................................................................163.3.2混凝土施工........................................................................................173.3.3混凝土浇筑入仓方式........................................................................173.3.4混凝土浇筑施工工艺及措施............................................................173.3.5混凝土施工资源配置........................................................................204、施工质量...............................................................................................224.1工程施工质量管理制度.......................................................................224.1.1施工质量保证体系............................................................................224.1.2施工质量检查制度............................................................................234.2施工质量控制.......................................................................................244.3开挖质量控制.......................................................................................244.4支护质量保证措施...............................................................................244.5混凝土质量控制......................
