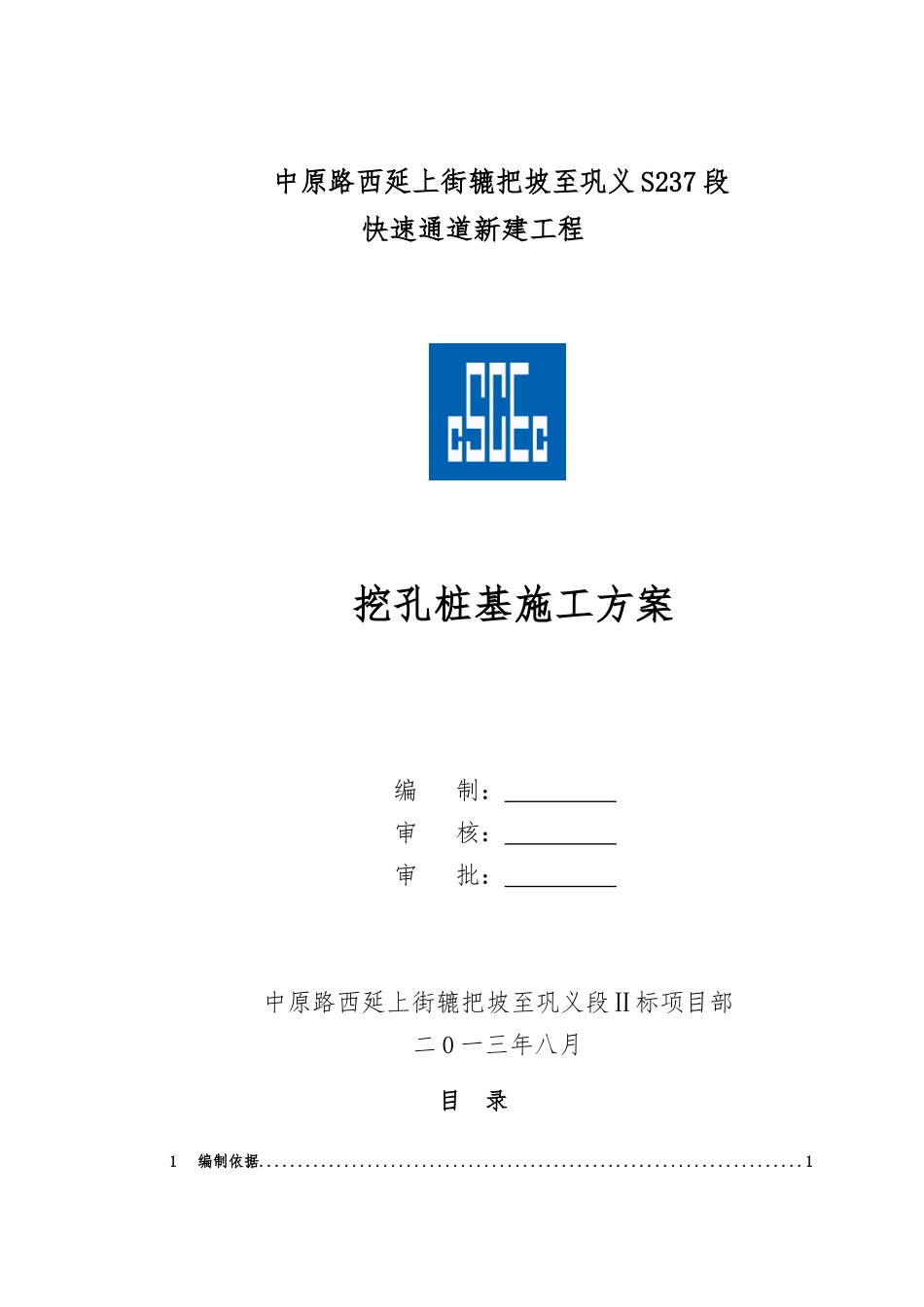

中原路西延上街辘把坡至巩义S237段快速通道新建工程挖孔桩基施工方案编制:审核:审批:中原路西延上街辘把坡至巩义段Ⅱ标项目部二0一三年八月目录1编制依据......................................................................12编制范围......................................................................13工程概况......................................................................13.1地形、地貌..............................................................23.2气候、水文条件..........................................................34施工组织......................................................................44.1现场准备................................................................44.2机械设备准备............................................................44.3劳动力准备..............................................................55施工方法......................................................................65.1施工工艺流程............................................................65.2施工准备................................................................65.3开挖....................................................................85.4排水...................................................................165.5护壁...................................................................165.6人工挖孔控制方法要点...................................................195.7钢筋笼制作及安装.......................................................215.8桩身砼浇筑.............................................................255.9基桩检测...............................................................276施工质量保证措施.............................................................276.1质量管理...............................................................276.2成品保护...............................................................306.3应注意的质量问题.......................................................307安全生产措施.................................................................317.1安全生产组织机构.......................................................317.2安全培训教育保证.......................................................327.3安全生产制度...........................................................337.4安全制度保证...........................................................357.5安全保证措施...........................................................368环境管理.....................................................................389应急预案.....................................................................3910其它保证措施..............................................................4010.1冬季施工措施...........................................................4010.2雨季施工措施...........................................................40人工挖孔桩施工方案1编制依据根据该工程的工程特点、现场情况和当地的水文、地质条件和施工环境条件,针对工程的重难点,以工程工期、质量、安全及文明施工为目标编写的。主要编制依据有:1)本工程地勘报告、设计图纸、文件。2)对施工现场的实地调查情况。3)《公路桥涵施工技术规范》(JTGTF50-2011)4)《钢筋焊接及验收规程》(JGJ18-2003)5)《公路工程技术标准》(JTGB01-2003)6)《公路钢筋混凝土及预应力混凝土桥涵设计规范》(JTGD62-2004)2编制范围中原路西延上街辘把坡至巩义S237段快速通道新建工程第Ⅱ合同段内上跨七大路高架桥桩基施工。3工程概况3.1工程简介本项目路线起点位于上街区峡窝镇辘...
