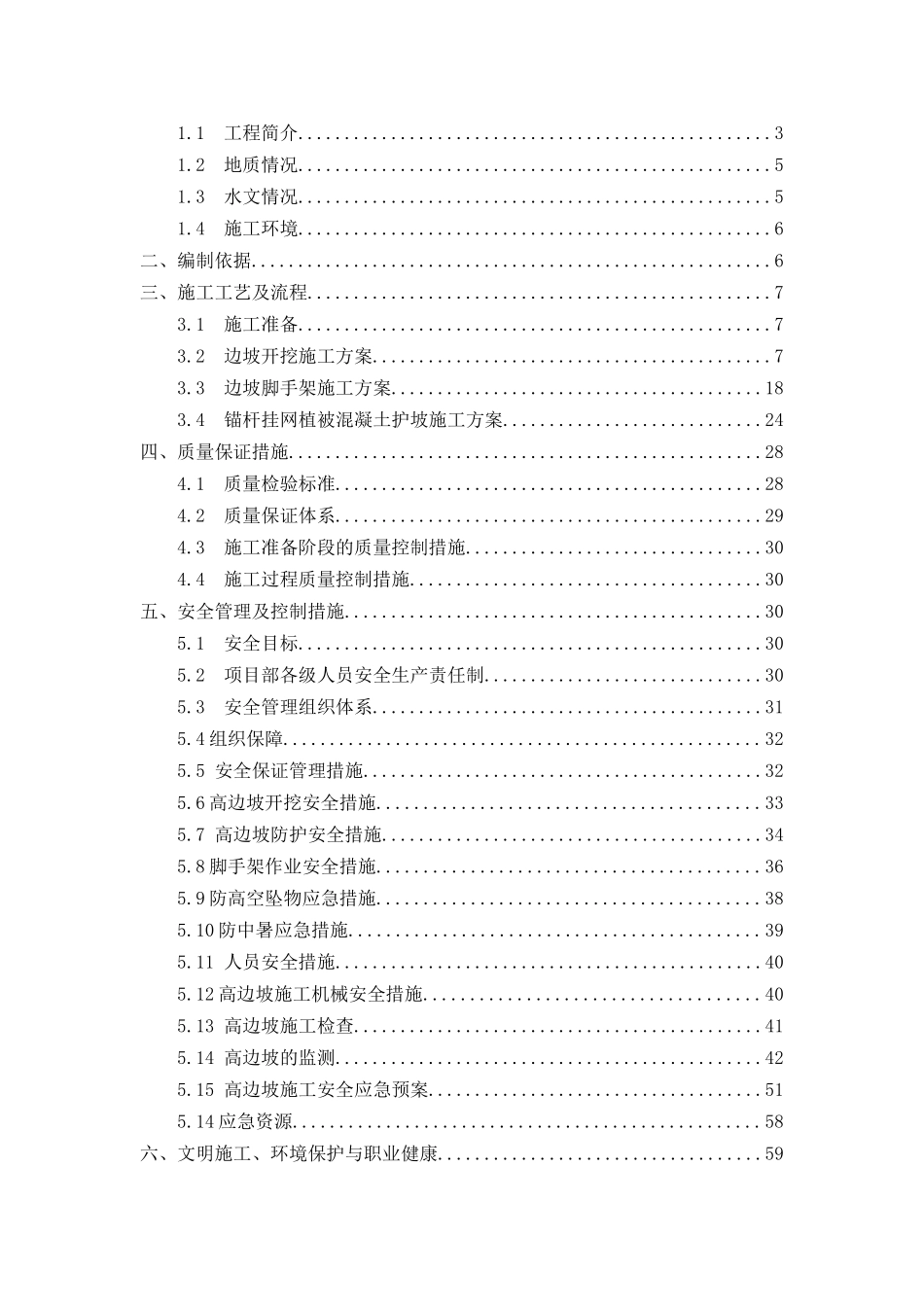

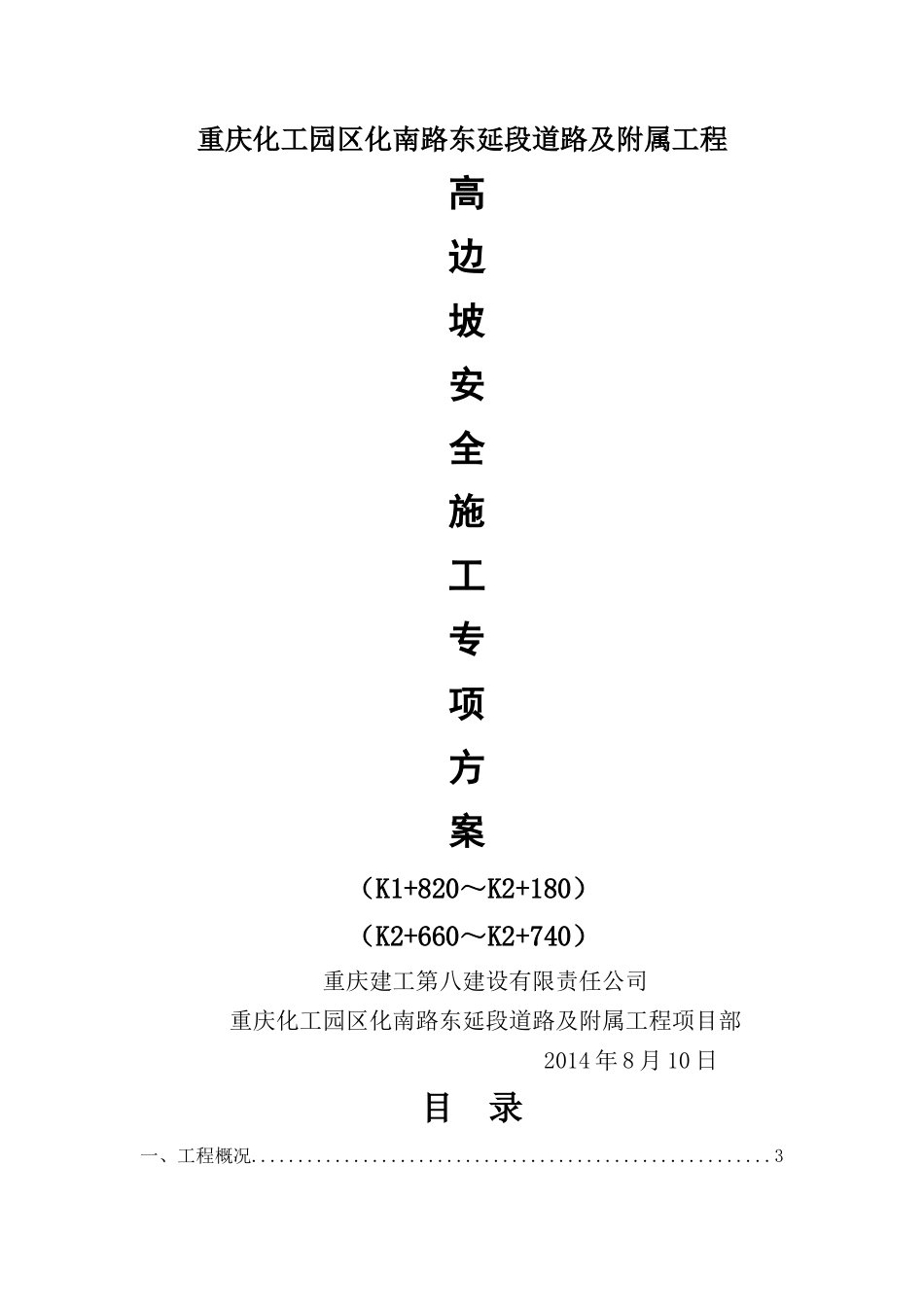

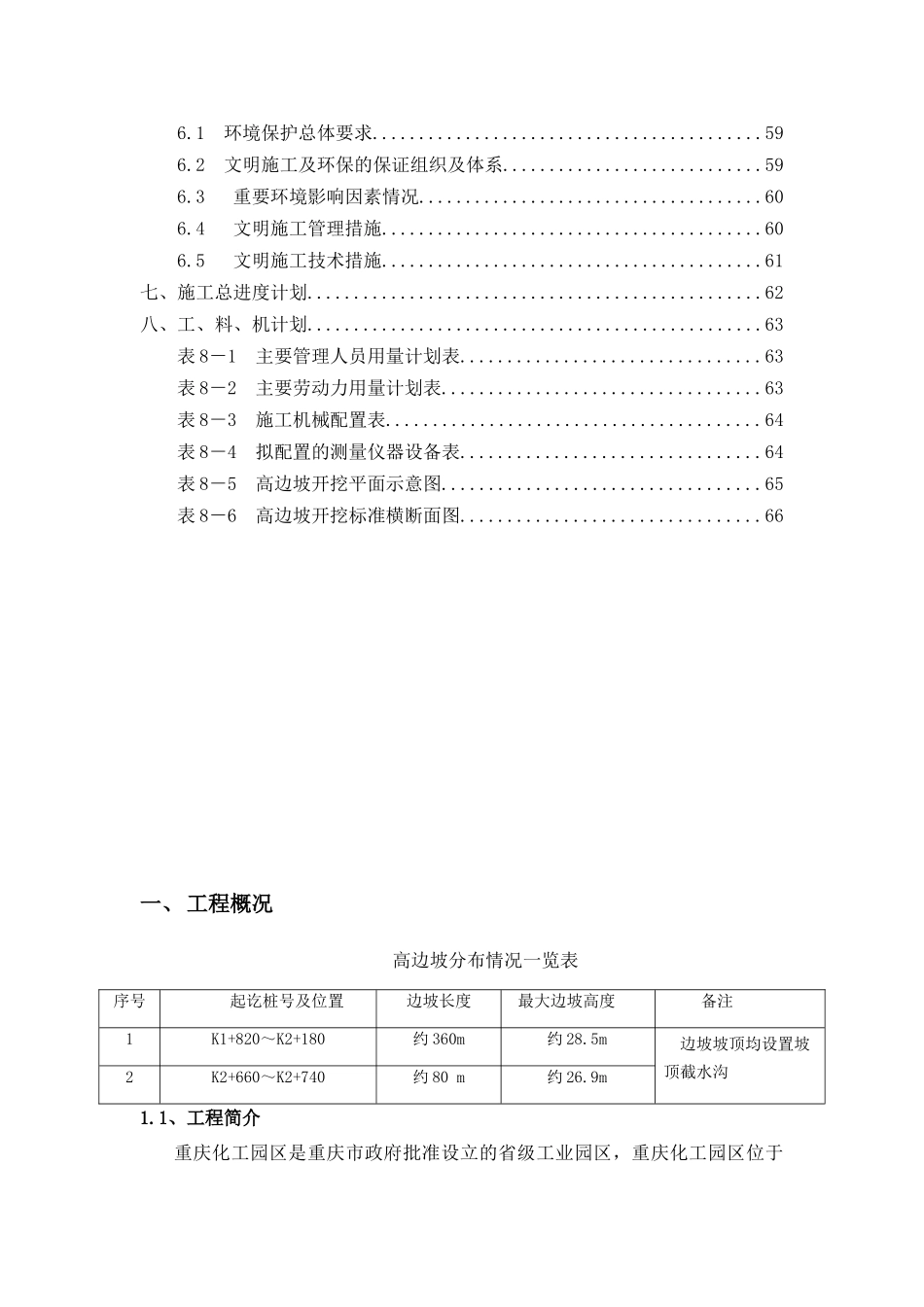

重庆化工园区化南路东延段道路及附属工程高边坡安全施工专项方案(K1+820~K2+180)(K2+660~K2+740)重庆建工第八建设有限责任公司重庆化工园区化南路东延段道路及附属工程项目部2014年8月10日目录一、工程概况........................................................31.1工程简介...................................................31.2地质情况...................................................51.3水文情况...................................................51.4施工环境...................................................6二、编制依据........................................................6三、施工工艺及流程..................................................73.1施工准备...................................................73.2边坡开挖施工方案...........................................73.3边坡脚手架施工方案........................................183.4锚杆挂网植被混凝土护坡施工方案............................24四、质量保证措施...................................................284.1质量检验标准..............................................284.2质量保证体系..............................................294.3施工准备阶段的质量控制措施................................304.4施工过程质量控制措施......................................30五、安全管理及控制措施.............................................305.1安全目标..................................................305.2项目部各级人员安全生产责任制..............................305.3安全管理组织体系..........................................315.4组织保障...................................................325.5安全保证管理措施...........................................325.6高边坡开挖安全措施.........................................335.7高边坡防护安全措施.........................................345.8脚手架作业安全措施.........................................365.9防高空坠物应急措施.........................................385.10防中暑应急措施............................................395.11人员安全措施..............................................405.12高边坡施工机械安全措施....................................405.13高边坡施工检查............................................415.14高边坡的监测..............................................425.15高边坡施工安全应急预案....................................515.14应急资源..................................................58六、文明施工、环境保护与职业健康...................................596.1环境保护总体要求..........................................596.2文明施工及环保的保证组织及体系............................596.3重要环境影响因素情况.....................................606.4文明施工管理措施.........................................606.5文明施工技术措施.........................................61七、施工总进度计划.................................................62八、工、料、机计划.................................................63表8-1主要管理人员用量计划表................................63表8-2主要劳动力用量计划表..................................63表8-3施工机械配置表........................................64表8-4拟配置的测量仪器设备表................................64表8-5高边坡开挖平面示意图..................................65表8-6高边坡开挖标准横断面图................................66一、工程概况高边坡分布情况一览表序号起讫桩号及位置边坡长度最大边坡高度备注1K1+820~K2+180约360m约28.5m边坡坡顶均设置坡顶截水沟2K2+66...
