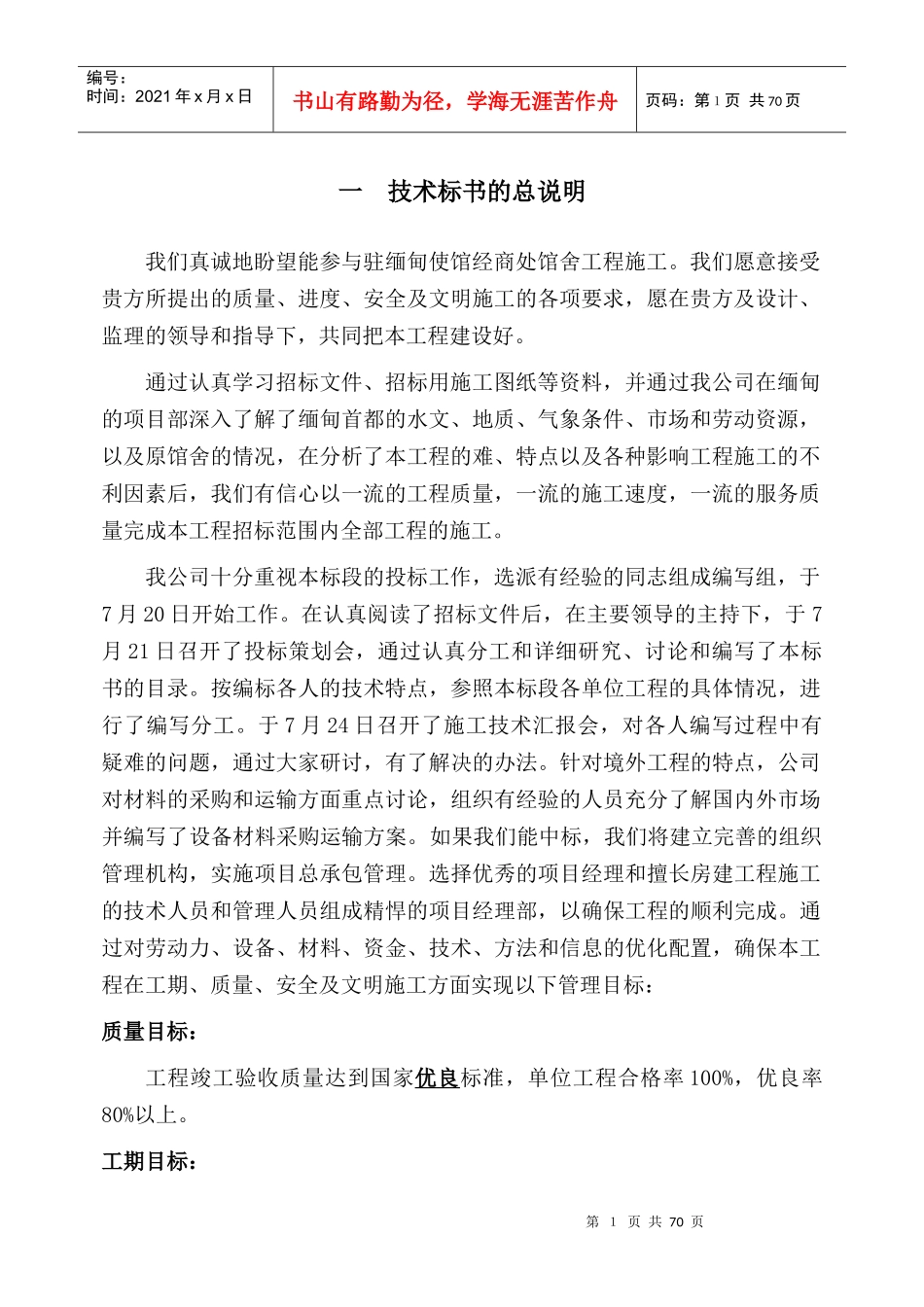

中国驻缅甸使馆经商处馆舍工程技术标投标书(技术标)目录一技术标书的总说明··························1二施工组织设计····························31工程概况································31.1投标工程内容····························31.2编制依据······························32施工准备计划·····························53施工总体平面布置及临设工程····················73.1施工总体平面布置·························73.2临设工程······························74施工组织管理机构及施工总体布署·················94.1施工组织管理机构·························94.2施工总体布署····························104.3单位工程的划分及施工工区的划分················104.4施工总体流程····························114.5施工测量······························124.6土方开挖······························144.7混凝土拌制·····························155施工进度计划及进度控制措施····················185.1施工总进度计划··························185.2施工进度计划编制说明······················185.3施工进度计划控制措施······················186单位工程主要分部分项工程施工技术方案·············196.1基础工程······························196.2上部结构工程····························226.3装饰工程······························376.4电气工程······························476.5给排水工程·····························566.6通风与空调工程··························667主要施工机械、劳动力使用计划··················777.1主要施工机械使用计划······················777.2劳动力使用计划··························78三保证工程质量、安全及文明施工的技术措施···········801质量管理机构及质量保证措施····················801.1质量保证体系····························801.2分部工程质量保证措施·················811.3质量创优目标、目标及计划····················842季节性施工措施····························852.1雨天施工措施····························852.2夏季施工措施····························863安全及文明施工的技术措施·····················87四项目经理部管理体系及主要管理人员简历·············911中国驻缅甸使馆经商处馆舍工程技术标五附录··································92附录一:施工准备计划表附录二:施工总进度计划附录三:总平面布置图附录四:施工分区图附录五:办公楼基础挖土布置及流向图附录六:办公楼主体工程施工流向图2第1页共70页编号:时间:2021年x月x日书山有路勤为径,学海无涯苦作舟页码:第1页共70页一技术标书的总说明我们真诚地盼望能参与驻缅甸使馆...
