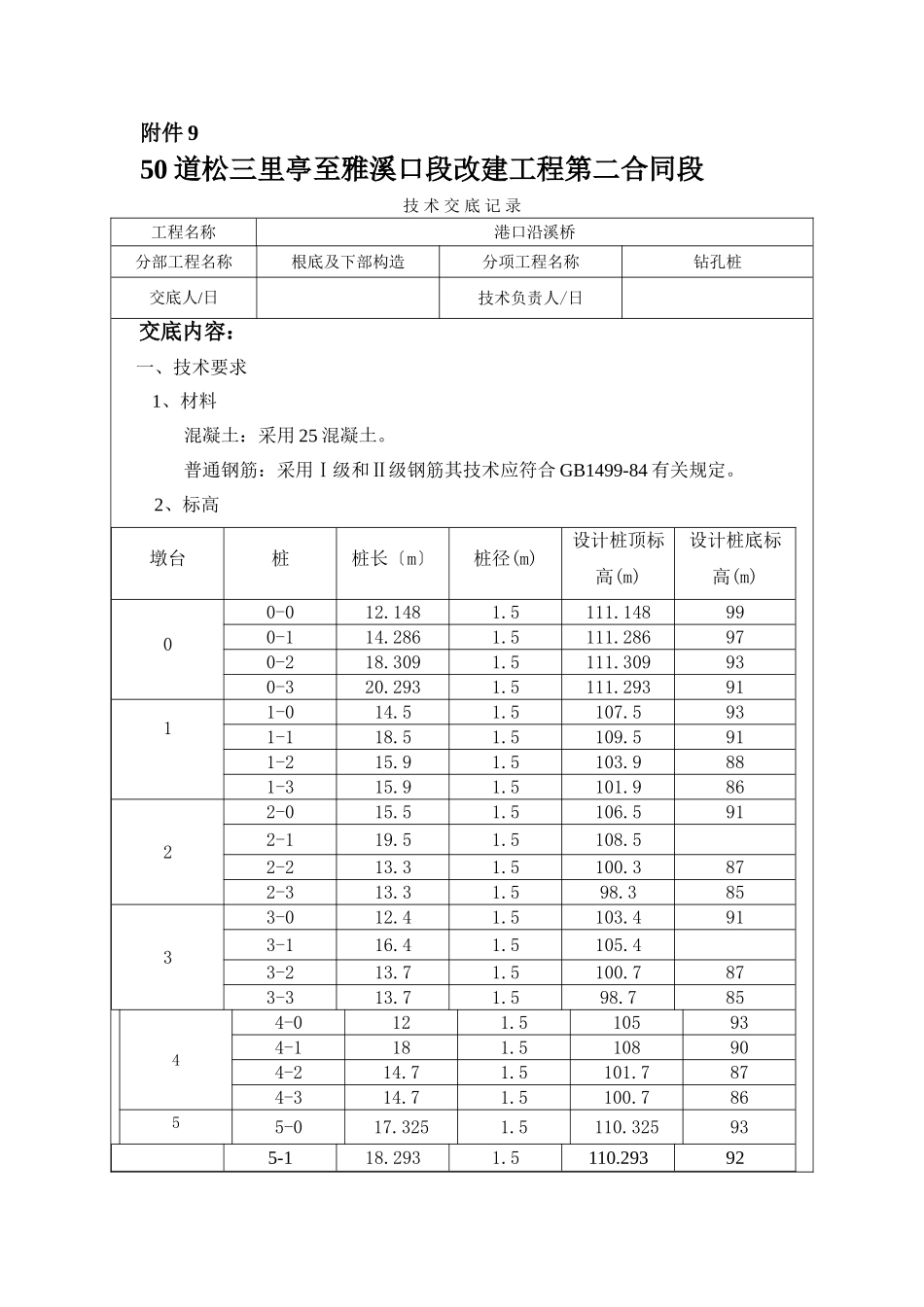

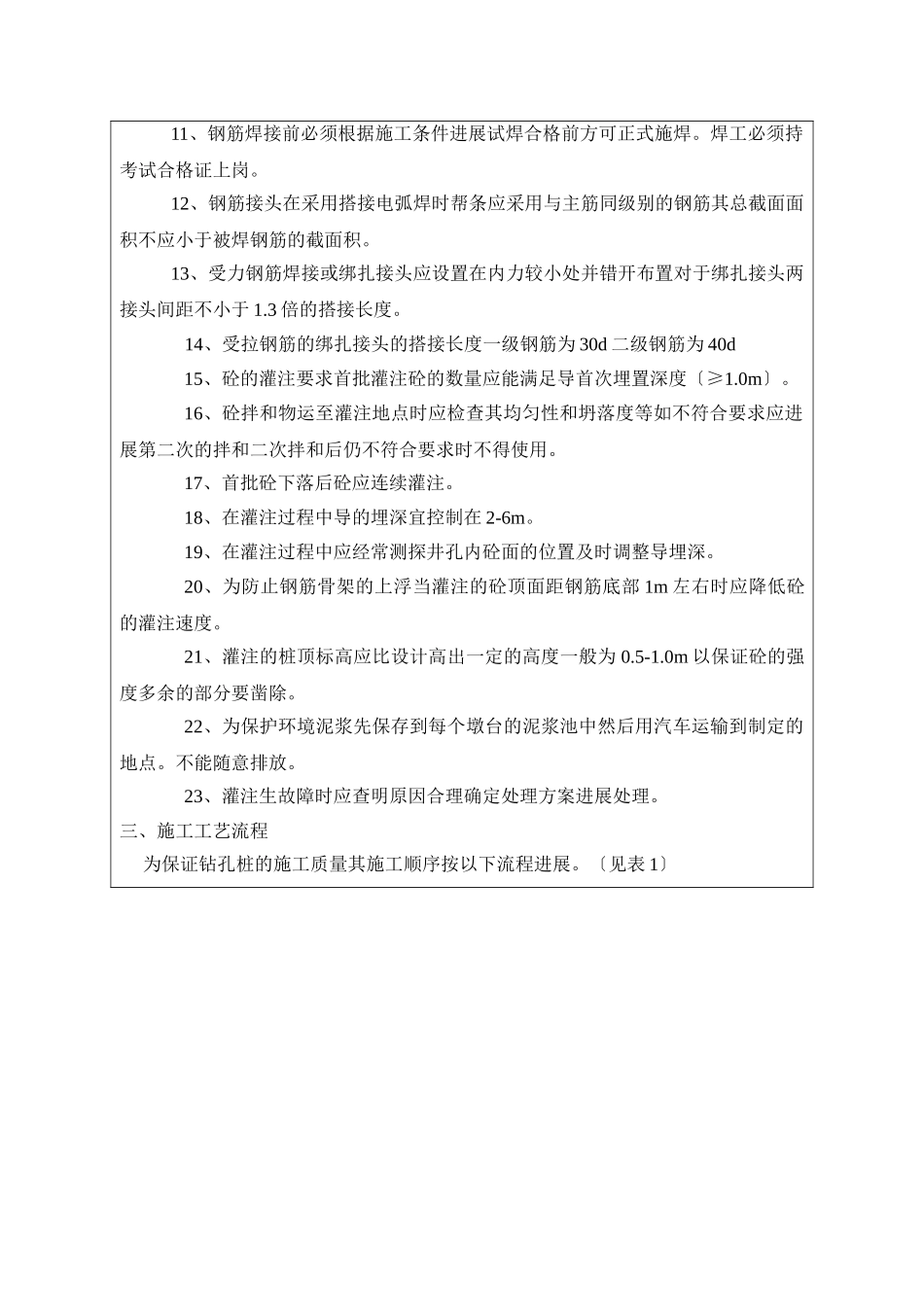

附件950道松三里亭至雅溪口段改建工程第二合同段技术交底记录工程名称港口沿溪桥分部工程名称根底及下部构造分项工程名称钻孔桩交底人/日技术负责人/日交底内容:一、技术要求1、材料混凝土:采用25混凝土。普通钢筋:采用Ⅰ级和Ⅱ级钢筋其技术应符合GB1499-84有关规定。2、标高墩台桩桩长〔m〕桩径(m)设计桩顶标高(m)设计桩底标高(m)00-012.1481.5111.148990-114.2861.5111.286970-218.3091.5111.309930-320.2931.5111.2939111-014.51.5107.5931-118.51.5109.5911-215.91.5103.9881-315.91.5101.98622-015.51.5106.5912-119.51.5108.52-213.31.5100.3872-313.31.598.38533-012.41.5103.4913-116.41.5105.43-213.71.5100.7873-313.71.598.78544-0121.5105934-1181.5108904-214.71.5101.7874-314.71.5100.78655-017.3251.5110.325935-118.2931.5110.293925-216.51.5106.5905-316.51.5105.566-214.51.5108.5946-314.51.5106.59277-216.71.5107.7917-316.71.5105.788-215.11.5104.18-315.11.5100.18599-214.71.5105.7919-314.71.5101.7871010-215.11.5106.19110-315.11.5103.1881111-2151.51079211-3151.5102871212-215.61.5104.612-315.61.5101.6861313-215.51.5103.58813-315.51.5100.5851414-214.51.5100.58614-314.51.598.5841515-214.31.5100.38615-314.31.598.3841616-214.11.5101.18716-314.11.599.1851717-216.5611.5108.5619217-318.2851.5108.28590二、施工技术要求1、孔深比设计深度超深不小于50mm。2、沉淀厚度不大于设计规定。3、孔径不小于设计桩径。4、孔的中心位置允许偏向为50mm。5、孔的倾斜度允许偏向为小于1。6、围堰施工按照芹江大桥施工方案中的进展。7、围堰的强度应满足行车的要求。8、钢筋的外表应干净使用前应将外表油渍、漆皮、鳞锈等去除干净。9、钢筋应平直无部分弯折成盘的钢筋和弯曲的钢筋均应调直。10钢筋的焊接单面焊时为10d当为双面焊时为5d。11、钢筋焊接前必须根据施工条件进展试焊合格前方可正式施焊。焊工必须持考试合格证上岗。12、钢筋接头在采用搭接电弧焊时帮条应采用与主筋同级别的钢筋其总截面面积不应小于被焊钢筋的截面积。13、受力钢筋焊接或绑扎接头应设置在内力较小处并错开布置对于绑扎接头两接头间距不小于1.3倍的搭接长度。14、受拉钢筋的绑扎接头的搭接长度一级钢筋为30d二级钢筋为40d15、砼的灌注要求首批灌注砼的数量应能满足导首次埋置深度〔≥1.0m〕。16、砼拌和物运至灌注地点时应检查其均匀性和坍落度等如不符合要求应进展第二次的拌和二次拌和后仍不符合要求时不得使用。17、首批砼下落后砼应连续灌注。18、在灌注过程中导的埋深宜控制在2-6m。19、在灌注过程中应经常测探井孔内砼面的位置及时调整导埋深。20、为防止钢筋骨架的上浮当灌注的砼顶面距钢筋底部1m左右时应降低砼的灌注速度。21、灌注的桩顶标高应比设计高出一定的高度一般为0.5-1.0m以保证砼的强度多余的部分要凿除。22、为保护环境泥浆先保存到每个墩台的泥浆池中然后用汽车运输到制定的地点。不能随意排放。23、灌注生故障时应查明原因合理确定处理方案进展处理。三、施工工艺流程为保证钻孔桩的施工质量其施工顺序按以下流程进展。〔见表1〕图一钻孔灌注桩工序流程四、详细的专项平安措施〔见后面专项平安措施〕测量复核桩位钻机就位粘土造浆做好钻孔记录钻进成孔检验孔深、孔径气举式反循环清孔钢筋笼加工制作、检查、运输吊装钢筋笼检验导等设备接装导和砼料斗砼运输车运输砼或泵送砼灌注砼撤除导钻机移位测量放样施工前提围堰筑岛承受交底人签名
