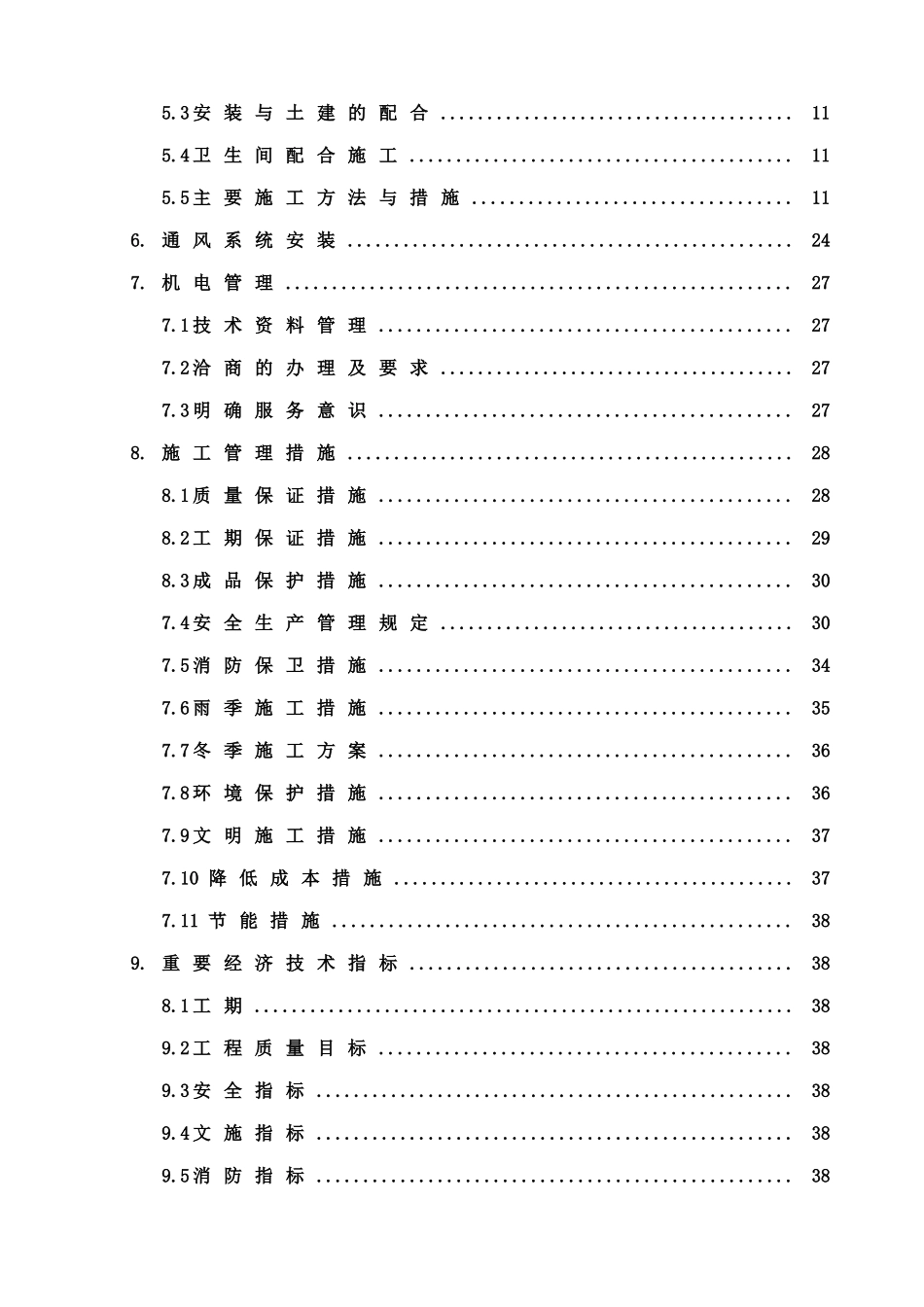

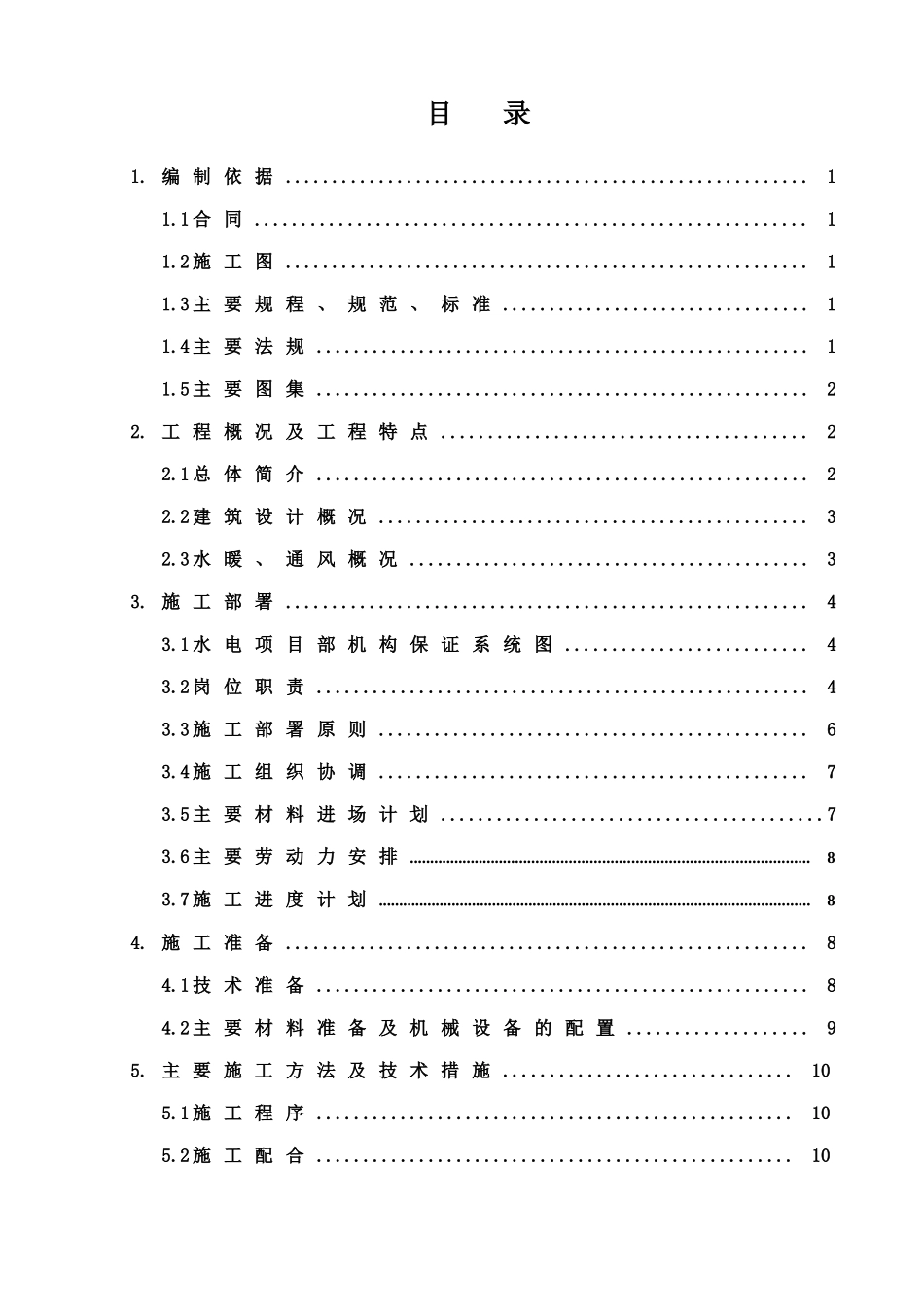

1号研发试验楼等10项工程给排水施工方案北京六建集团有限责任公司2012年4月目录1.编制依据........................................................11.1合同...........................................................11.2施工图........................................................11.3主要规程、规范、标准.................................11.4主要法规.....................................................11.5主要图集.....................................................22.工程概况及工程特点.......................................22.1总体简介.....................................................22.2建筑设计概况..............................................32.3水暖、通风概况...........................................33.施工部署........................................................43.1水电项目部机构保证系统图..........................43.2岗位职责.....................................................43.3施工部署原则..............................................63.4施工组织协调..............................................73.5主要材料进场计划.........................................73.6主要劳动力安排.................................................................................................83.7施工进度计划.........................................................................................................84.施工准备........................................................84.1技术准备.....................................................84.2主要材料准备及机械设备的配置...................95.主要施工方法及技术措施...............................105.1施工程序...................................................105.2施工配合...................................................105.3安装与土建的配合......................................115.4卫生间配合施工.........................................115.5主要施工方法与措施..................................116.通风系统安装................................................247.机电管理......................................................277.1技术资料管理............................................277.2洽商的办理及要求......................................277.3明确服务意识............................................278.施工管理措施................................................288.1质量保证措施............................................288.2工期保证措施............................................298.3成品保护措施............................................307.4安全生产管理规定......................................307.5消防保卫措施............................................347.6雨季施工措施............................................357.7冬季施工方案............................................367.8环境保护措施............................................367.9文明施工措施............................................377.10降低成本措施...........................................377.11节能措施.................................................389.重要经济技术指标.........................................388.1工期..........................................................389.2工程质量目标............................................389.3安全指标...................................................389.4文施指标...................................................389.5消防指标...................................................389.6环保指标...................................
