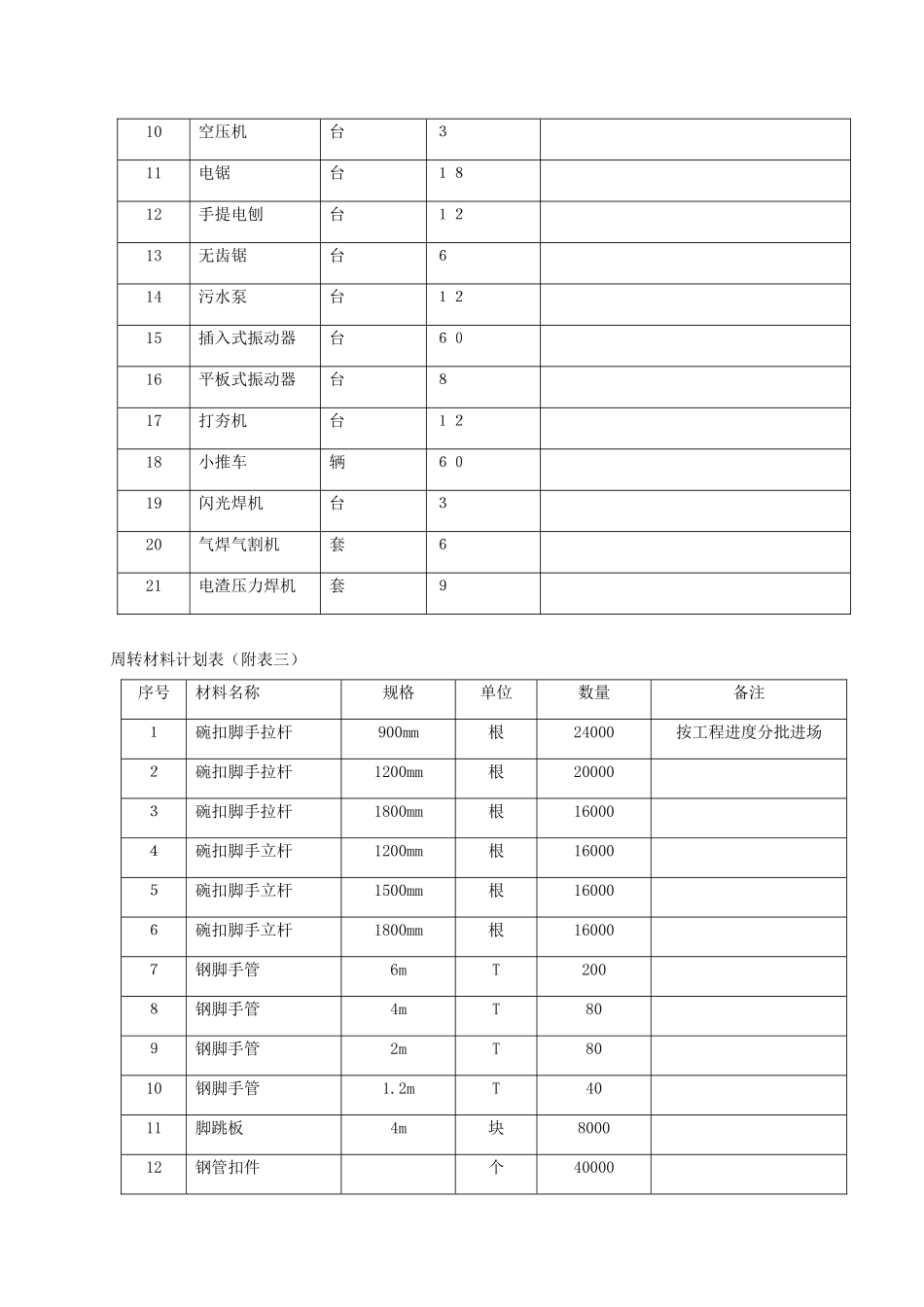

北京城建大厦(基础部分)施工组织设计目 录一、工程概况·································································1二、施工部署·································································1三、施工准备·································································2四、主要分顶工程施工技术措施·················································3五、质量保证措施······························································7六、安全生产保证措施·························································10七、消防保卫措施·····························································12八、现场文明施工管理措施·····················································13九、冬雨季施工措施····························································14十、环、卫管理措施····························································16十一、降低成本措施····························································16十二、保证施工进度计划措施····················································17附表一:项目管理人员名单附表二:主要施工机械计划表附表三:周转材料计划表附表四:北京城建大厦基础施工进度计划表附图一:基础阶段施工现场平面布置图附图二:顶板梁模板支撑示意图附图三:柱模支撑示意图主要机械计划表(附表二)序号名称单位数量备注1塔吊台3回转半径60 m 一台,40 m 二台2地泵台23电...
