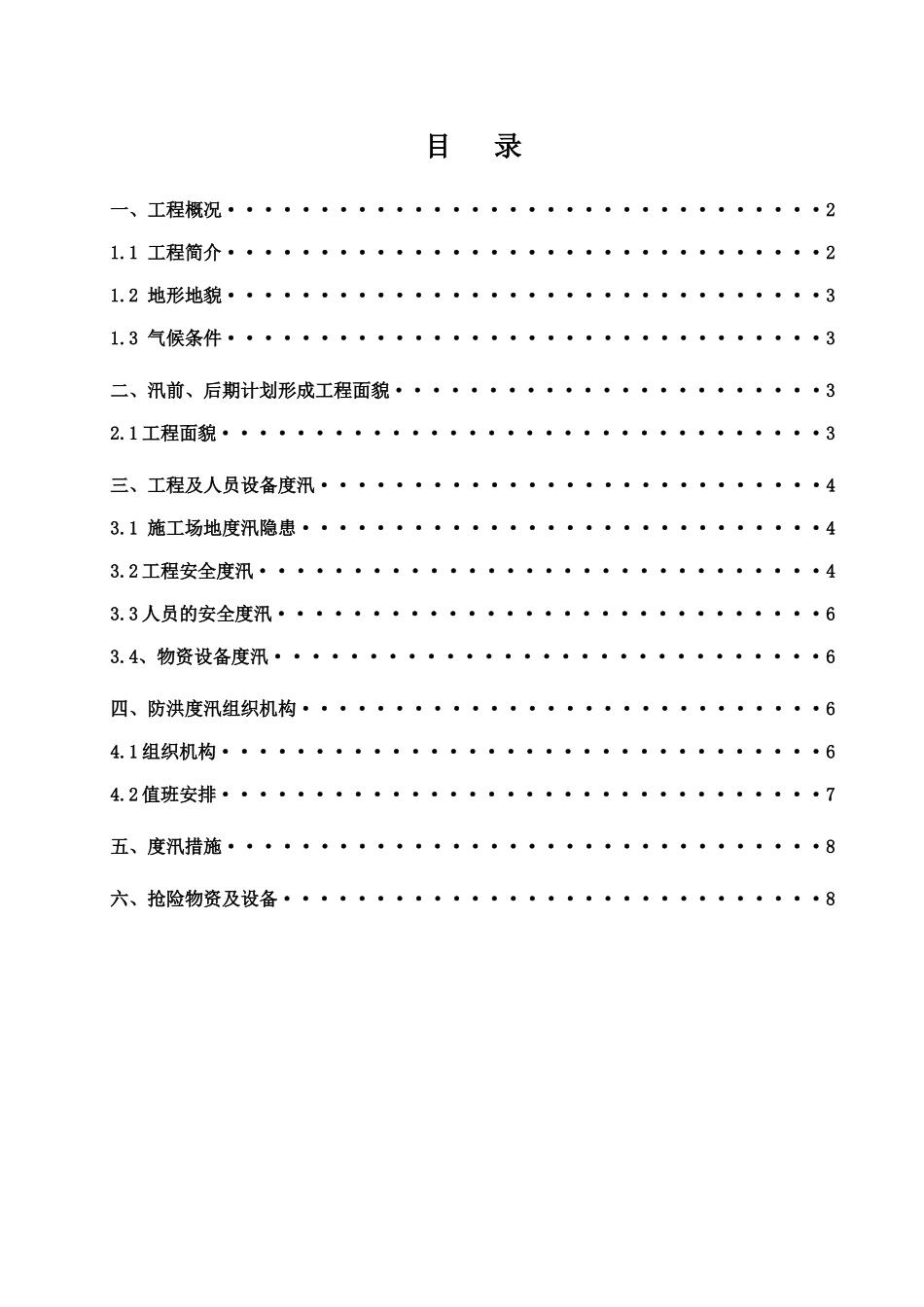

防洪度汛预案编 制: 审 核: 日 期: 目 录一、工程概况································21
1 工程简介································21
2 地形地貌································31
3 气候条件································3二、汛前、后期计划形成工程面貌·······················32
1 工程面貌································3三、工程及人员设备度汛···························43
1 施工场地度汛隐患····························43
2 工程安全度汛······························43
3 人员的安全度汛·····························63
4、物资设备度汛·····························6四、防洪度汛组织机构····························64
1 组织机构································64

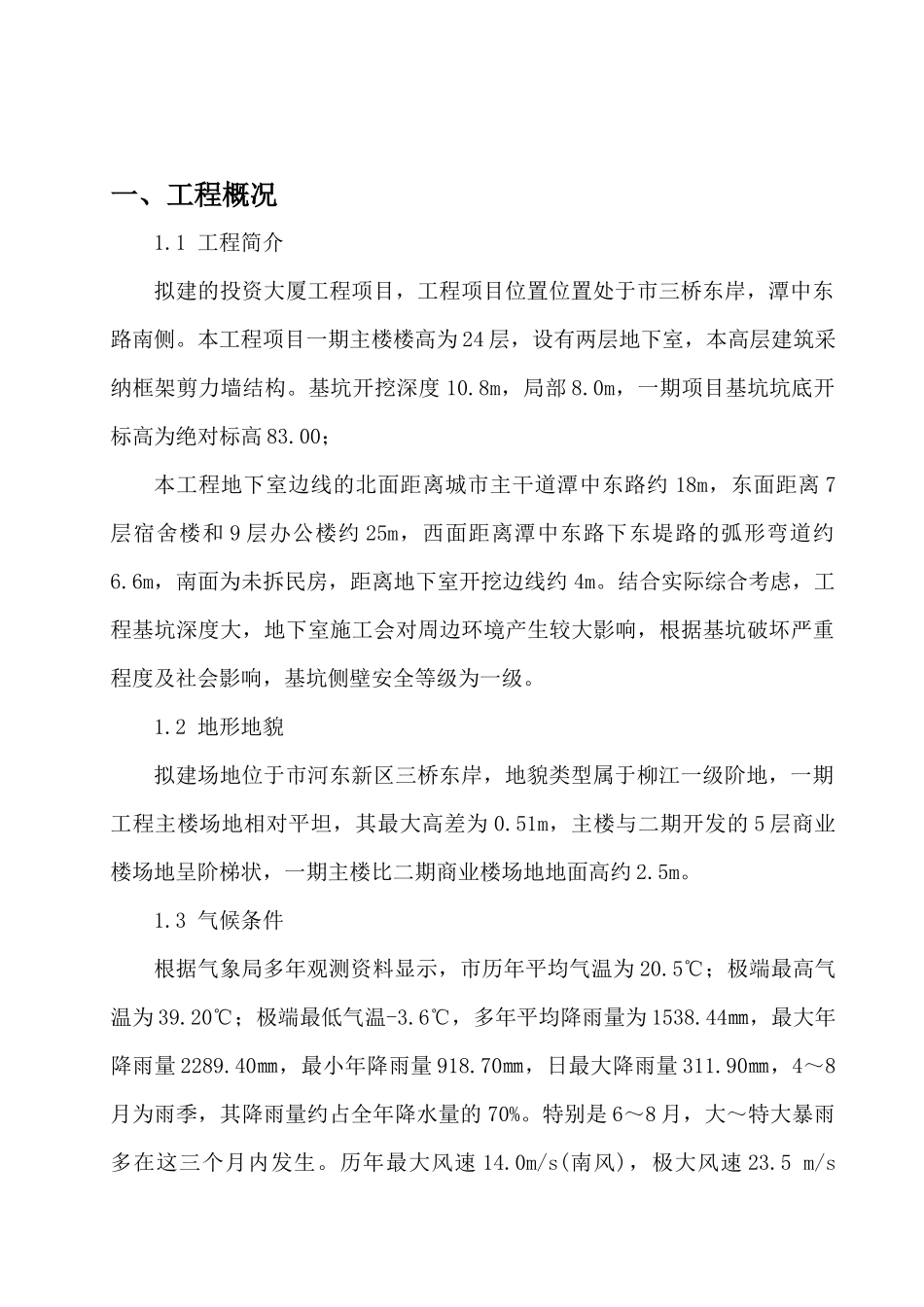

2 值班安排································7五、度汛措施································8六、抢险物资及设备·····························8一、工程概况1
1 工程简介拟建的投资大厦工程项目,工程项目位置位置处于市三桥东岸,潭中东路南侧
本工程项目一期主楼楼高为 24 层,设有两层地下室,本高层建筑采纳框架剪力墙结构
基坑开挖深度 10
8m,局部 8
0m,一期项目基坑坑底开标高为绝对标高 83
