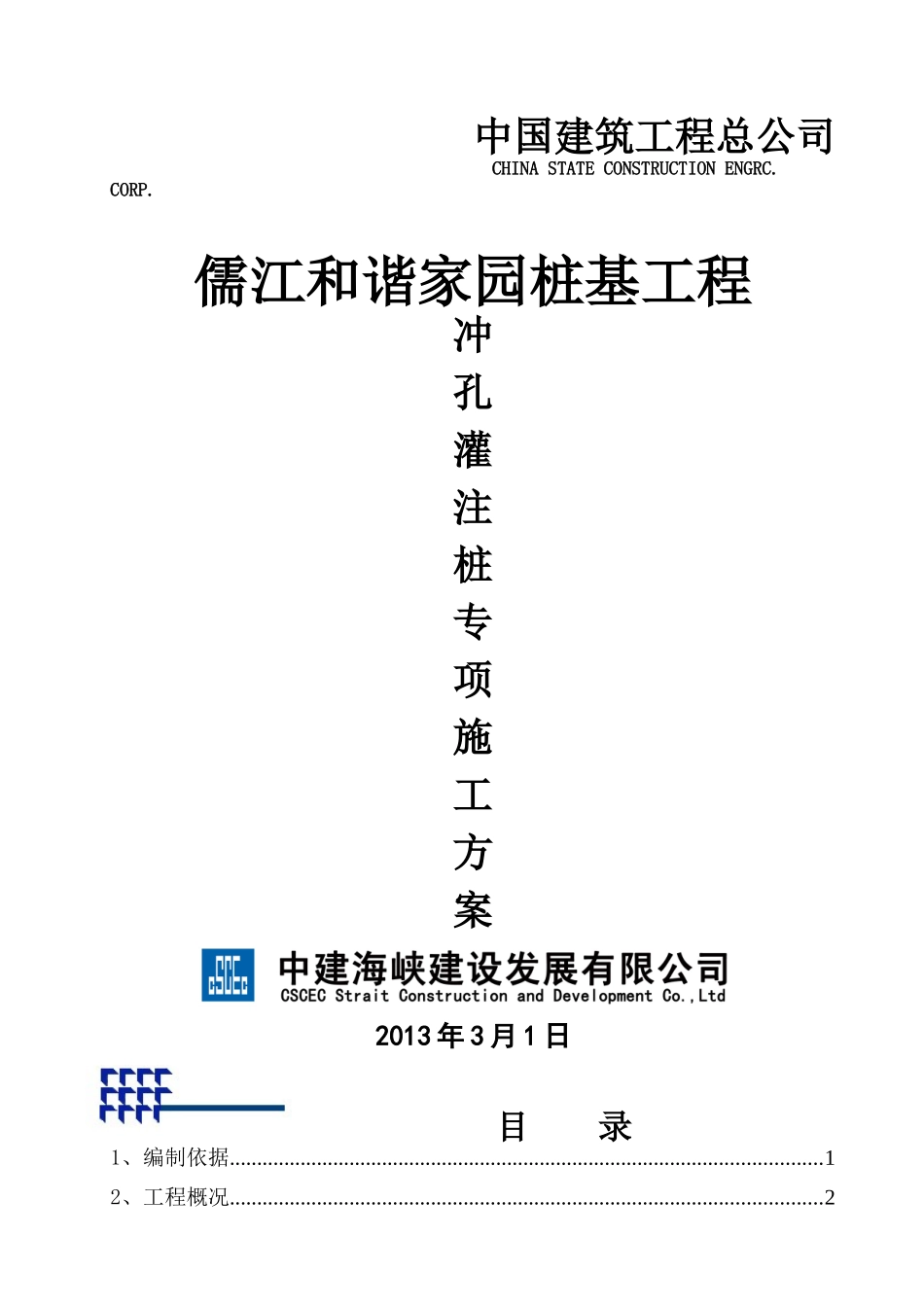

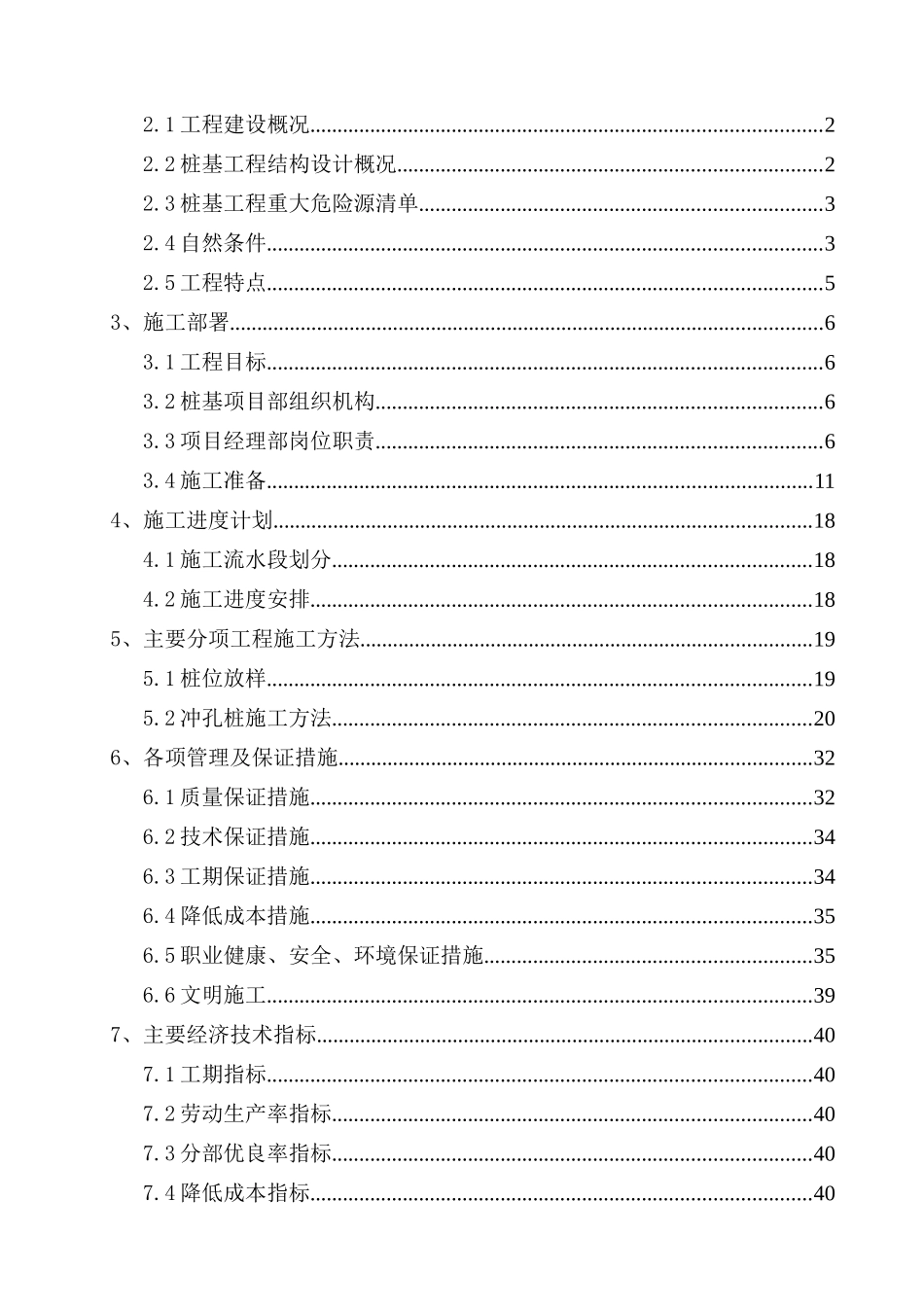

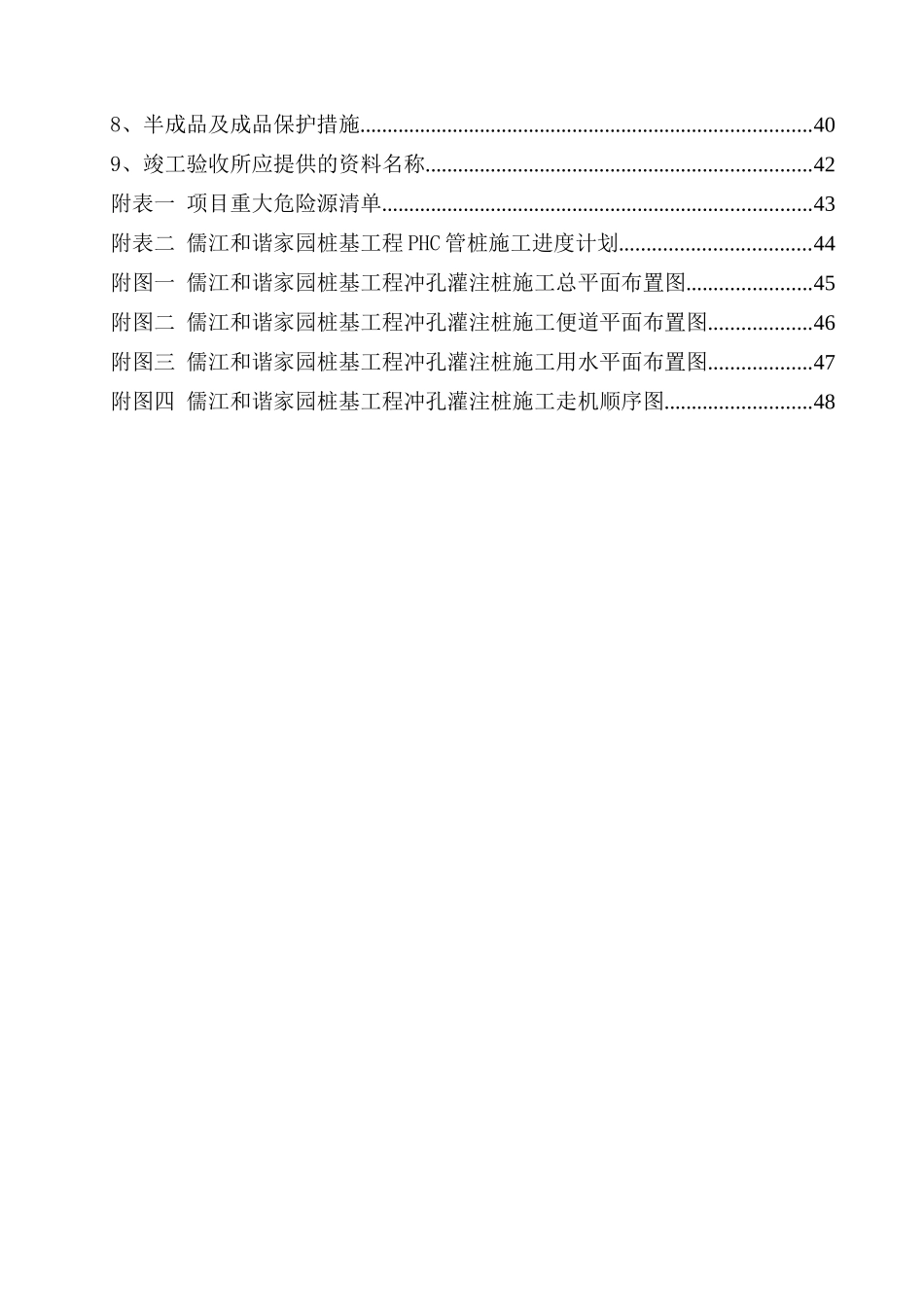

中国建筑工程总公司CHINASTATECONSTRUCTIONENGRC.CORP.儒江和谐家园桩基工程冲孔灌注桩专项施工方案2013年3月1日目录1、编制依据.............................................................................................................12、工程概况.............................................................................................................22.1工程建设概况..............................................................................................22.2桩基工程结构设计概况..............................................................................22.3桩基工程重大危险源清单..........................................................................32.4自然条件......................................................................................................32.5工程特点......................................................................................................53、施工部署.............................................................................................................63.1工程目标......................................................................................................63.2桩基项目部组织机构..................................................................................63.3项目经理部岗位职责..................................................................................63.4施工准备....................................................................................................114、施工进度计划...................................................................................................184.1施工流水段划分........................................................................................184.2施工进度安排............................................................................................185、主要分项工程施工方法...................................................................................195.1桩位放样....................................................................................................195.2冲孔桩施工方法........................................................................................206、各项管理及保证措施.......................................................................................326.1质量保证措施............................................................................................326.2技术保证措施............................................................................................346.3工期保证措施............................................................................................346.4降低成本措施............................................................................................356.5职业健康、安全、环境保证措施............................................................356.6文明施工....................................................................................................397、主要经济技术指标...........................................................................................407.1工期指标....................................................................................................407.2劳动生产率指标........................................................................................407.3分部优良率指标........................................................................................407.4降低成本指标....................
