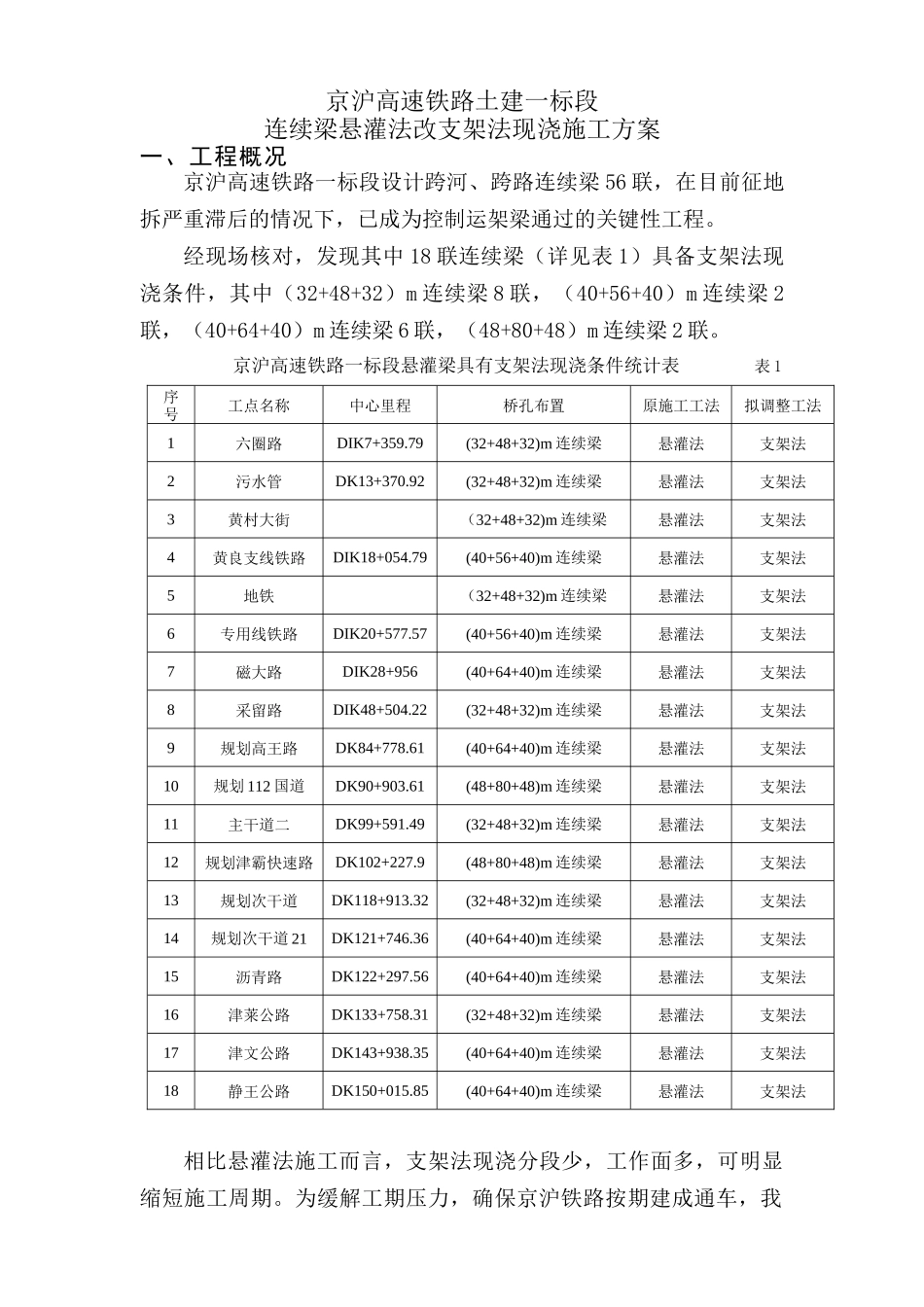

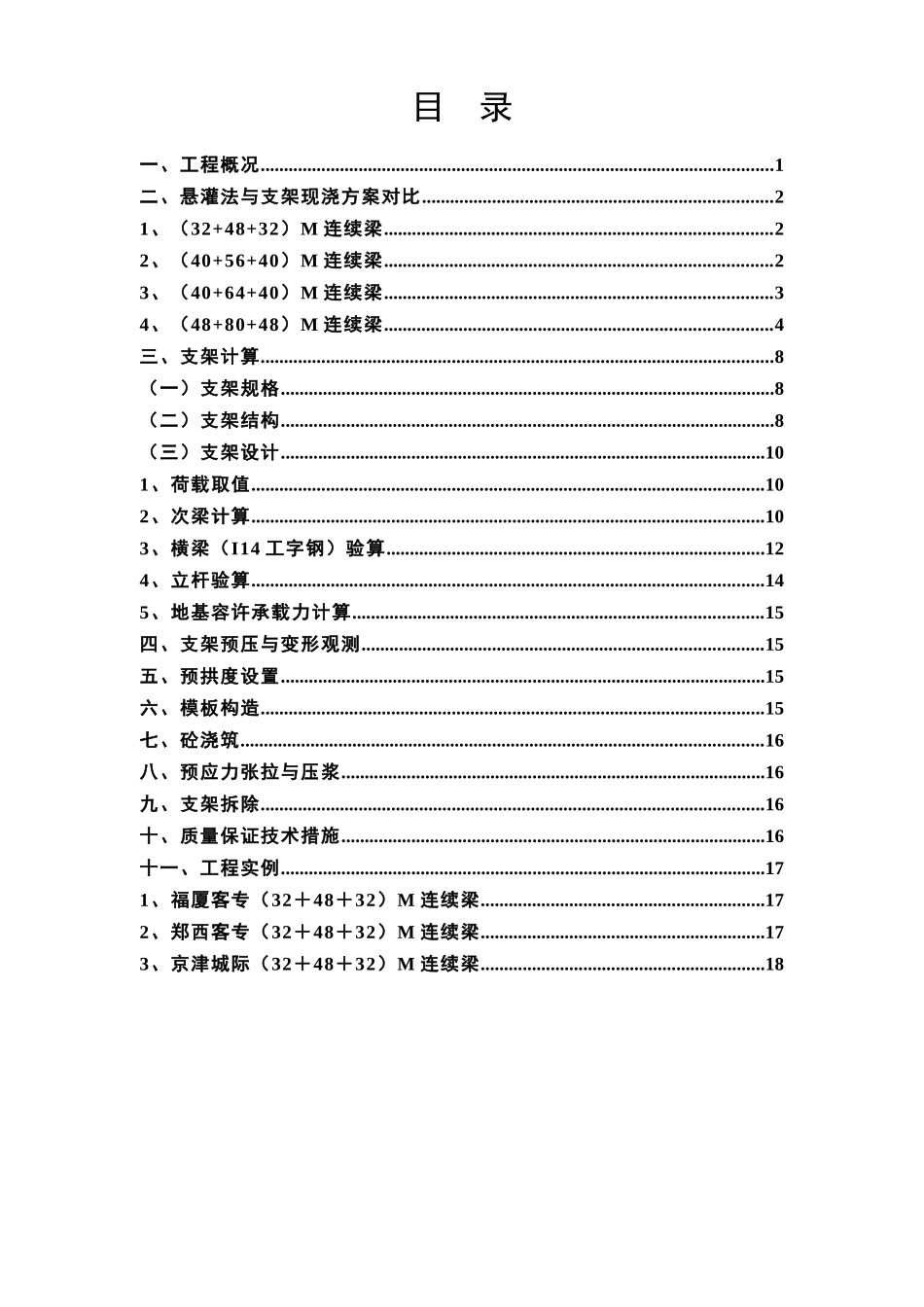

京沪高速铁路土建工程一标段悬灌梁改现浇法施工方案中铁十七局京沪高速铁路土建工程一标段项目经理部二〇〇八年八月廊坊目录一、工程概况..............................................................................................................1二、悬灌法与支架现浇方案对比...........................................................................21、(32+48+32)M连续梁...................................................................................22、(40+56+40)M连续梁...................................................................................23、(40+64+40)M连续梁...................................................................................34、(48+80+48)M连续梁...................................................................................4三、支架计算..............................................................................................................8(一)支架规格..........................................................................................................8(二)支架结构..........................................................................................................8(三)支架设计........................................................................................................101、荷载取值..............................................................................................................102、次梁计算..............................................................................................................103、横梁(I14工字钢)验算.................................................................................124、立杆验算..............................................................................................................145、地基容许承载力计算........................................................................................15四、支架预压与变形观测......................................................................................15五、预拱度设置........................................................................................................15六、模板构造............................................................................................................15七、砼浇筑................................................................................................................16八、预应力张拉与压浆...........................................................................................16九、支架拆除............................................................................................................16十、质量保证技术措施...........................................................................................16十一、工程实例........................................................................................................171、福厦客专(32+48+32)M连续梁.............................................................172、郑西客专(32+48+32)M连续梁.............................................................173、京津城际(32+48+32)M连续梁.............................................................18京沪高速铁路土建一标段连续梁悬灌法改支架法现浇施工方案一、工程概况京沪高速铁路一标段设计跨河、跨路连续梁56联,在目前征地拆严重滞后的情况下,已成为控制运架梁通过的关键性工程。经现场核对,发现其中18联连续梁(详见表1)具备支架法现浇条件,其中(32+48+32)m连续梁8联...
