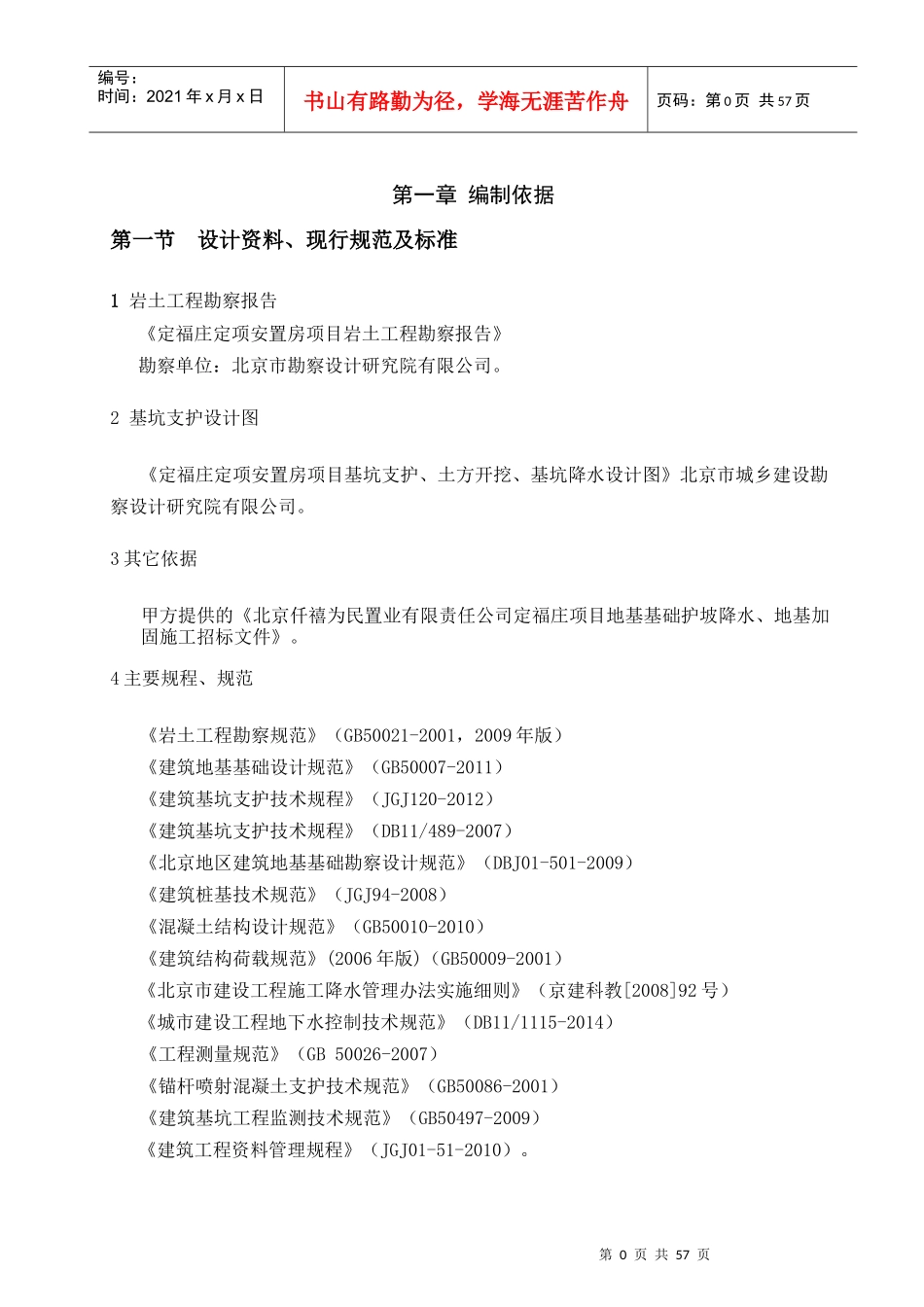

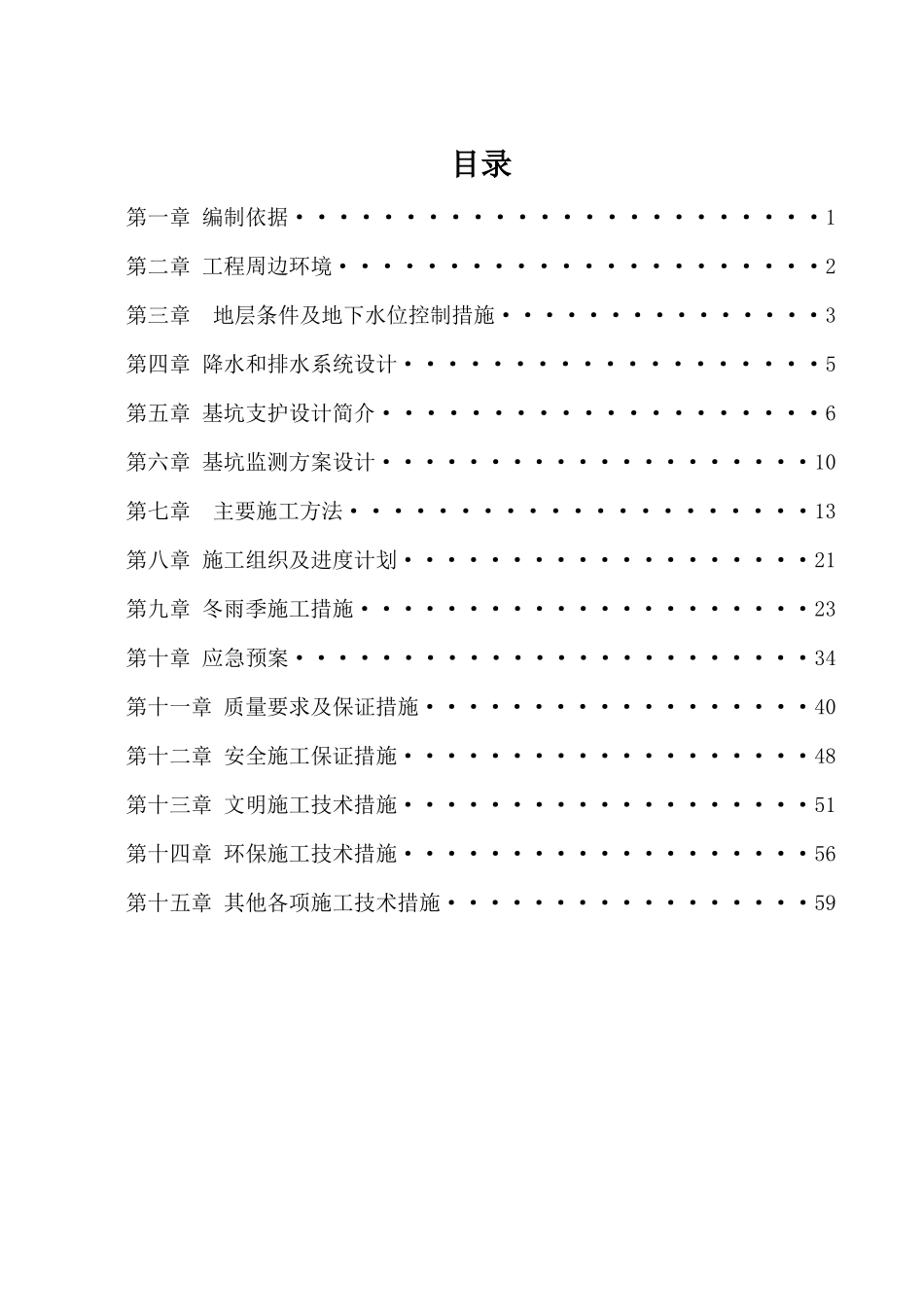

目录第一章编制依据························1第二章工程周边环境······················2第三章地层条件及地下水位控制措施···············3第四章降水和排水系统设计···················5第五章基坑支护设计简介····················6第六章基坑监测方案设计····················10第七章主要施工方法·····················13第八章施工组织及进度计划···················21第九章冬雨季施工措施·····················23第十章应急预案························34第十一章质量要求及保证措施··················40第十二章安全施工保证措施···················48第十三章文明施工技术措施···················51第十四章环保施工技术措施···················56第十五章其他各项施工技术措施·················59第0页共57页编号:时间:2021年x月x日书山有路勤为径,学海无涯苦作舟页码:第0页共57页第一章编制依据第一节设计资料、现行规范及标准1岩土工程勘察报告《定福庄定项安置房项目岩土工程勘察报告》勘察单位:北京市勘察设计研究院有限公司
2基坑支护设计图《定福庄定项安置房项目基坑支护、土方开挖、基坑降水设计图》北京市城乡建设勘察设计研究院有限公司
3其它依据甲方提供的《北京仟禧为民置业有限责任公司定福庄项目地基基础护坡降水、地基加固施工招标文件》

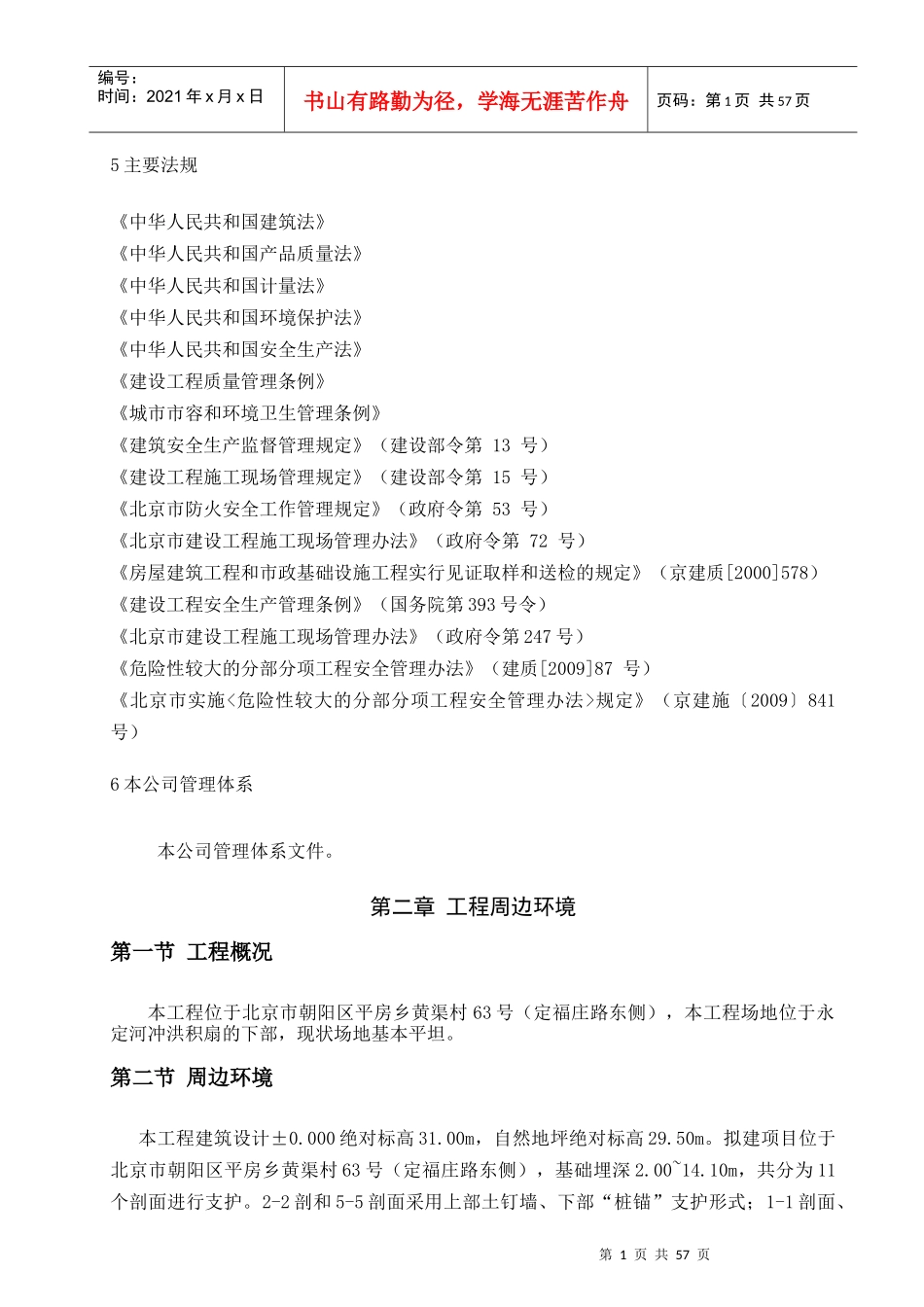

4主要规程、规范《岩土工程勘察规范》(GB50021-2001,2009年版)《建筑地基基础设计规范》(GB50007-2011)《建筑基坑支护技术规程》(JGJ120
