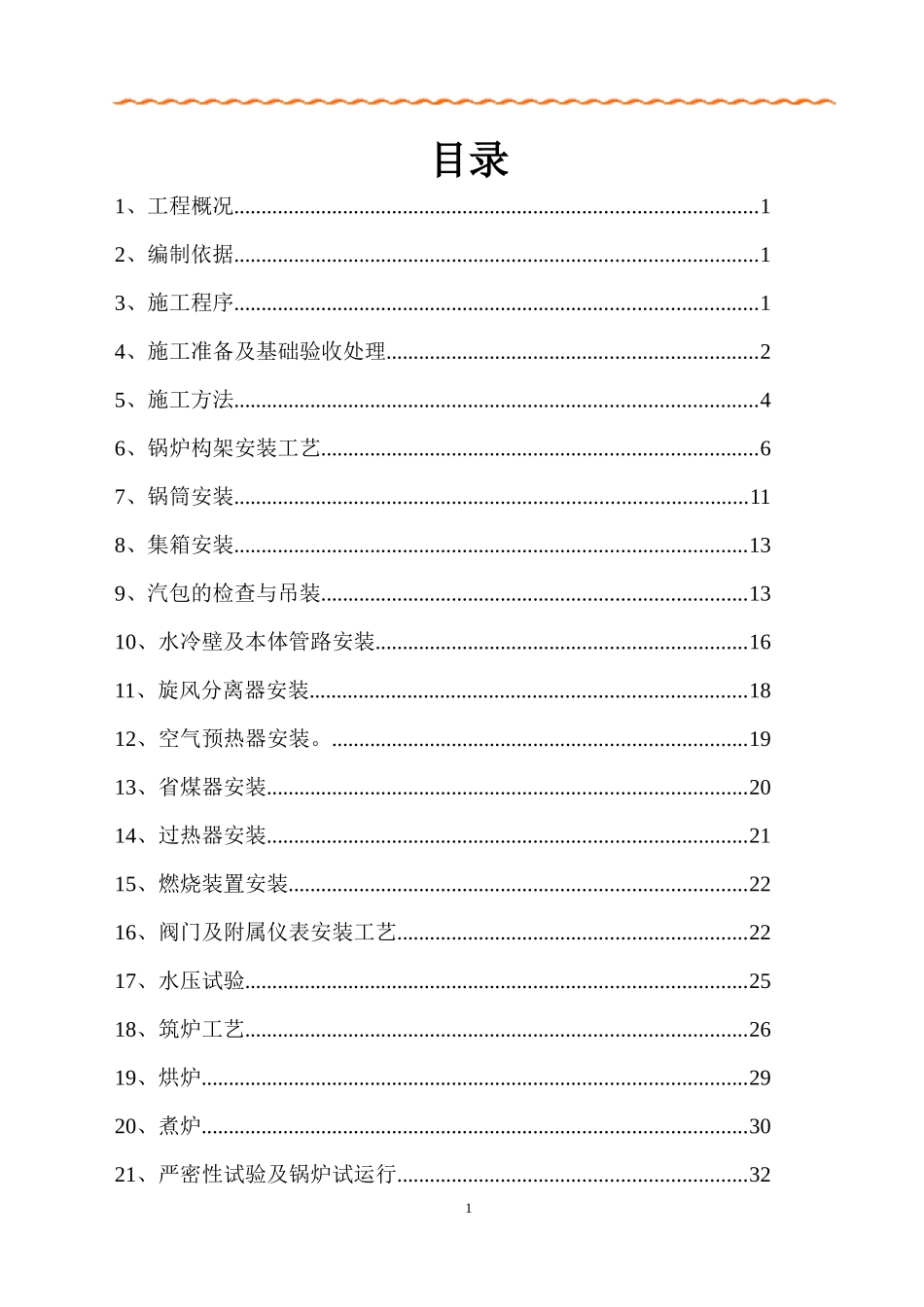

130t循环流化床锅炉施工方案编制:王德位审核:刘成毅班级:安装090101班四川建筑职业技术学院设备工程系二O一一年六月二十日2目录1、工程概况................................................................................................12、编制依据................................................................................................13、施工程序................................................................................................14、施工准备及基础验收处理....................................................................25、施工方法................................................................................................46、锅炉构架安装工艺................................................................................67、锅筒安装..............................................................................................118、集箱安装..............................................................................................139、汽包的检查与吊装..............................................................................1310、水冷壁及本体管路安装....................................................................1611、旋风分离器安装................................................................................1812、空气预热器安装。............................................................................1913、省煤器安装........................................................................................2014、过热器安装........................................................................................2115、燃烧装置安装....................................................................................2216、阀门及附属仪表安装工艺................................................................2217、水压试验............................................................................................2518、筑炉工艺............................................................................................2619、烘炉....................................................................................................2920、煮炉....................................................................................................3021、严密性试验及锅炉试运行................................................................32122、质量保证措施....................................................................................3323、安全保证措施及文明施工................................................................3424、环境管理措施....................................................................................3625、材料管理措施....................................................................................362第1页共46页编号:时间:2021年x月x日书山有路勤为径,学海无涯苦作舟页码:第1页共46页1、工程概况三台130t/h高温高压循环流化床锅炉,锅炉采用自然循环、单炉膛、平衡通风、露天布置、全钢架悬吊结构;炉内石灰石脱硫,固态排渣。锅炉燃料为煤炭,锅炉炉渣通过两台冷渣机冷却后,用埋刮板输送机送至渣仓经加湿搅拌后用汽车运走。锅炉的主要技术参数:额定蒸发量:130t/h额定蒸汽压力:5.3MPa额定蒸汽温度:450℃针对锅炉安装的工程量大,工序繁多、施工技术和质量要求高、工期紧等特点,必须制定详实的施工方案,并合理、有效的组织施工,才能确保锅炉安装工程的顺利进行和按期完工。2、编制依据2.1由于业主未提供锅炉本体详细图纸,现根据我公司以往类似工程的施工经验进行编制。2.2《电力建设施工...
