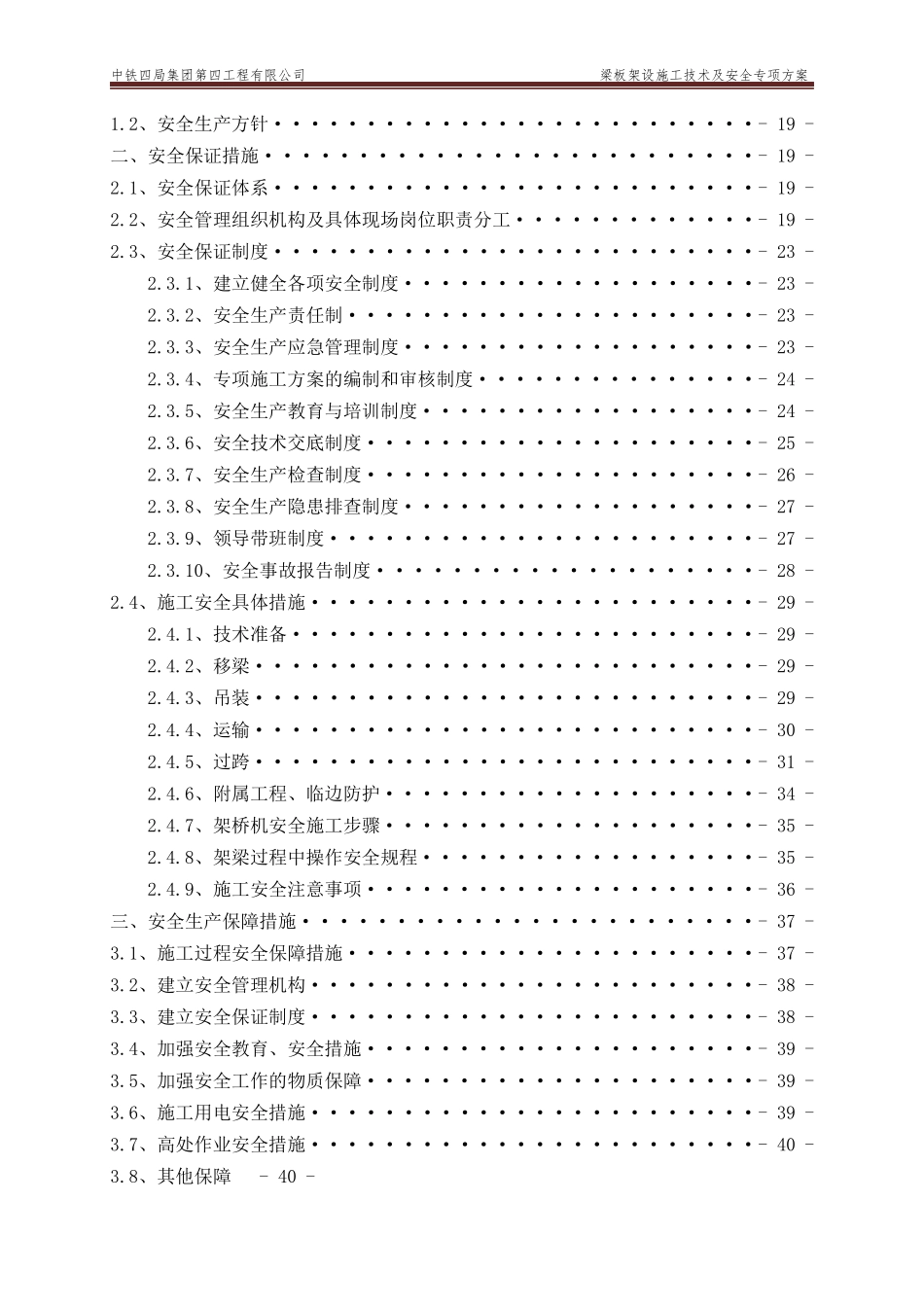

中铁四局集团第四工程有限公司梁板架设施工技术及安全专项方案扬州至绩溪高速公路广德至宁国段路基工程GN-04标梁板架设施工技术及安全专项方案编制:审核:审批:广德至宁国高速公路路基工程第四合同段中铁四局集团第四工程有限公司项目经理部二0一六年十一月二十八日中铁四局集团第四工程有限公司梁板架设施工技术及安全专项方案目录第一章施工技术内容一、编制依据·····························-1-二、工程概况·····························-1-三、总体安排及工艺流程························-4-3.1、总体安排-4-3.2、工艺流程-4-四、施工方案·····························-5-4.1、总体方案-5-4.2、箱梁安装方案··························-5-4.2.1、梁板安装施工准备·····················-5-4.2.2、双导梁架桥机拼装·····················-7-4.2.3、箱梁安装·························-9-4.3、T梁安装方案··························-10-4.3.1、工艺流程·························-10-五、质量控制方法和手段·······················-13-5.1、质量控制方法··························-13-5.1.1、交底···························-13-六、梁板架设施工注意事项······················-14-6.1、设备及操作-14-6.2、吊运-14-6.3、安装-14-6.4、其他要求-15-七、质量及安全措施·························-15-7.1、质量保证-15-7.1.1、质量保证体系·······················-15-7.1.2、质量保证相关措施·····················-15-7.2、安全保证-16-7.2.1、安全保证体系·······················-16-7.2.2、安全保证措施·······················-16-第二章安全生产管理体系及保证措施一、安全生产目标及方针·······················-19-1.1、安全生产目标··························-19-中铁四局集团第四工程有限公司梁板架设施工技术及安全专项方案1.2、安全生产方针··························-19-二、安全保证措施··························-19-2.1、安全保证体系··························-19-2.2、安全管理组织机构及具体现场岗位职责分工·············-19-2.3、安全保证制度··························-23-2.3.1、建立健全各项安全制度···················-23-2.3.2、安全生产责任制······················-23-2.3.3、安全生产应急管理制度···················-23-2.3.4、专项施工方案的编制和审核制度···············-24-2.3.5、安全生产教育与培训制度··················-24-2.3.6、安全技术交底制度·····················-25-2.3.7、安全生产检查制度·····················-26-2.3.8、安全生产隐患排查制度···················-27-2.3.9、领导带班制度·······················-27-2.3.10、安全事故报告制度····················-28-2.4、施工安全具体措施························-29-2.4.1、技术准备·························-29-2.4.2、移梁···························-29-2.4.3、吊装··...
