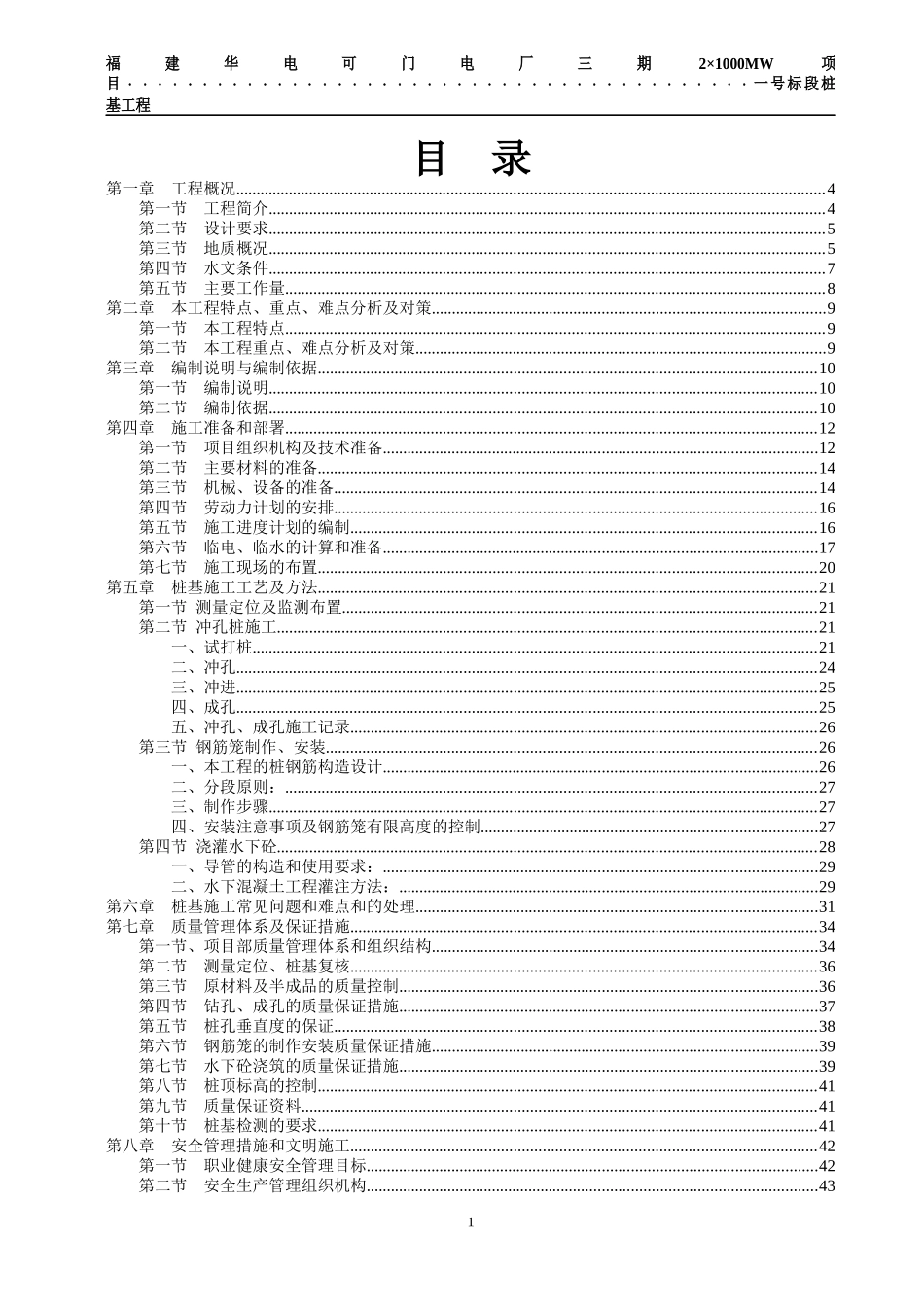

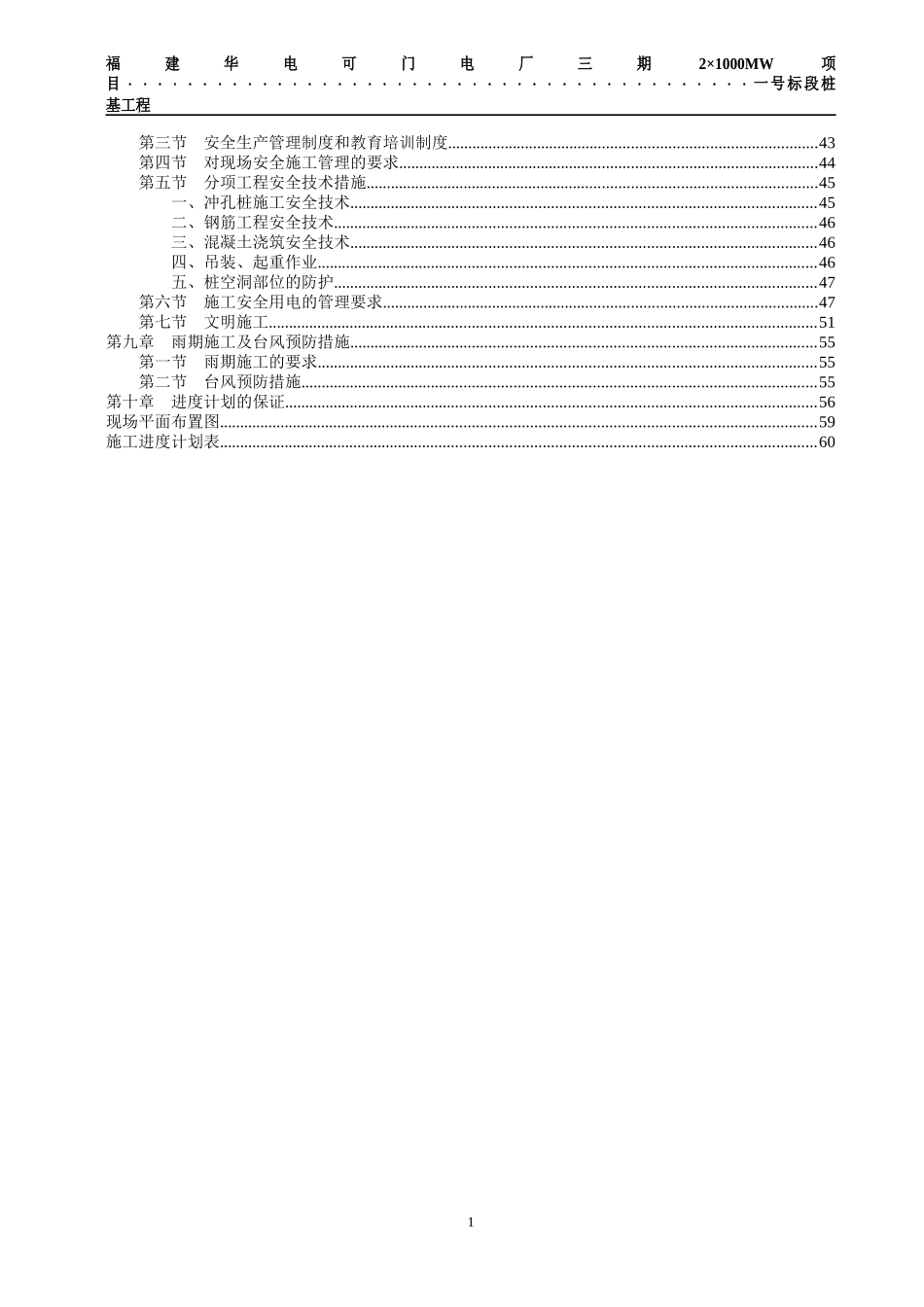

福建华电可门电厂三期2×1000MW项目一号标段桩基工程施工组织设计编制单位:江西省地质工程(集团)公司编制人:审核人:主管:2015年11月25日福建华电可门电厂三期2×1000MW项目··········································一号标段桩基工程目录第一章工程概况...............................................................................................................................................4第一节工程简介.......................................................................................................................................4第二节设计要求.......................................................................................................................................5第三节地质概况.......................................................................................................................................5第四节水文条件.......................................................................................................................................7第五节主要工作量...................................................................................................................................8第二章本工程特点、重点、难点分析及对策................................................................................................9第一节本工程特点...................................................................................................................................9第二节本工程重点、难点分析及对策....................................................................................................9第三章编制说明与编制依据.........................................................................................................................10第一节编制说明.....................................................................................................................................10第二节编制依据.....................................................................................................................................10第四章施工准备和部署.................................................................................................................................12第一节项目组织机构及技术准备..........................................................................................................12第二节主要材料的准备.........................................................................................................................14第三节机械、设备的准备.....................................................................................................................14第四节劳动力计划的安排.....................................................................................................................16第五节施工进度计划的编制.................................................................................................................16第六节临电、临水的计算和准备..........................................................................................................17第七节施工现场的布置.........................................................................................................................20第五章桩基施工工艺及方法.........................................................................................................................21第一节测量定位及监...
