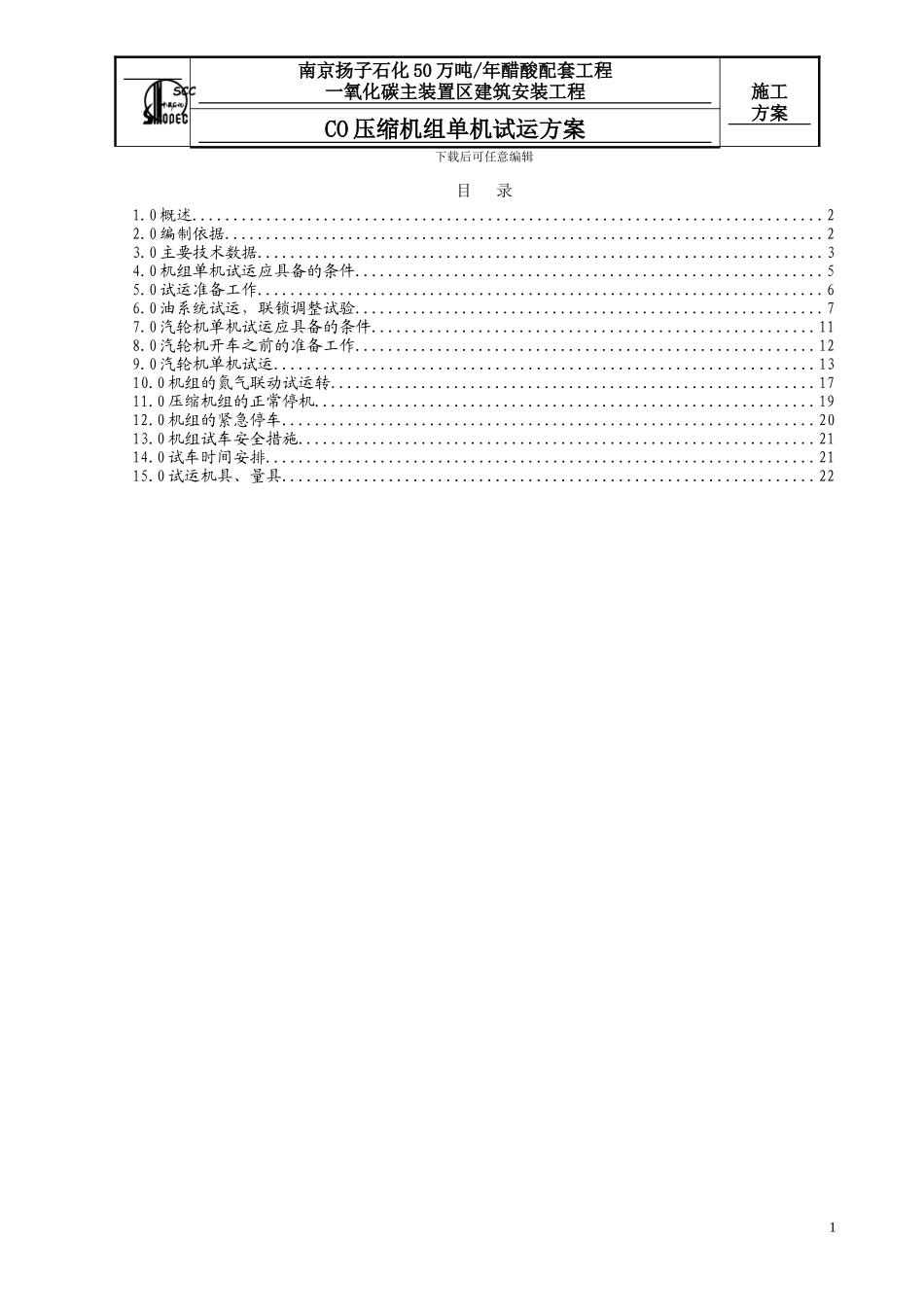

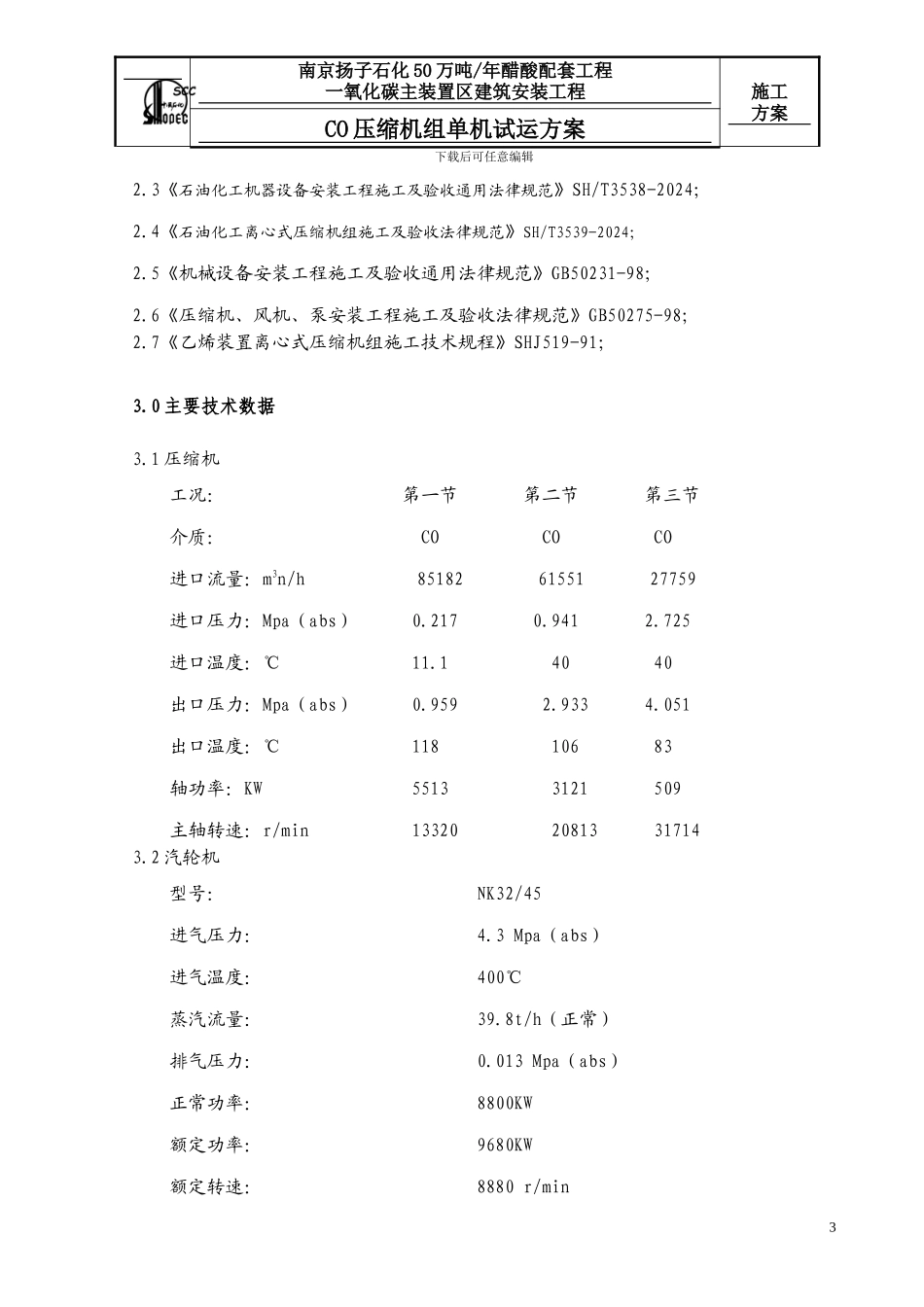

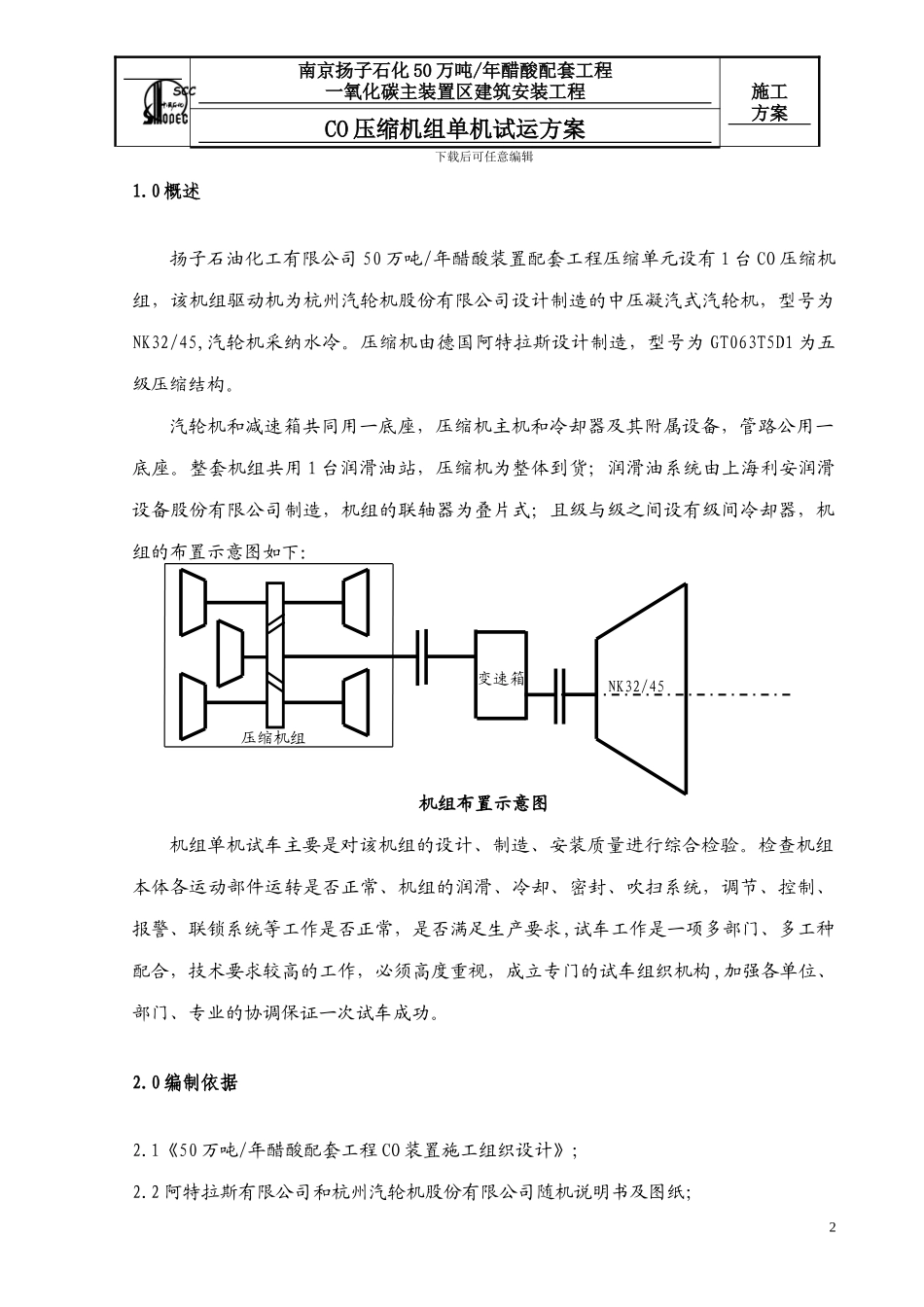

南京扬子石化 50 万吨/年醋酸配套工程一氧化碳主装置区建筑安装工程施工方案CO 压缩机组单机试运方案下载后可任意编辑目 录1.0 概述.............................................................................22.0 编制依据.........................................................................23.0 主要技术数据.....................................................................34.0 机组单机试运应具备的条件.........................................................55.0 试运准备工作.....................................................................66.0 油系统试运,联锁调整试验.........................................................77.0 汽轮机单机试运应具备的条件......................................................118.0 汽轮机开车之前的准备工作........................................................129.0 汽轮机单机试运..................................................................1310.0 机组的氮气联动试运转...........................................................1711.0 压缩机组的正常停机.............................................................1912.0 机组的紧急停车.................................................................2013.0 机组试车安全措施...............................................................2114.0 试车时间安排...................................................................2115.0 试运机具、量具.................................................................221南京扬子石化 50 万吨/年醋酸配套工程一氧化碳主装置区建筑安装工程施工方案CO 压缩机组单机试运方案下载后可任意编辑1.0 概述扬子石油化工有限公司 50 万吨/年醋酸装置配套工程压缩单元设有 1 台 CO 压缩机组,该机组驱动机为杭州汽轮机股份有限公司设计制造的中压凝汽式汽轮机,型号为NK32/45,汽轮机采纳水冷。压缩机由德国阿特拉斯设计制造,型号为 GT063T5D1 为五级压缩结构。汽轮机和减速箱共同用一底座,压缩机主机和冷却器及其附属设备,管路公用一底座。整套机组共用 1 台润滑油站,压缩机为整体到货;润滑油系统由上海利安润滑设备股份有限公司制造,机组的联轴器为叠片式;且级与级之间设有...
