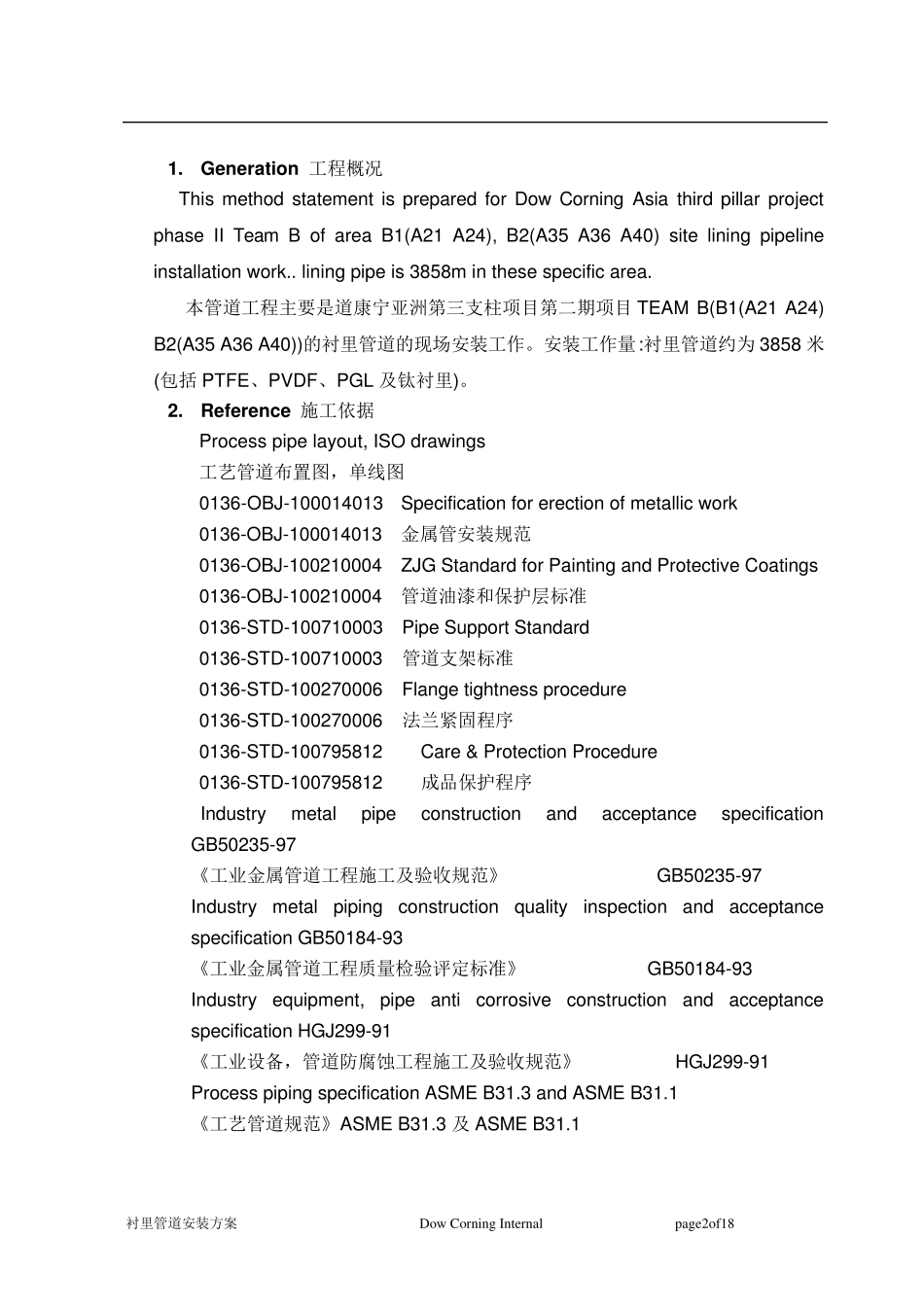

衬里管道安装方案 Dow Corning Internal page1of18 Content 目录 1. Generation 工程概况 ......................................................................................... 2 2. Reference 施工依据 ........................................................................................... 2 3. Piping installation precondition 管道安装条件 ................................................ 3 4. Material acceptance 材料的验收 ....................................................................... 3 5. Material release and control 材料的领用与控制 .............................................. 4 6. Piping installation 管道安装 ............................................................................. 5 7. QC Plan 质量控制计划 ...................................................................................... 1 6 8. construction safety and civilization 安全与文明施工 ..................................... 17 衬里管道安装方案 Dow Corning Internal page2of18 1. Generation 工程概况 This method statement is prepared for Dow Corning Asia third pillar project phase II Team B of area B1(A21 A24), B2(A35 A36 A40) site lining pipeline installation work.. lining pipe is 3858m in these specific area. 本管道工程主要是道康宁亚洲第三支柱项目第二期项目TEAM B(B1(A21 A24) B2(A35 A36 A40))的衬里管道的现场安装工作。安装工作量:衬里管道约为3858 米(包括PTFE、PVDF、PGL 及钛衬里)。 2. Reference 施工依据 Process pipe layout, ISO drawings 工艺管道布置图,单线图 0136-OBJ-100014013 Specification for erection of metallic work 0136-OBJ-100014013 金属管安装规范 0136-OBJ-100210004 ZJG Standard for Painting and Protective Coatings 0136-OBJ-100210004 管道油漆和保护层标准 0136-STD-100710003 Pipe Support Standard 0136-STD-100710003 管道支架标准 0136-STD-100270006 Flange tightness procedure 0136-STD-100270006 法兰紧固程序 0136-STD-100795812 Care & Pr...
