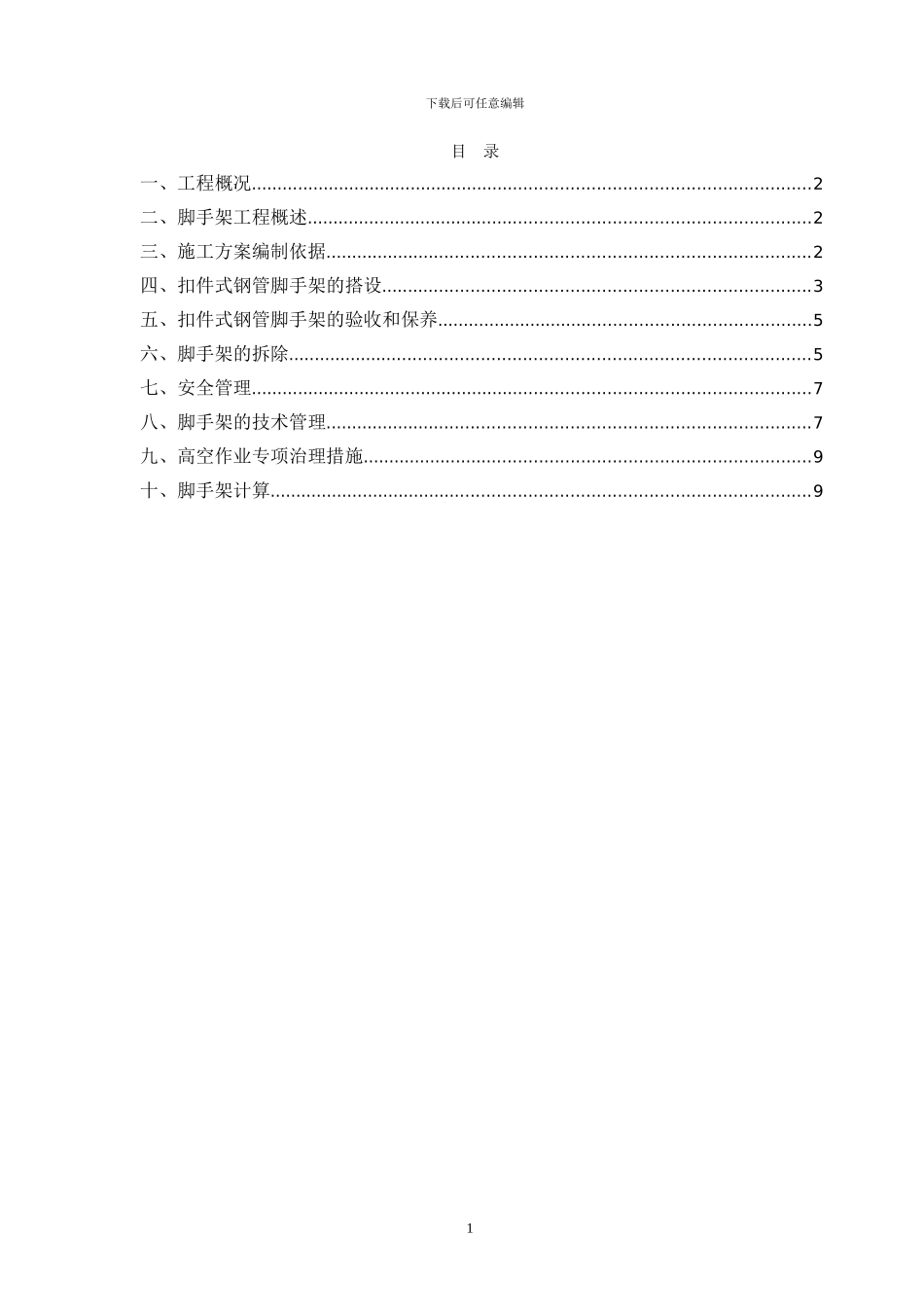

下载后可任意编辑目 录一、工程概况............................................................................................................2二、脚手架工程概述.................................................................................................2三、施工方案编制依据.............................................................................................2四、扣件式钢管脚手架的搭设..................................................................................3五、扣件式钢管脚手架的验收和保养........................................................................5六、脚手架的拆除....................................................................................................5七、安全管理............................................................................................................7八、脚手架的技术管理.............................................................................................7九、高空作业专项治理措施......................................................................................9十、脚手架计算........................................................................................................9 1下载后可任意编辑脚手架搭、拆施工方案一、工程概况工程名称: 建设单位: 设计单位:监理单位: 施工单位:脚手架工程、概述本工程施工脚手架采纳着地式双排钢管脚手,均用48×3.5 管及标准扣件搭设,脚手连接采纳十字扣件、对接扣件和万向扣件。落地外脚手架从建筑室外地坪搭至女儿墙上口,脚手架搭设高度分别为 1#、2#、3#、4#、5#分别为 40m、29m、19m、18m、17.5m。内脚手按不同的需要采纳双排脚手和满堂脚手,供室内墙体砌筑和内粉刷时搭设双排脚手,安装管道和装饰吊顶施工时根据需要搭设满堂脚手。二、 施工方案编制依据1、 脚手架施工方案参照中华人民共和国行业标准,扣件其机械性能应符合《钢管脚手架扣件》(GB1583-1995);2、 《建筑施工扣件式钢管脚手架安全技术法律规范》JGJ130—2001;3、 《建筑施工安全检查标准》(JGJ59-99);4、 《建筑施工机械扣件式钢管脚手架安全技术法律规范》(JGJ130- 2下载后可任意编辑2001);5、 *楼工程图纸;6、 施工现...
