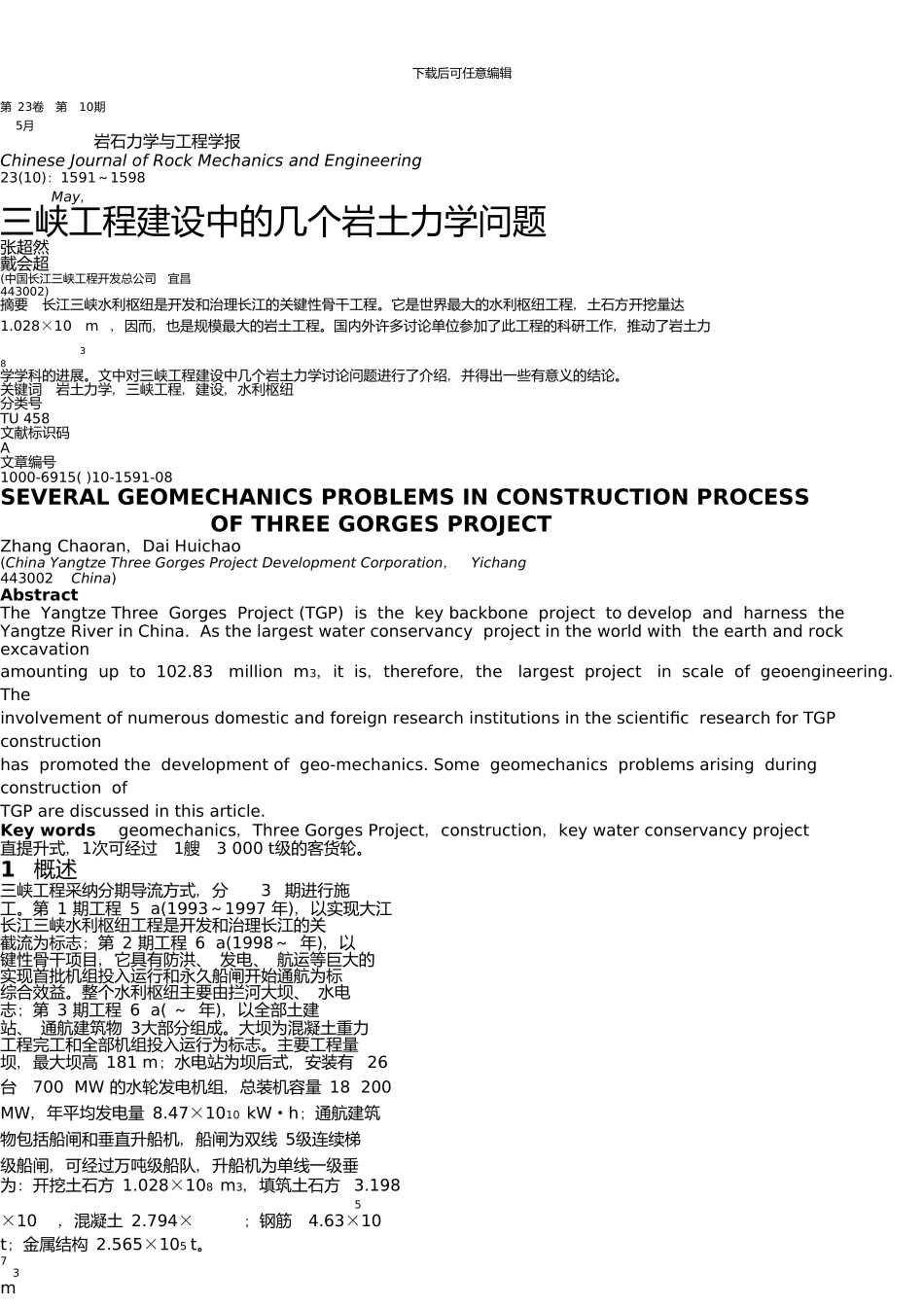

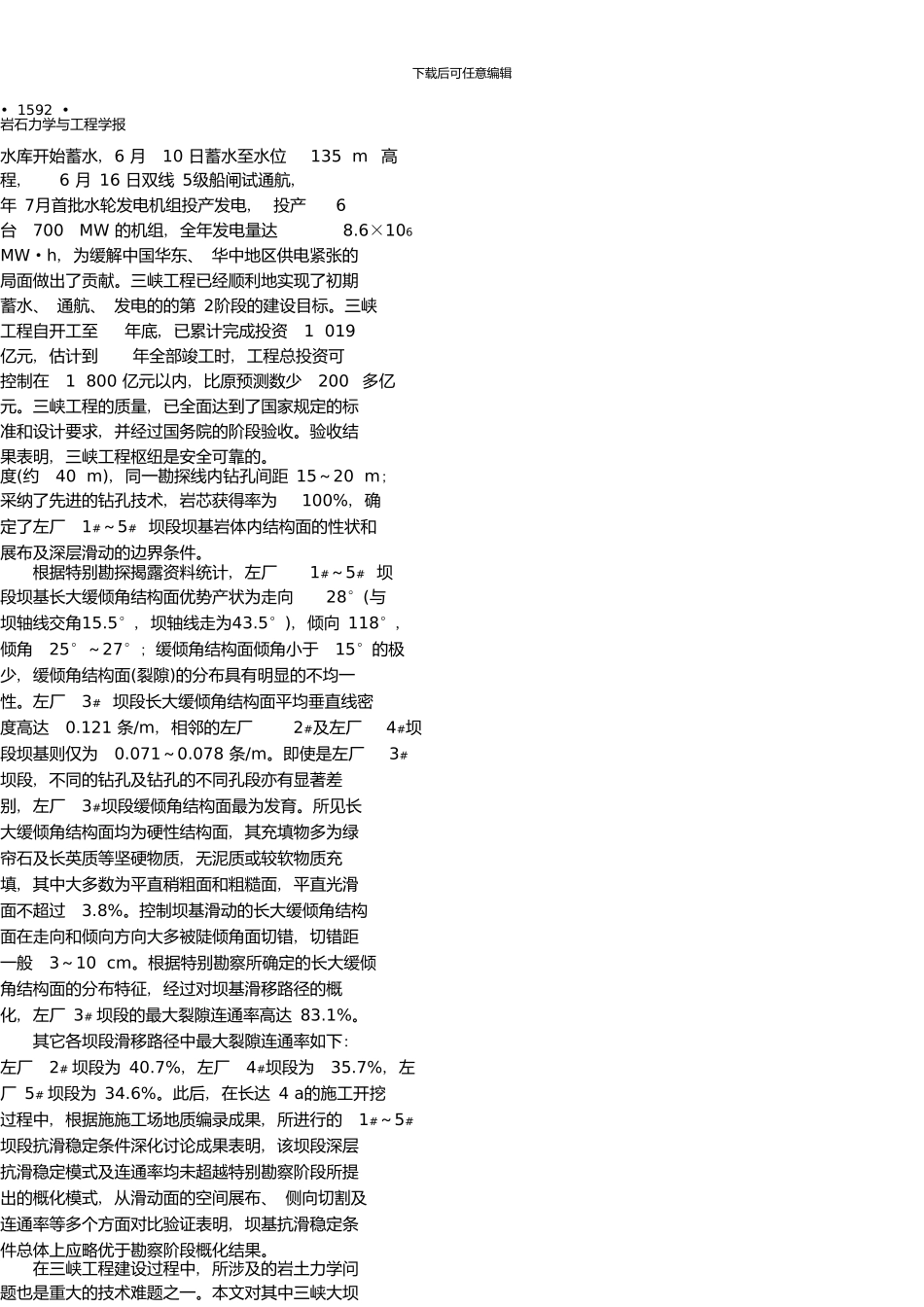

下载后可任意编辑 第 23卷 第 10期 5月岩石力学与工程学报Chinese Journal of Rock Mechanics and Engineering23(10): 1591~1598May, 三峡工程建设中的几个岩土力学问题张超然戴会超(中国长江三峡工程开发总公司 宜昌443002)摘要 长江三峡水利枢纽是开发和治理长江的关键性骨干工程。它是世界最大的水利枢纽工程, 土石方开挖量达1.028×10 m , 因而, 也是规模最大的岩土工程。国内外许多讨论单位参加了此工程的科研工作, 推动了岩土力38学学科的进展。文中对三峡工程建设中几个岩土力学讨论问题进行了介绍, 并得出一些有意义的结论。关键词 岩土力学, 三峡工程, 建设, 水利枢纽分类号TU 458文献标识码A文章编号1000-6915( )10-1591-08SEVERAL GEOMECHANICS PROBLEMS IN CONSTRUCTION PROCESS OF THREE GORGES PROJECT Zhang Chaoran, Dai Huichao(China Yangtze Three Gorges Project Development Corporation, Yichang443002 China)AbstractThe Yangtze Three Gorges Project (TGP) is the key backbone project to develop and harness theYangtze River in China. As the largest water conservancy project in the world with the earth and rock excavationamounting up to 102.83 million m3, it is, therefore, the largest project in scale of geoengineering. Theinvolvement of numerous domestic and foreign research institutions in the scientific research for TGP constructionhas promoted the development of geo-mechanics. Some geomechanics problems arising during construction ofTGP are discussed in this article.Key words geomechanics, Three Gorges Project, construction, key water conservancy project直提升式, 1次可经过 1艘 3 000 t级的客货轮。1 概述三峡工程采纳分期导流方式, 分 3 期进行施工。第 1 期工程 5 a(1993~1997 年), 以实现大江长江三峡水利枢纽工程是开发和治理长江的关截流为标志; 第 2 期工程 6 a(1998~ 年), 以键性骨干项目, 它具有防洪、 发电、 航运等巨大的实现首批机组投入运行和永久船闸开始通航为标综合效益。整个水利枢纽主要由拦河大坝、 水电志; 第 3 期工程 6 a( ~ 年), 以全部土建站、...
