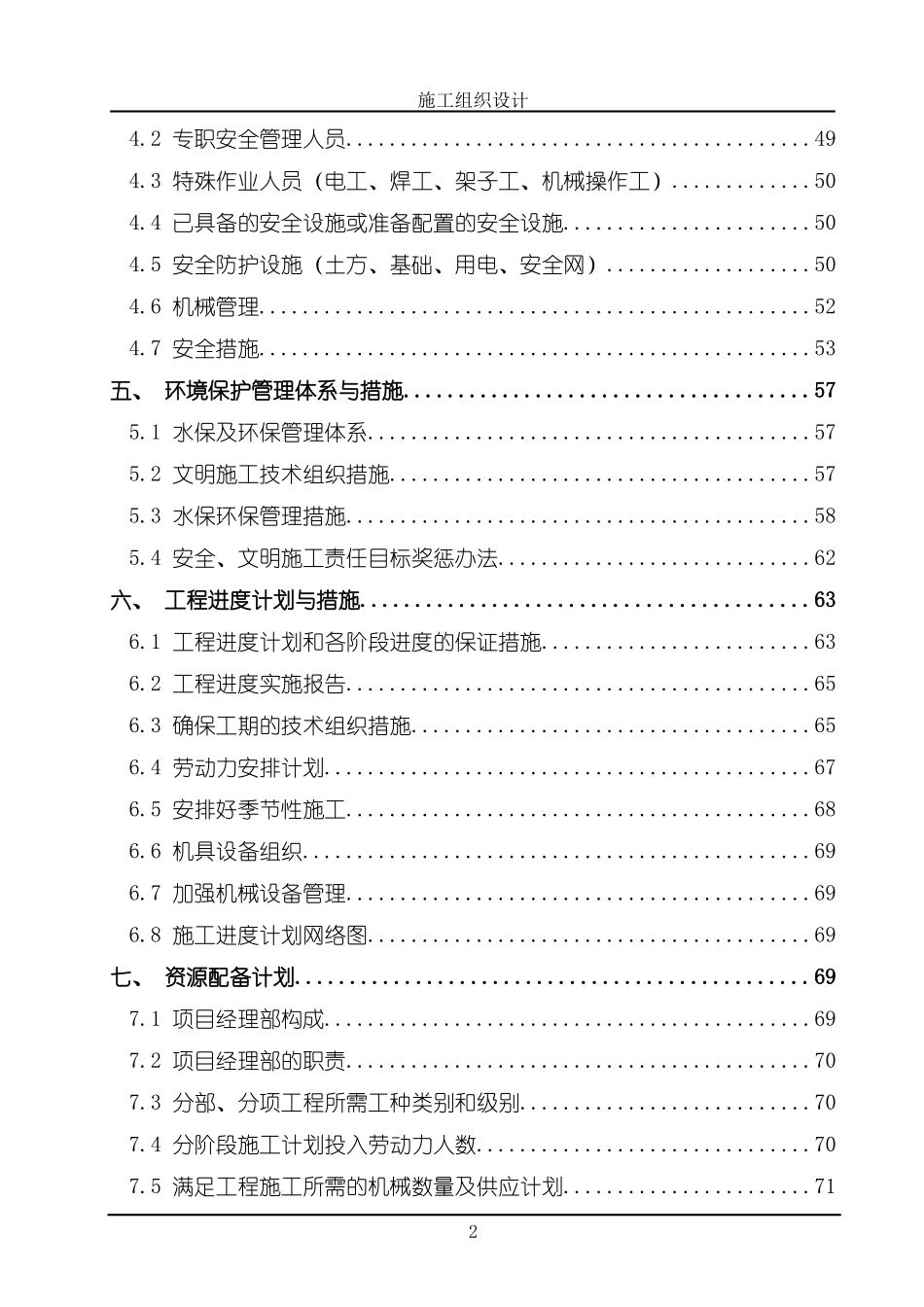

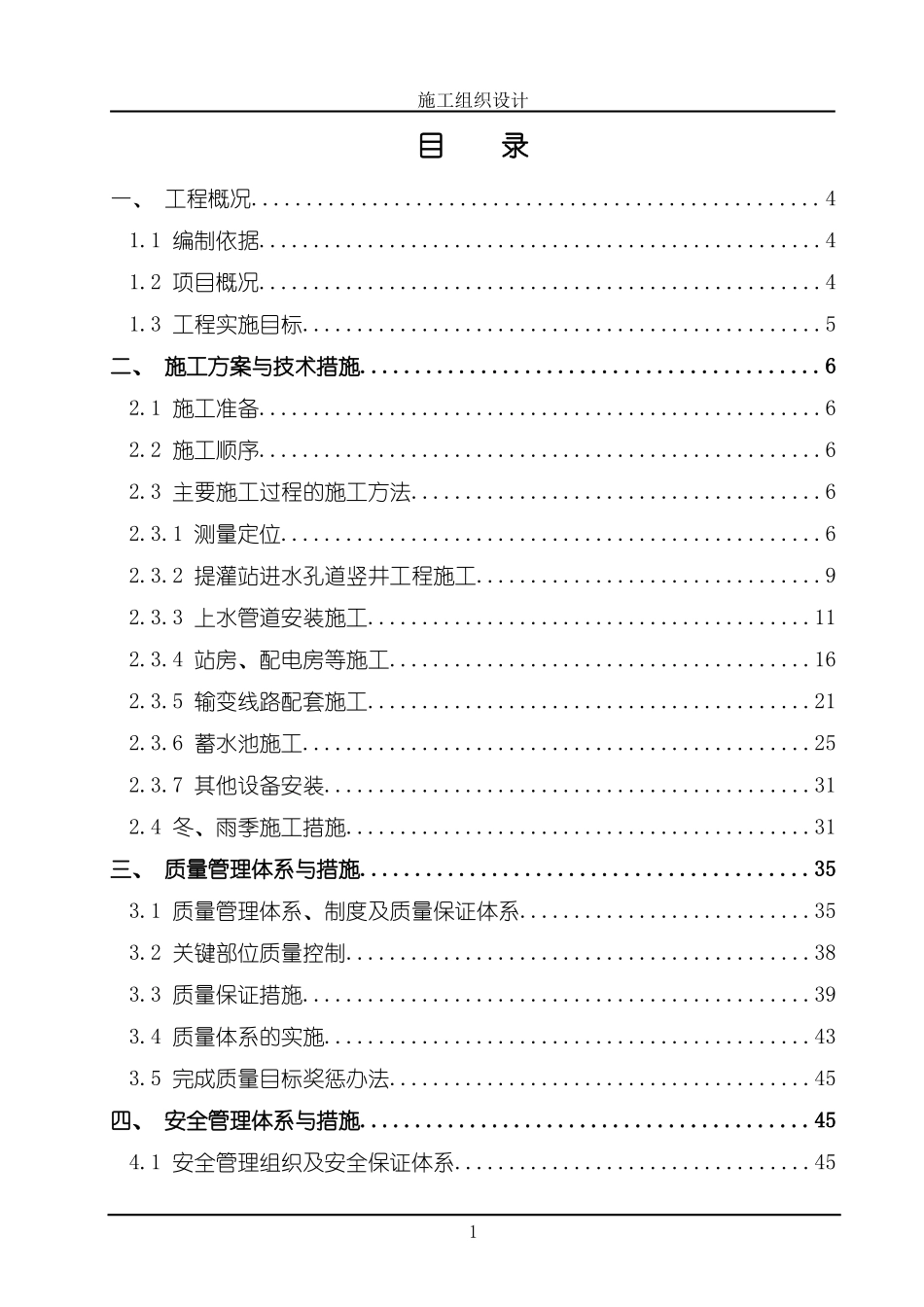

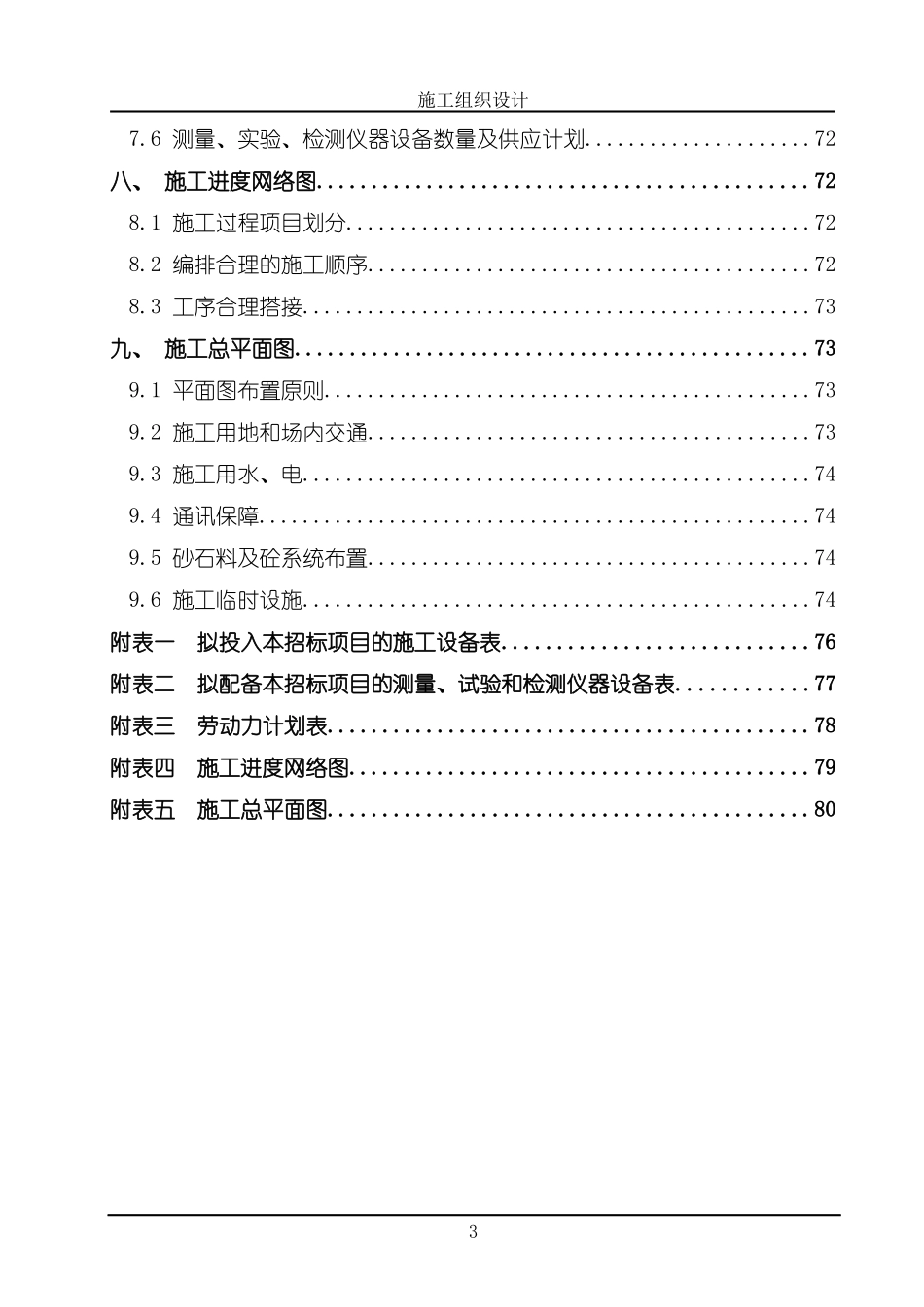

施工组织设计目录一、工程概况....................................................41.1编制依据....................................................41.2项目概况....................................................41.3工程实施目标................................................5二、施工方案与技术措施..........................................62.1施工准备....................................................62.2施工顺序....................................................62.3主要施工过程的施工方法......................................62.3.1测量定位..................................................62.3.2提灌站进水孔道竖井工程施工................................92.3.3上水管道安装施工.........................................112.3.4站房、配电房等施工.......................................162.3.5输变线路配套施工.........................................212.3.6蓄水池施工...............................................252.3.7其他设备安装.............................................312.4冬、雨季施工措施...........................................31三、质量管理体系与措施.........................................353.1质量管理体系、制度及质量保证体系...........................353.2关键部位质量控制...........................................383.3质量保证措施...............................................393.4质量体系的实施.............................................433.5完成质量目标奖惩办法.......................................45四、安全管理体系与措施.........................................454.1安全管理组织及安全保证体系.................................451施工组织设计4.2专职安全管理人员...........................................494.3特殊作业人员(电工、焊工、架子工、机械操作工).............504.4已具备的安全设施或准备配置的安全设施.......................504.5安全防护设施(土方、基础、用电、安全网)...................504.6机械管理...................................................524.7安全措施...................................................53五、环境保护管理体系与措施.....................................575.1水保及环保管理体系.........................................575.2文明施工技术组织措施.......................................575.3水保环保管理措施...........................................585.4安全、文明施工责任目标奖惩办法.............................62六、工程进度计划与措施.........................................636.1工程进度计划和各阶段进度的保证措施.........................636.2工程进度实施报告...........................................656.3确保工期的技术组织措施.....................................656.4劳动力安排计划.............................................676.5安排好季节性施工...........................................686.6机具设备组织...............................................696.7加强机械设备管理...........................................696.8施工进度计划网络图.........................................69七、资源配备计划...............................................697.1项目经理部构成.............................................697.2项目经理部的职责...........................................707.3分部、分项工程所需工种类别和级别...........................707.4分阶段施工计划投入劳动力人数...............................707.5满足工程施工所需的机械数量及供应计划.......................712施工组织设计7.6测量、实验、检测仪器设备数量及供应计划.....................72八、施工进度网络...
