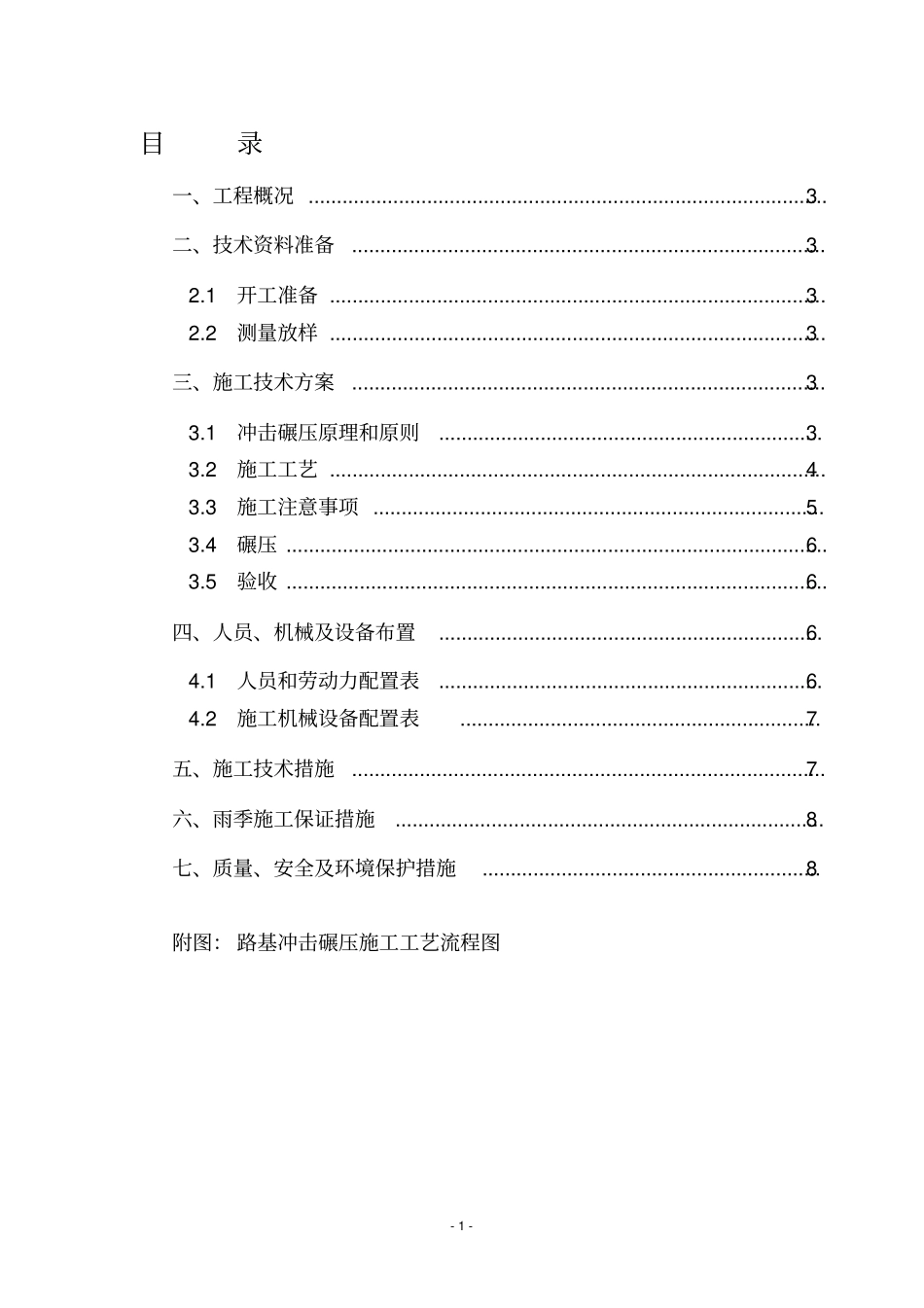

- 1 - 目录一、工程概况 ............................................................................................ 3二、技术资料准备 .................................................................................... 32.1 开工准备 ........................................................................................ 32.2 测量放样 ........................................................................................ 3三、施工技术方案 .................................................................................... 33.1 冲击碾压原理和原则 .................................................................... 33.2 施工工艺 ........................................................................................ 43.3 施工注意事项 ................................................................................ 53.4 碾压 ................................................................................................ 63.5 验收 ................................................................................................ 6四、人员、机械及设备布置 .................................................................... 64.1 人员和劳动力配置表 .................................................................... 64.2 施工机械设备配置表 ................................................................ 7五、施工技术措施 .................................................................................... 7六、雨季施工保证措施 ............................................................................ 8七、质量、安全及环境保护措施 ............................................................ 8附图: 路基冲击碾压施工工艺流程图- 2 - Xxx 工程路基冲击压实施工方案一、工程概况Xxx 工程位于温州中国鞋都三期北面,道路呈东向西走向, 设计等级为城市次干道。 其施工范围为纬六路桩号K0+011.206~K0+428,经六路桩号为K1+036~K1+178,道路红线宽度24 米,采用混凝土路面。本工程全为填方路基, 根据设计图纸要求对全路段路基进行冲击压实软基处理,处理...
