外文文献:Project Cost Control: The Way it WorksBy R
Max WidemanIn a recent consulting assignment we realized that there was some lack of understanding of thewholesystem of project cost control, how it is setup and applied
So we decided to write up adescription ofhow it works
Project cost control is not that difficult to follow in theory
First you establish a set of reference baselines
Then, as work progresses, you monitor the work, analyzethe findings, forecast the end results and compare those with the reference baselines
If the end resultsare not satisfactory then you make adjustments as necessary to the work in progress, and repeat the cycleat suitable intervals
If the end results get really out of line with the baseline plan, you may have tochange the plan

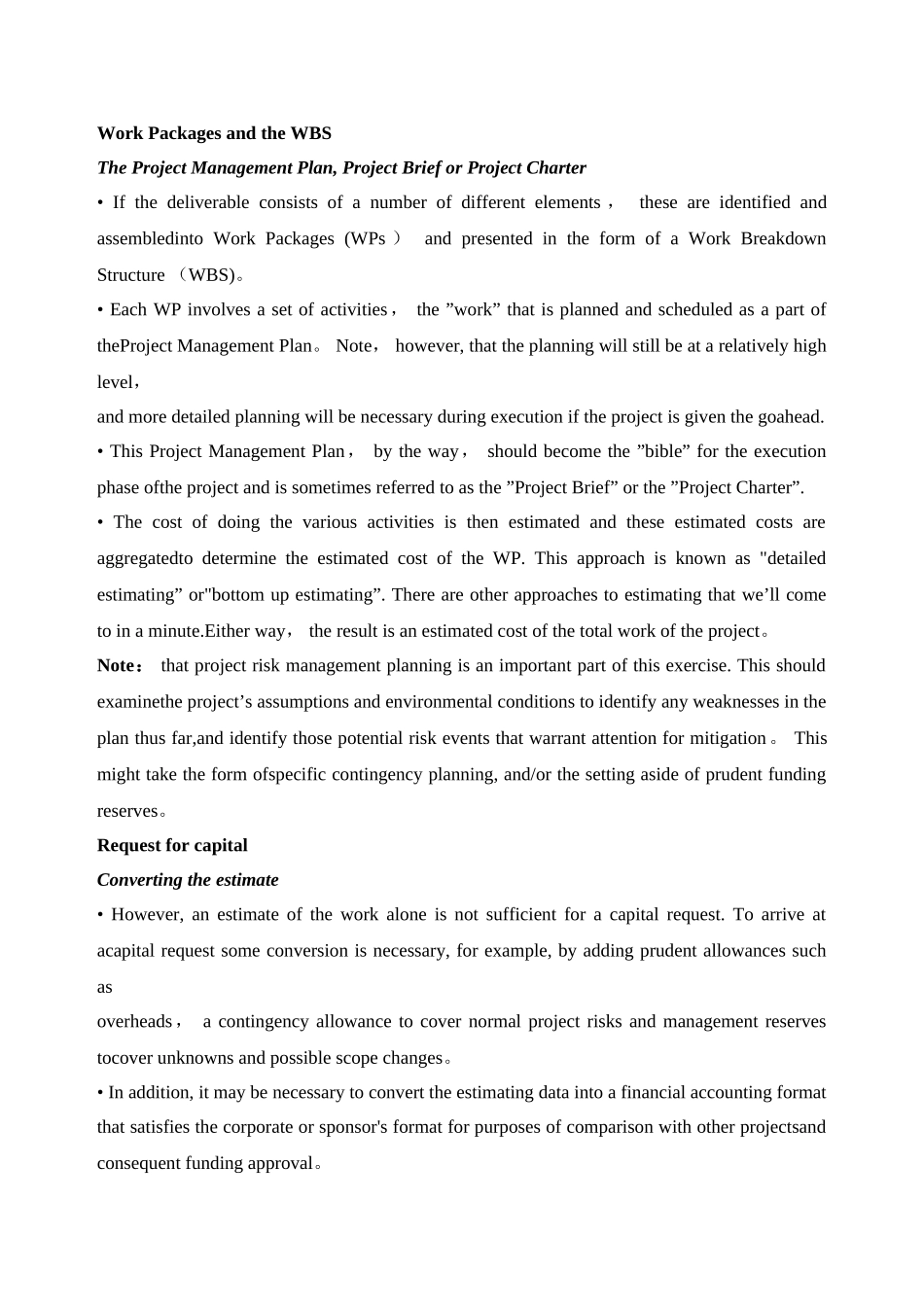

More likely, there will be
