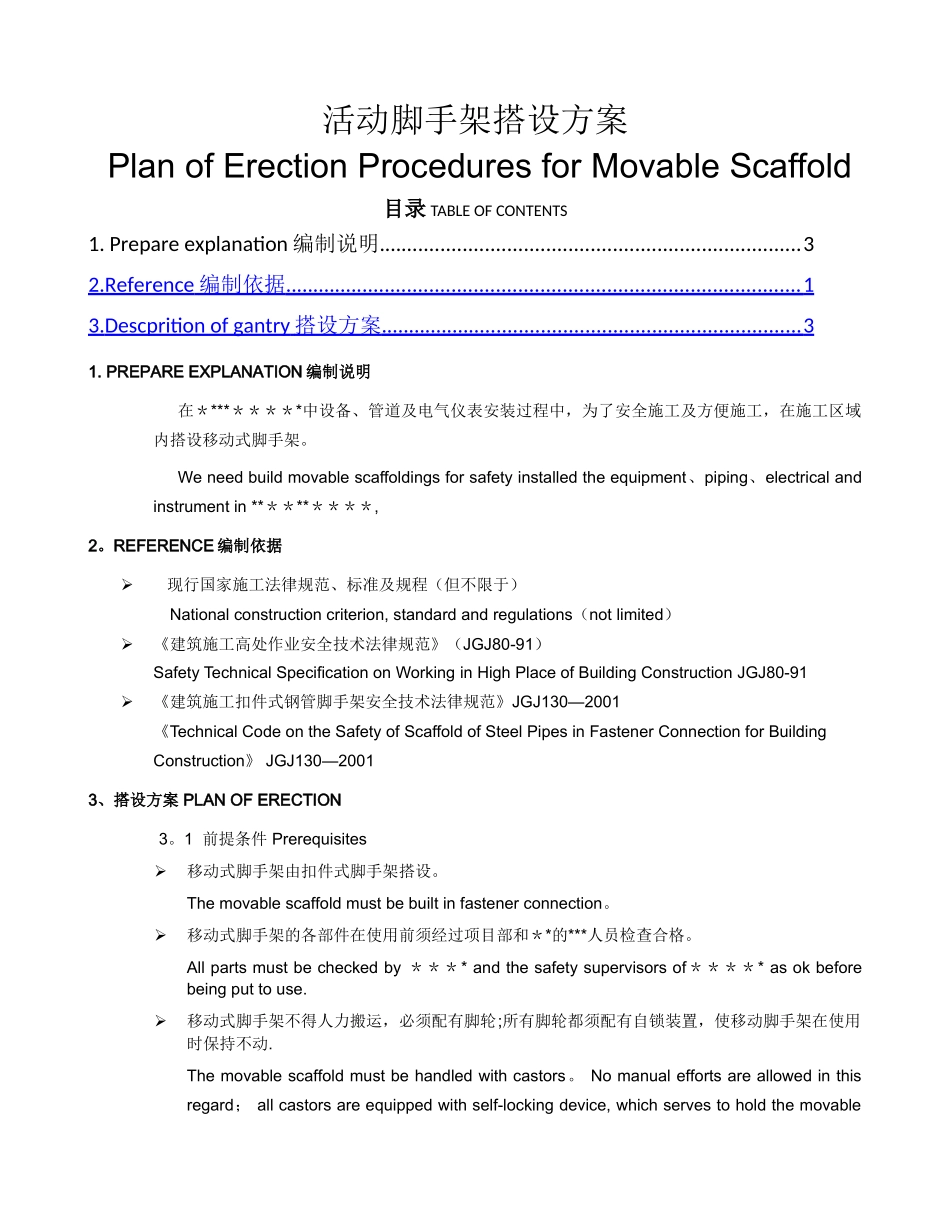

活动脚手架搭设方案 Plan of Erection Procedures for Movable Scaffold目录 TABLE OF CONTENTS1. Prepare explanation 编制说明............................................................................32.Reference 编制依据 ............................................................................................. 1 3. Descprition of gantry 搭设方案 ............................................................................ 3 1. PREPARE EXPLANATION 编制说明在*********中设备、管道及电气仪表安装过程中,为了安全施工及方便施工,在施工区域内搭设移动式脚手架。We need build movable scaffoldings for safety installed the equipment、piping、electrical and instrument in **********, 2。REFERENCE 编制依据 现行国家施工法律规范、标准及规程(但不限于)National construction criterion, standard and regulations(not limited) 《建筑施工高处作业安全技术法律规范》(JGJ80-91)Safety Technical Specification on Working in High Place of Building Construction JGJ80-91《建筑施工扣件式钢管脚手架安全技术法律规范》JGJ130—2001《Technical Code on the Safety of Scaffold of Steel Pipes in Fastener Connection for Building Construction》 JGJ130—20013、搭设方案 PLAN OF ERECTION 3。1 前提条件 Prerequisites移动式脚手架由扣件式脚手架搭设。The movable scaffold must be built in fastener connection。移动式脚手架的各部件在使用前须经过项目部和**的***人员检查合格。All parts must be checked by **** and the safety supervisors of***** as ok before being put to use.移动式脚手架不得人力搬运,必须配有脚轮;所有脚轮都须配有自锁装置,使移动脚手架在使用时保持不动.The movable scaffold must be handled with castors。 No manual efforts are allowed in this regard; all castors are equipped with self-locking device, which serves to hold the movable scaffold still when it is use。移动式脚手架的作业平台必须满铺脚手板,临边必须搭设踢脚板。Boards must be...
