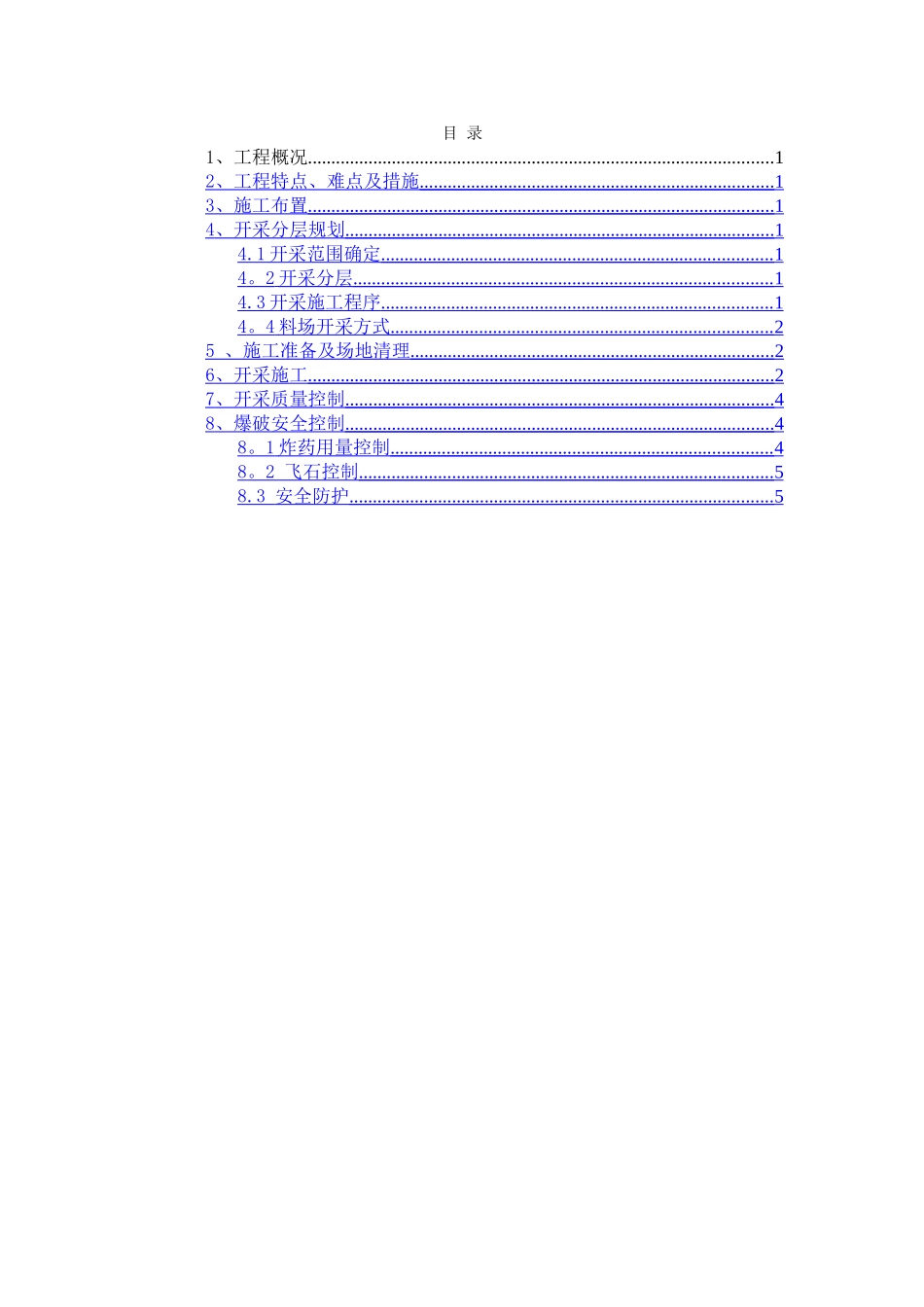

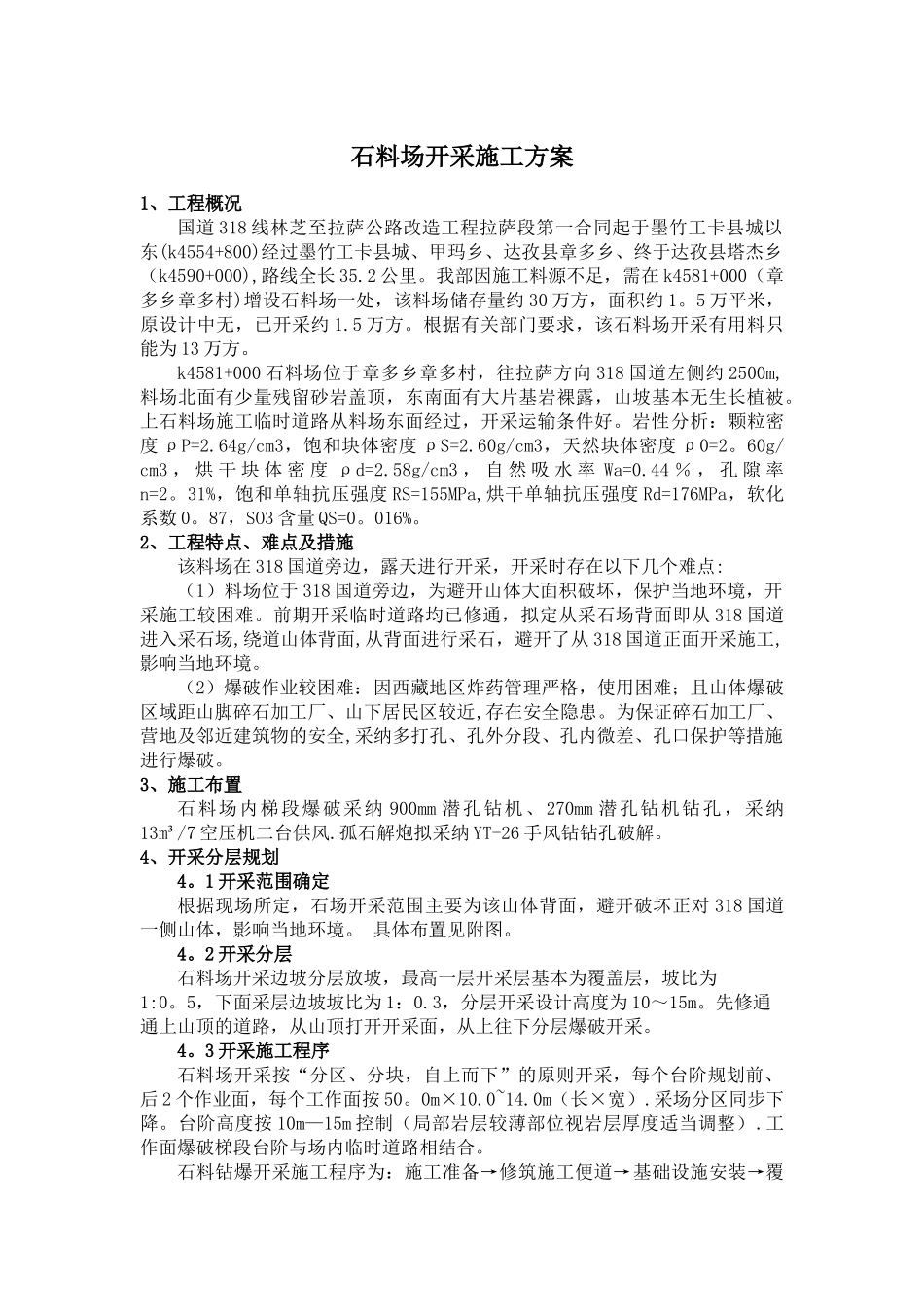

石料场开采施工方案目 录1、工程概况....................................................................................................12 、工程特点、难点及措施 ............................................................................ 1 3 、施工布置 .................................................................................................... 1 4 、开采分层规划 ............................................................................................ 1 4.1 开采范围确定 .................................................................................... 1 4 。 2 开采分层 .......................................................................................... 1 4.3 开采施工程序 .................................................................................... 1 4 。 4 料场开采方式 .................................................................................. 2 5 、施工准备及场地清理 .............................................................................. 2 6 、开采施工 .................................................................................................... 2 7 、开采质量控制 ............................................................................................ 4 8 、爆破安全控制 ............................................................................................ 4 8 。 1 炸药用量控制 .................................................................................. 4 8 。 2 飞石控制 ......................................................................................... 5 8.3 安全防护 ........................................................................................... 5 石料场开采施工方案1、工程概况国道 318 线林芝至拉萨公路改造工程拉萨段第一合同起于墨竹工卡县城以东(k4554+800)经过墨竹工卡县城、甲玛乡、达孜县章多乡、终于达孜县塔杰乡(k4590+000),路线全长 35.2 公里。我部因施工料源不足,需在 k4581+000(章多乡章多村)增设石料场一处,该料场储存量...
