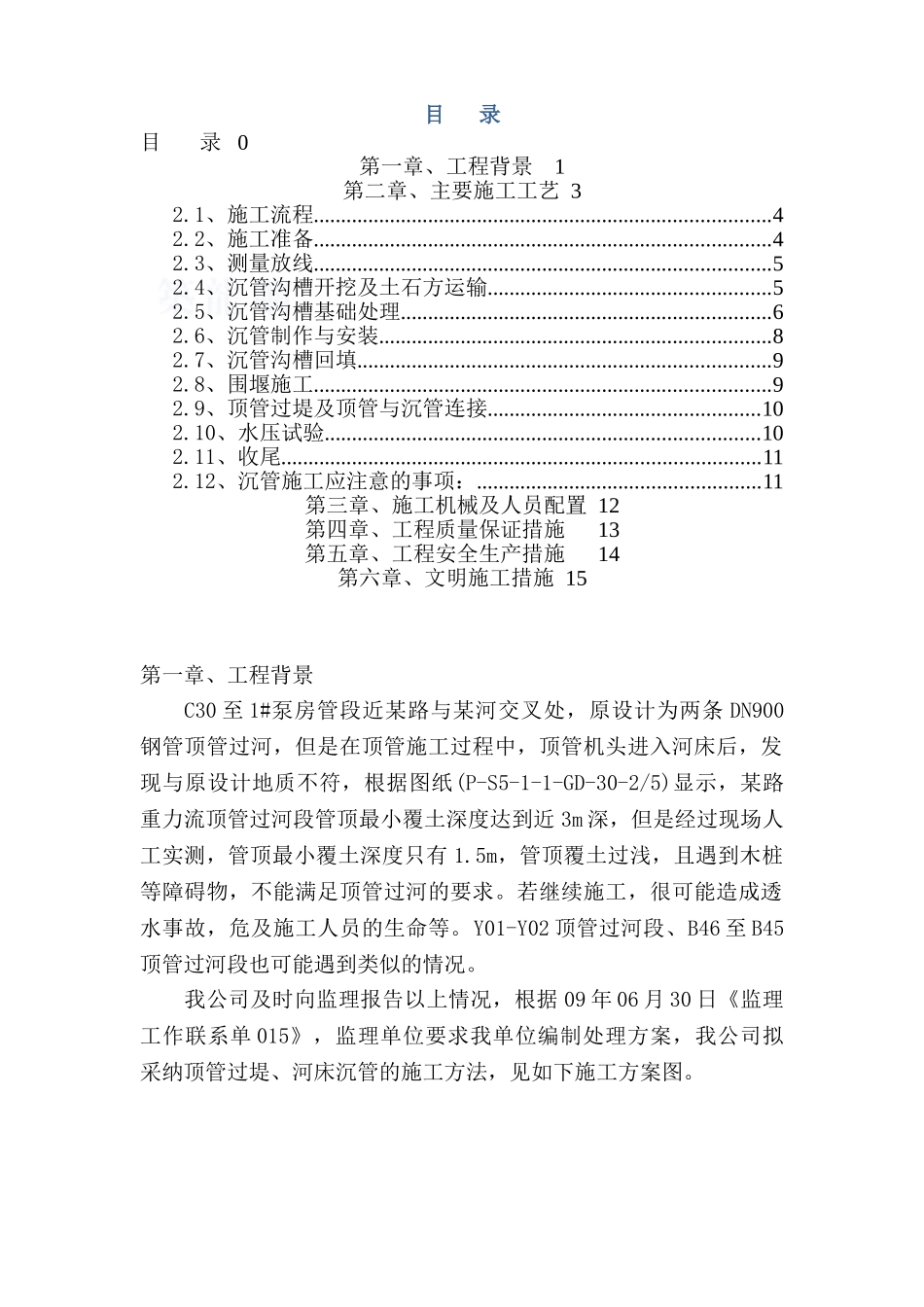

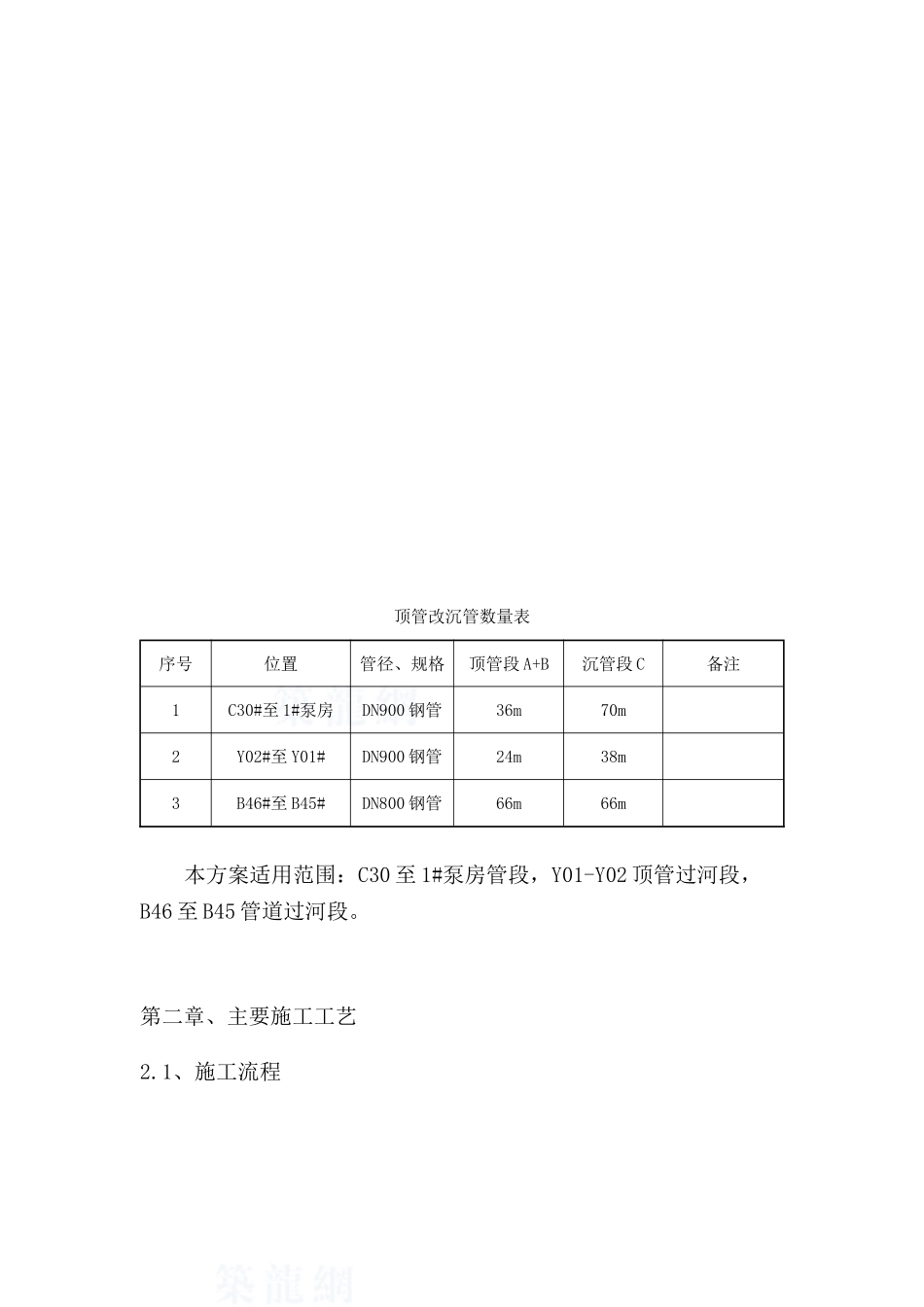

过河顶管改沉管专项施工方案编制单位: 编 制 人: 审 核 人: 编制日期: 二○○九年七月 目 录目 录 0第一章、工程背景1第二章、主要施工工艺 32.1、施工流程....................................................................................42.2、施工准备....................................................................................42.3、测量放线....................................................................................52.4、沉管沟槽开挖及土石方运输....................................................52.5、沉管沟槽基础处理....................................................................62.6、沉管制作与安装........................................................................82.7、沉管沟槽回填............................................................................92.8、围堰施工....................................................................................92.9、顶管过堤及顶管与沉管连接..................................................102.10、水压试验................................................................................102.11、收尾........................................................................................112.12、沉管施工应注意的事项:....................................................11第三章、施工机械及人员配置 12第四章、工程质量保证措施13第五章、工程安全生产措施14第六章、文明施工措施 15第一章、工程背景C30 至 1#泵房管段近某路与某河交叉处,原设计为两条 DN900钢管顶管过河,但是在顶管施工过程中,顶管机头进入河床后,发现与原设计地质不符,根据图纸(P-S5-1-1-GD-30-2/5)显示,某路重力流顶管过河段管顶最小覆土深度达到近 3m 深,但是经过现场人工实测,管顶最小覆土深度只有 1.5m,管顶覆土过浅,且遇到木桩等障碍物,不能满足顶管过河的要求。若继续施工,很可能造成透水事故,危及施工人员的生命等。Y01-Y02 顶管过河段、B46 至 B45顶管过河段也可能遇到类似的情况。我公司及时向监理报告以上情况,根据 09 年 06 月 30 日《监理工作联系单 015》,监理单位要求我单位编制处理方案,我公司拟采纳顶管过堤、河床沉管的施工方法,见如下施工...
