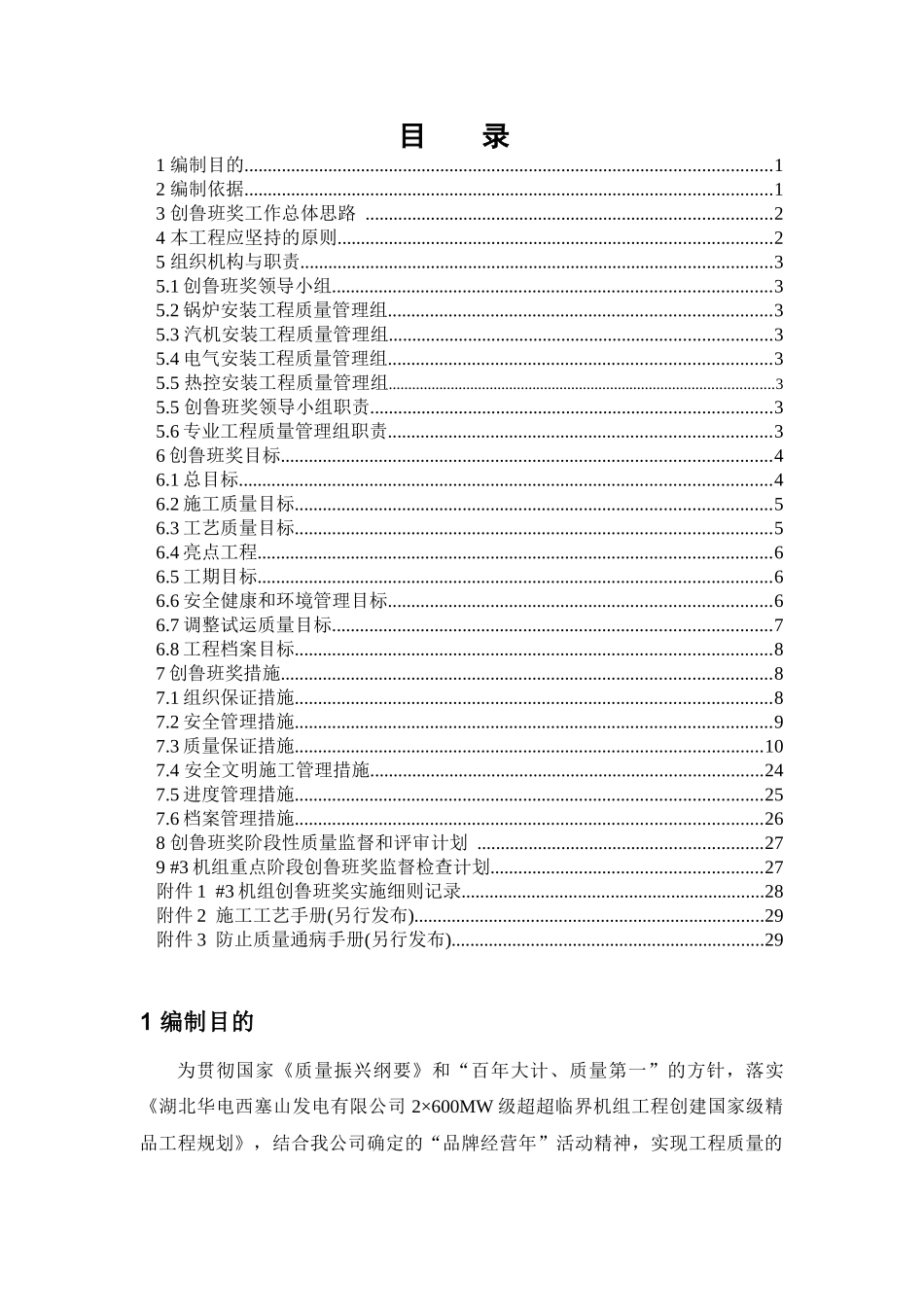

湖北华电西塞山发电有限公司2×600MW级机组工程黄石西塞山电厂安装工程确保鲁班奖工作策划(B版)批准/日期:审核/日期:编制/日期:湖北电建二公司西塞山二期项目部2009年8月1日发布2009年8月1日实施1目录1编制目的.................................................................................................................12编制依据.................................................................................................................13创鲁班奖工作总体思路.......................................................................................24本工程应坚持的原则.............................................................................................25组织机构与职责.....................................................................................................35.1创鲁班奖领导小组..............................................................................................35.2锅炉安装工程质量管理组..................................................................................35.3汽机安装工程质量管理组..................................................................................35.4电气安装工程质量管理组..................................................................................35.5热控安装工程质量管理组...................................................................................................35.5创鲁班奖领导小组职责......................................................................................35.6专业工程质量管理组职责..................................................................................36创鲁班奖目标.........................................................................................................46.1总目标..................................................................................................................46.2施工质量目标......................................................................................................56.3工艺质量目标......................................................................................................56.4亮点工程..............................................................................................................66.5工期目标..............................................................................................................66.6安全健康和环境管理目标..................................................................................66.7调整试运质量目标..............................................................................................76.8工程档案目标......................................................................................................87创鲁班奖措施.........................................................................................................87.1组织保证措施......................................................................................................87.2安全管理措施......................................................................................................97.3质量保证措施....................................................................................................107.4安全文明施工管理措施....................................................................................247.5进度管理措施....................................................................................................257.6档案管理...
