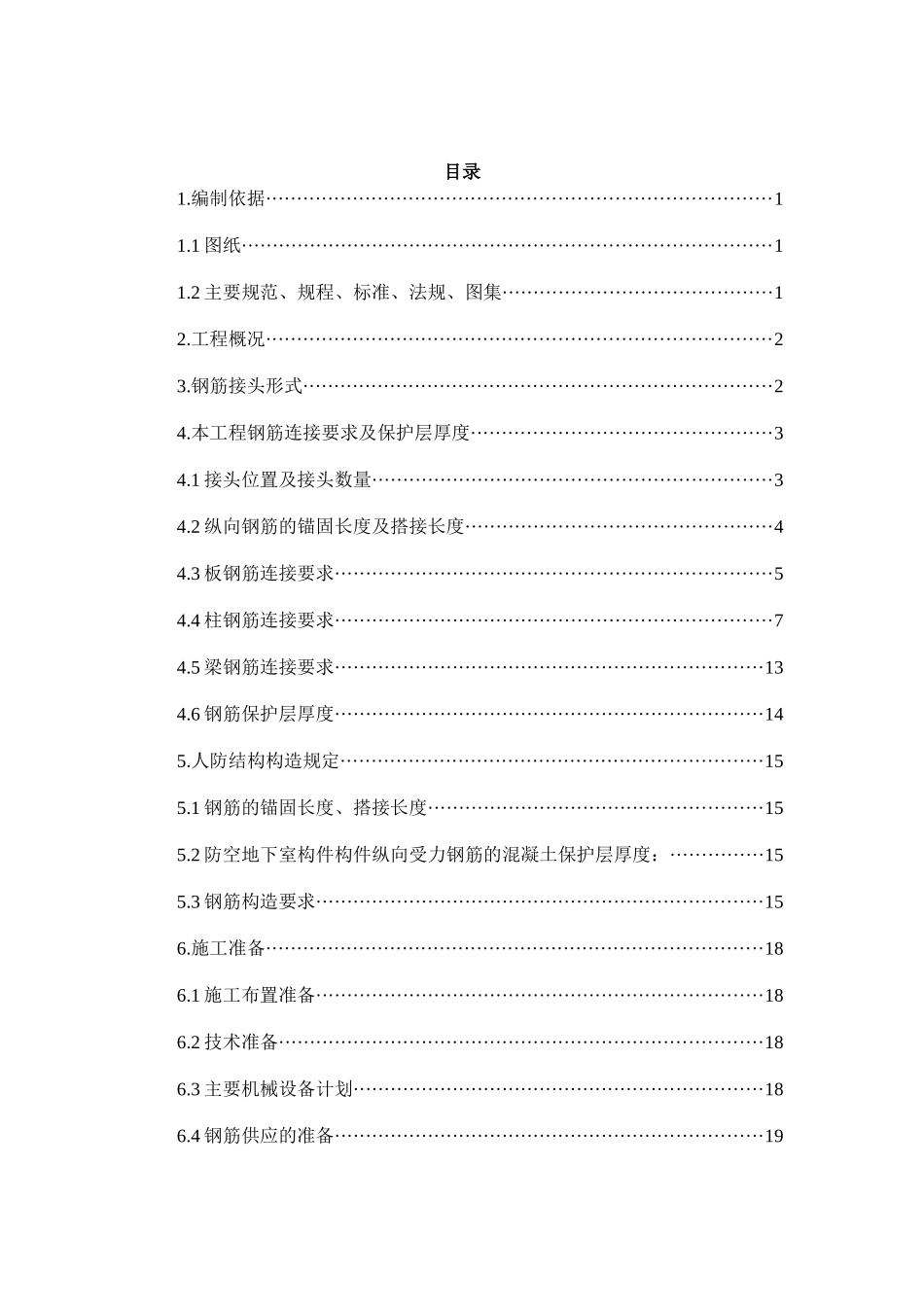

三亚俄罗斯旅游度假城一期第三标段工程钢筋施工方案编制人:审核人:审批人:编制单位:三亚俄罗斯旅游度假城一期第三标段工程项目部编制日期:目录1
编制依据·················································································11
1图纸·····················································································11
2主要规范、规程、标准、法规、图集···········································12
工程概况·················································································23
钢筋接头形式···········································································24
本工程钢筋连接要求及保护层厚度················································34
1接头位置及接头数量································································34
2纵向钢筋的锚固长度及搭接长度·················································44
3板钢筋连接要求······································································54
4柱钢筋连接要求················
