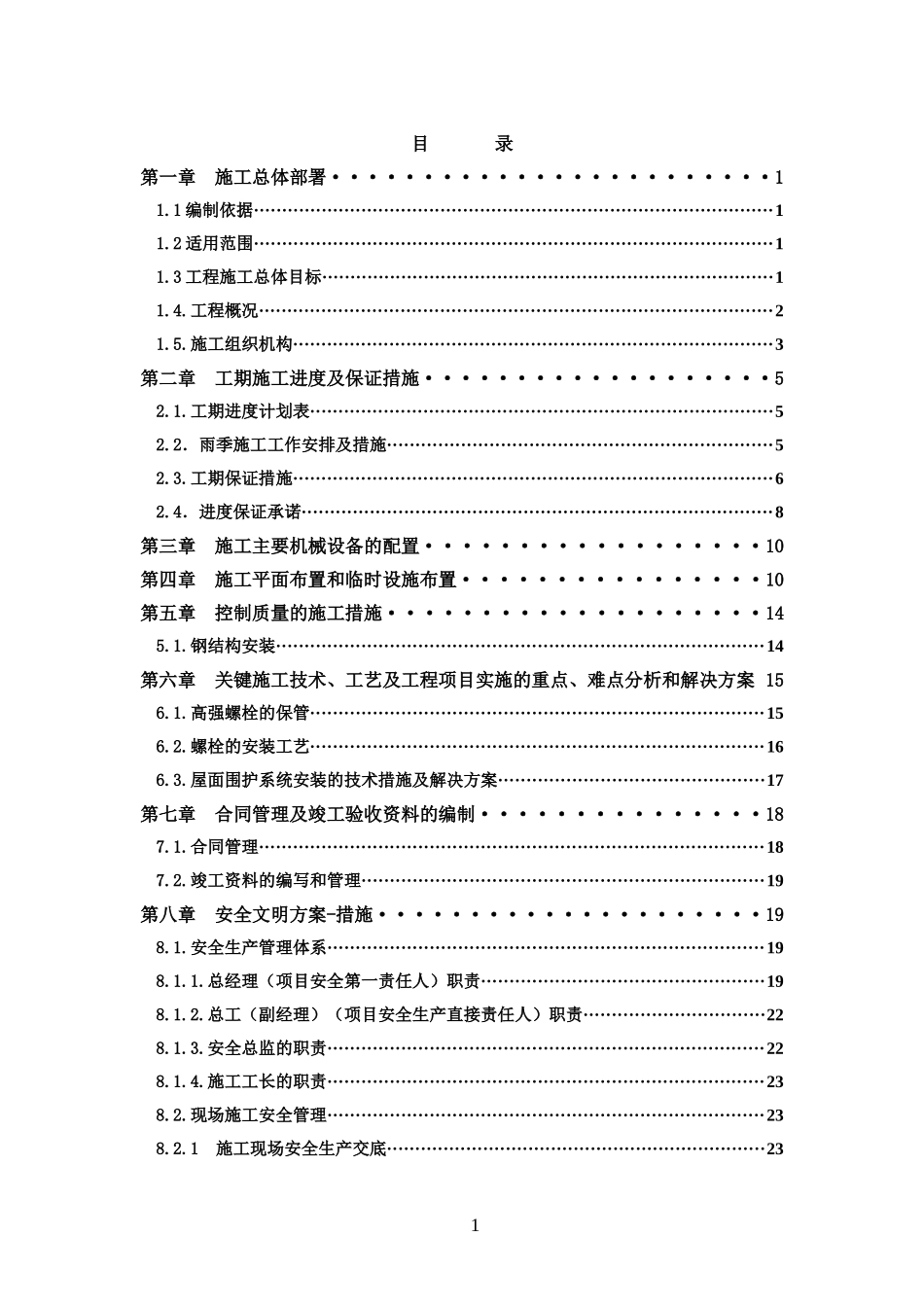

亨氏(中国)佛山一期婴幼儿米粉项目钢结构安装工程施工组织设计1四川省第六建筑有限公司二○一三年八月十日2目录第一章施工总体部署························11.1编制依据····························································································11.2适用范围····························································································11.3工程施工总体目标················································································11.4.工程概况···························································································21.5.施工组织机构·····················································································3第二章工期施工进度及保证措施···················52.1.工期进度计划表··················································································52.2.雨季施工工作安排及措施····································································52.3.工期保证措施·····················································································62.4.进度保证承诺···················································································8第三章施工主要机械设备的配置··················10第四章施工平面布置和临时设施布置················10第五章控制质量的施工措施····················145.1.钢结构安装······················································································14第六章关键施工技术、工艺及工程项目实施的重点、难点分析和解决方案156.1.高强螺栓的保管················································································156.2.螺栓的安装工艺················································································166.3.屋面围护系统安装的技术措施及解决方案···············································17第七章合同管理及竣工验收资料的编制···············187.1.合同管理·························································································187.2.竣工资料的编写和管理·······································································19第八章安全文明方案-措施···········...
