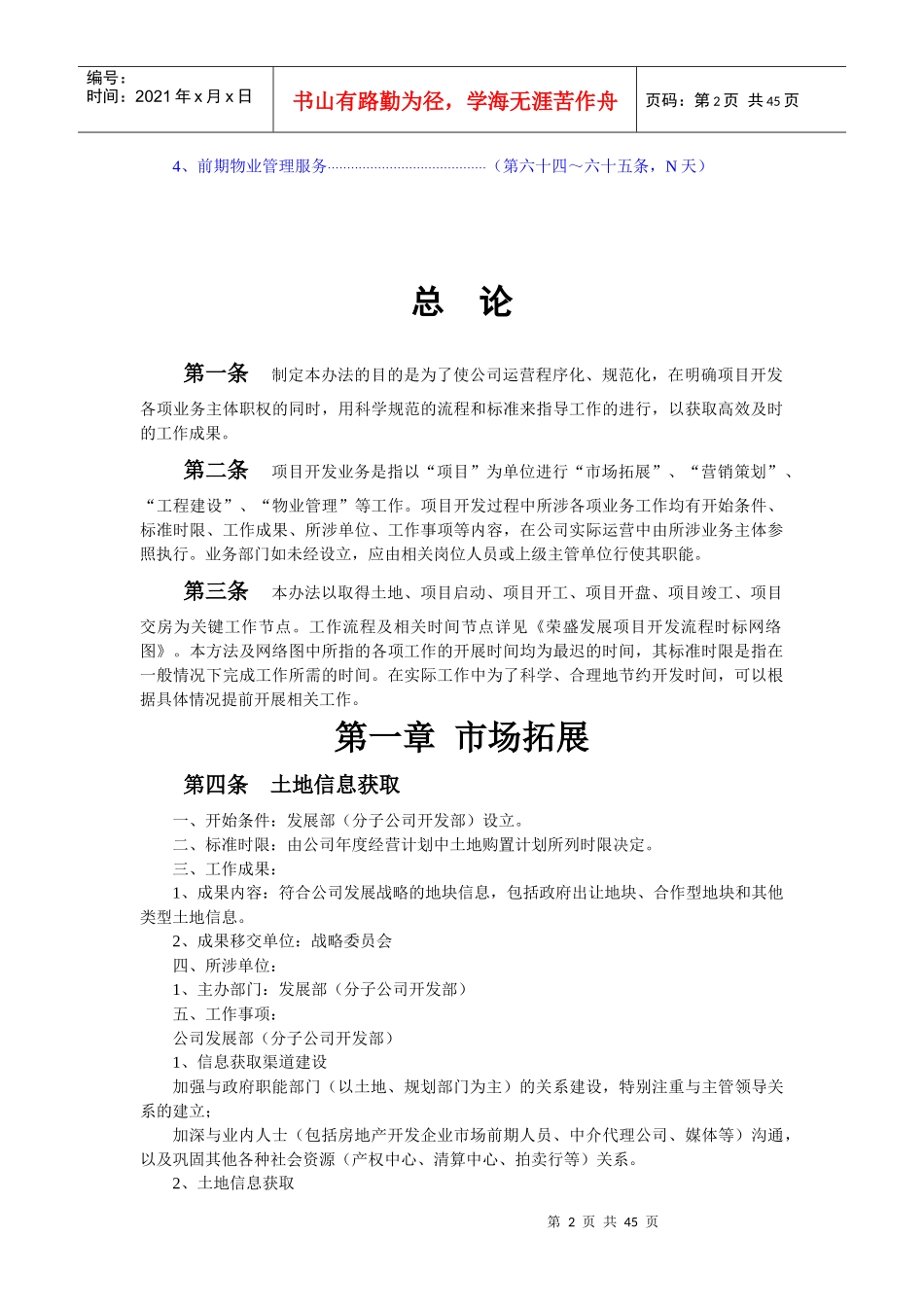

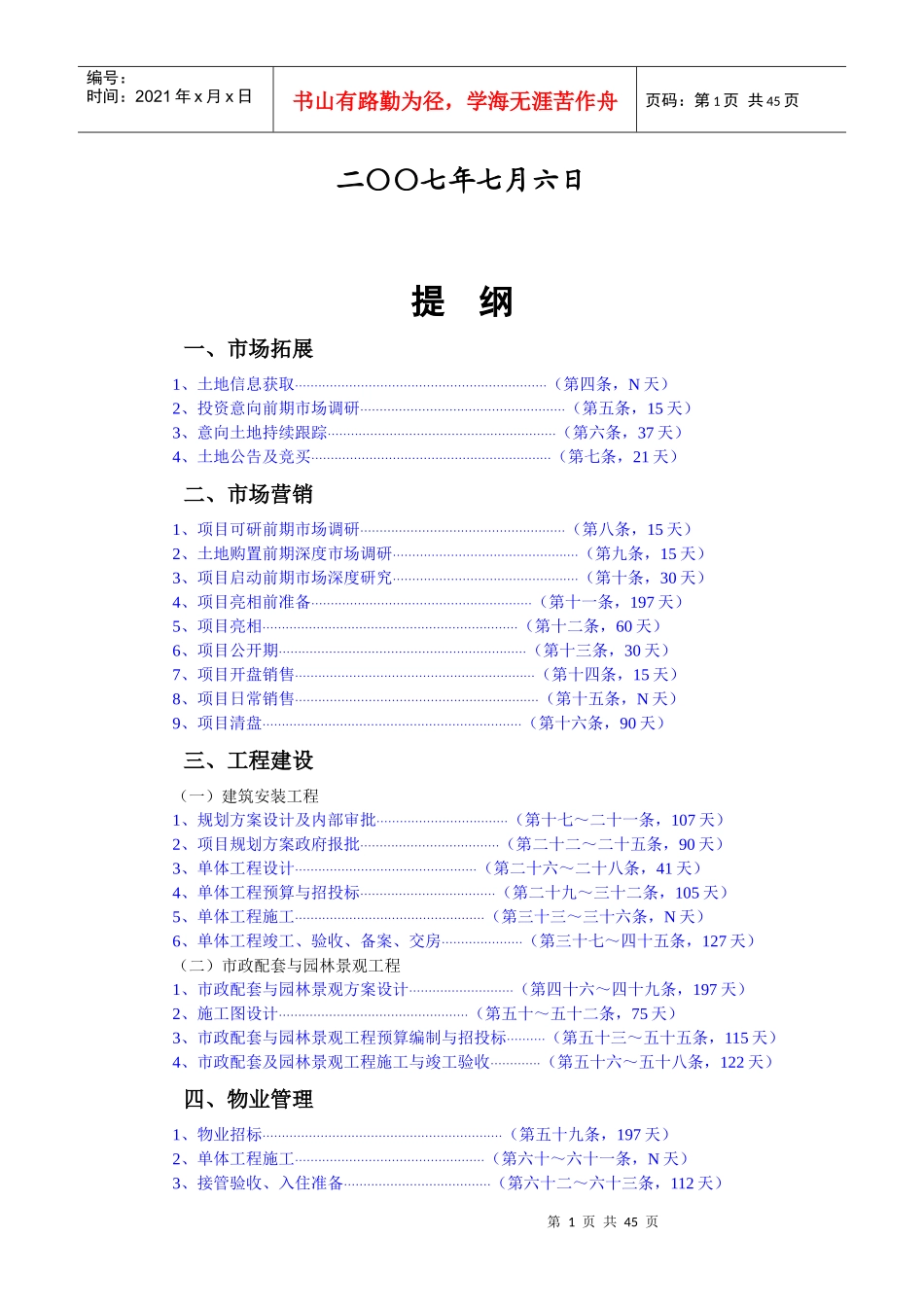

荣盛房地产发展股份有限公司项目开发业务规范(试行)第1页共45页编号:时间:2021年x月x日书山有路勤为径,学海无涯苦作舟页码:第1页共45页二〇〇七年七月六日提纲一、市场拓展1、土地信息获取·································································(第四条,N天)2、投资意向前期市场调研·····················································(第五条,15天)3、意向土地持续跟踪···························································(第六条,37天)4、土地公告及竞买······························································(第七条,21天)二、市场营销1、项目可研前期市场调研·····················································(第八条,15天)2、土地购置前期深度市场调研················································(第九条,15天)3、项目启动前期市场深度研究················································(第十条,30天)4、项目亮相前准备·························································(第十一条,197天)5、项目亮相··································································(第十二条,60天)6、项目公开期································································(第十三条,30天)7、项目开盘销售······························································(第十四条,15天)8、项目日常销售·······························································(第十五条,N天)9、项目清盘···································································(第十六条,90天)三、工程建设(一)建筑安装工程1、规划方案设计及内部审批··································(第十七~二十一条,107天)2、项目规划方案政府报批····································(第二十二~二十五条,90天)3、单体工程设计···············································(第二十六~二十八条,41天)4、单体工程预算与招投标···································(第二十九~三十二条,105天)5、单体工程施工·················································(第三十三~三十六条,N天)6、单体工程竣工、验收、备案、交房·····················(第三十七~四十五条,127天)(二)市政配套与园林景观工程1、市政配套与园林景观方案设计···························(第四十六~四十九条,197天)2、施工图设计·················································(第五十~五十二条,75天)3、市政配套与园林景观工程预算编制与招投标··········(第五十三~五十五条,115天)4、市政配套及园林景观工...
