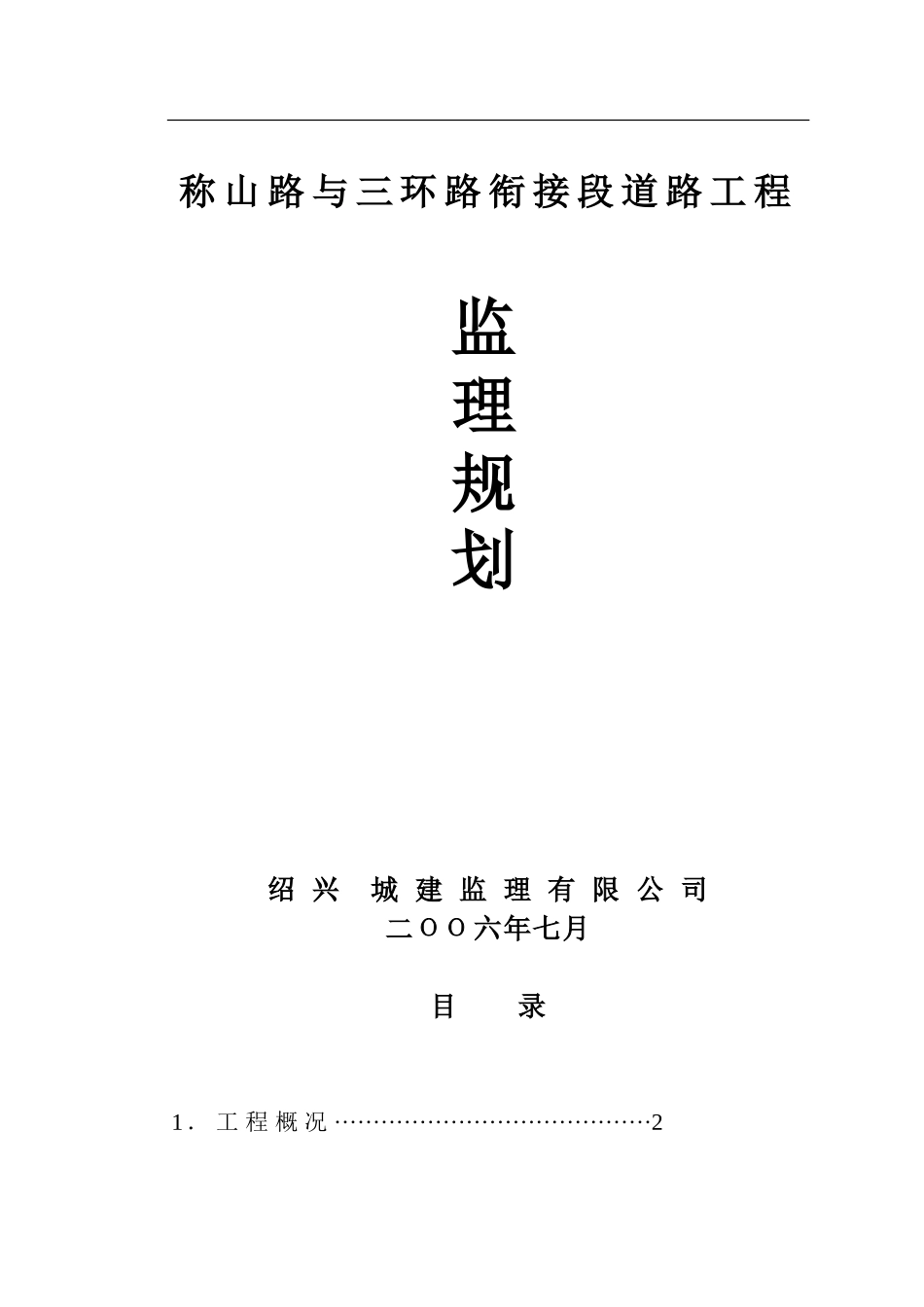

称山路与三环路衔接段道路工程监理规划绍兴城建监理有限公司二ΟΟ六年七月目录1.工程概况·········································22.监理目的与任务···································23.监理组织·········································54.监理工作开展·····································94

1监理根据·········································94
2监理工作内容·····································114
3监理工作程序·····································174
4监理工作措施·····································234

5监理工作制度·····································25称山路与三环路衔接段道路工程监理规划1.工程概况工程名称:衔接段道路工程建立:上虞政工程理中心施工:浙江舜江建立集团设计:上虞城建规划设计院工程:119万元施工工:60天质量目的:优良工程概要本工程为道路拓宽工程北起三环路南至王充路
设计路宽28
3米混合车道+两侧对称3米人行道
道路等级为Ⅱ级城主干路设计车速40Km/h设计年限:沥青路面15年;道路机构层〔自上而下〕:车行道为4cm细粒式沥青混凝土、8cm粗粒式沥青混凝土、20cm5水泥稳定碎石垫层、15cm3水泥稳定碎石垫层、≥80塘渣垫层下为素土夯实本工程只做道路拓宽局部2~3m
人行道6cm厚混凝土路面砖2cmM7
5水泥砂浆找平层15cmC20砼30塘渣垫层下为素土夯实
