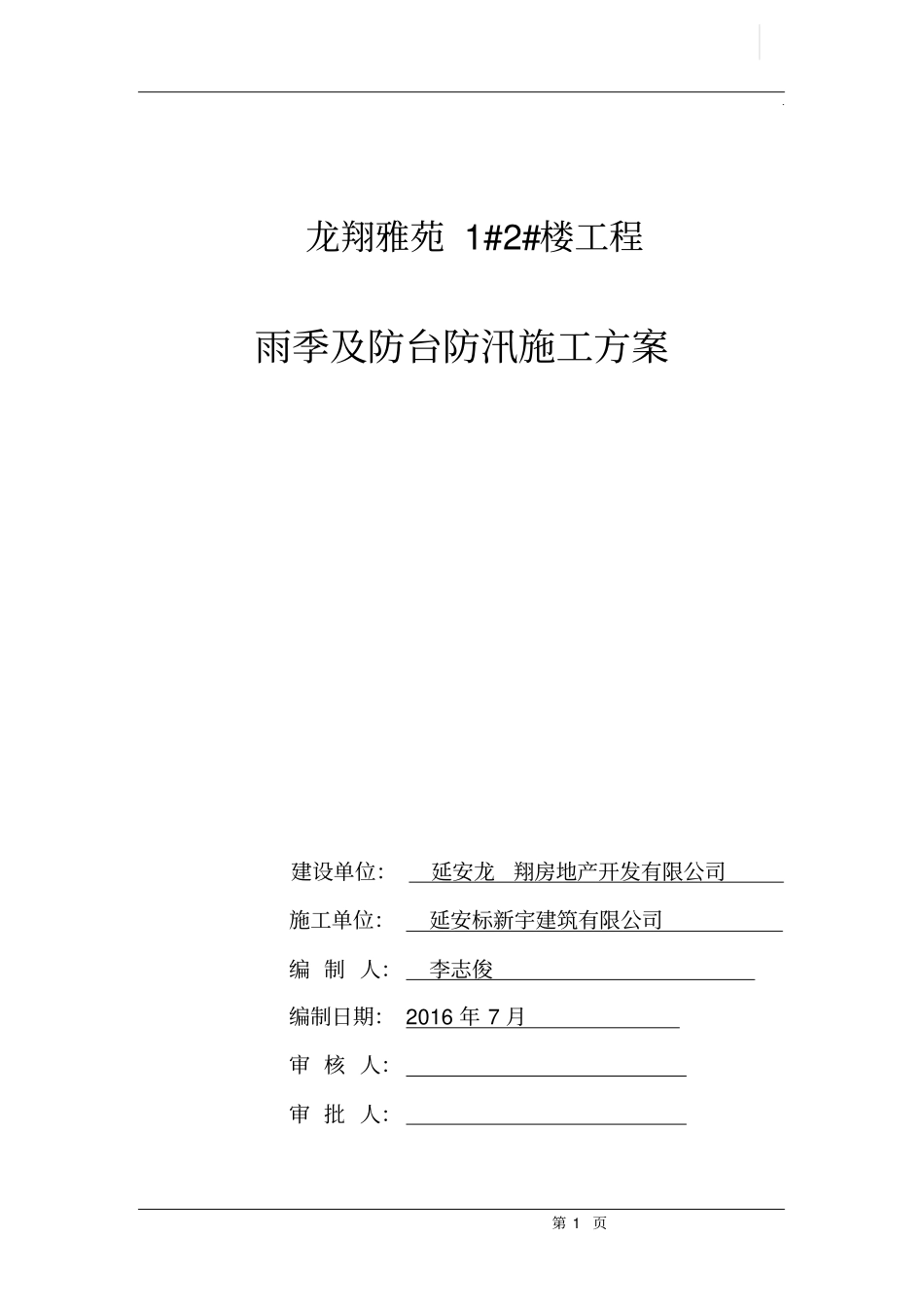

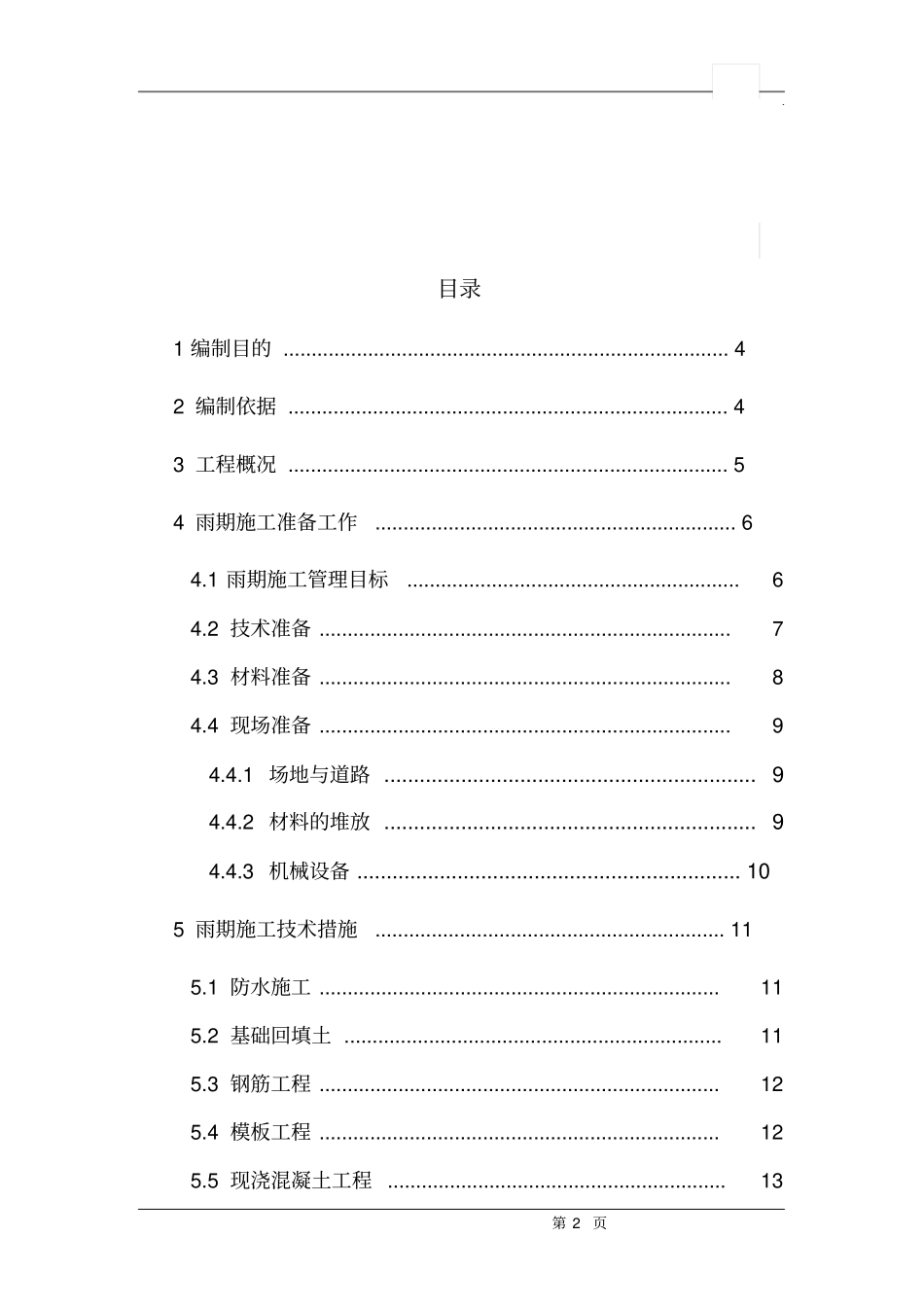

第1页龙翔雅苑1#2#楼工程雨季及防台防汛施工方案建设单位:延安龙翔房地产开发有限公司施工单位:延安标新宇建筑有限公司编制人:李志俊编制日期:2016年7月审核人:审批人:第2页目录1编制目的...............................................................................42编制依据..............................................................................43工程概况..............................................................................54雨期施工准备工作................................................................64.1雨期施工管理目标...........................................................64.2技术准备.........................................................................74.3材料准备.........................................................................84.4现场准备.........................................................................94.4.1场地与道路...............................................................94.4.2材料的堆放...............................................................94.4.3机械设备.................................................................105雨期施工技术措施..............................................................115.1防水施工.......................................................................115.2基础回填土...................................................................115.3钢筋工程.......................................................................125.4模板工程.......................................................................125.5现浇混凝土工程............................................................13第3页5.6砌筑工程.......................................................................145.7脚手架工程...................................................................145.8避雷措施.......................................................................155.9专业安装工程................................................................156防台防汛工程......................................................................166.1防台防汛工作内容.........................................................166.2职责分工.......................................................................176.3防台防汛重要设施、重点部位和要点.............................176.4防台防汛应急预案.........................................................186.5事故处理措施................................................................196.6信息沟通及后勤保证措施...............................................196.7防台防汛领导小组.........................................................207技术保证措施......................................................................218雨期施工安全措施..............................................................21第4页1编制目的为了切实做好雨季施工及防台防汛减灾工作,保证雨季的正常施工,我公司遵循预防为主、常备不懈的方针,落实各项技术、安全防范措施,并在遭受台风、暴雨等自然灾害袭击时,能及时、高效、有序地开展防风抗洪抢险、救灾工作,确保群众生命财产安全,最大限度地减少灾害损失,特制定本预案。2编制依据2.1施工图纸2.2主要规范、规程《工程测量规范》GBJ50026-2007《地下工程防水技术规范》GB50108-2008《人民防空工程施工及验收规范》GB50134-2004《混凝土泵送施工技术规程》JGJ/T10-95《混凝土外加剂应用技术规范》GB50119-2003《建筑工程施工质量验收统一标准》GB50300-2001《建筑节能工程施工质量验收规范》GB50411-2007《砌体工程施工及验收规范》GB50...
