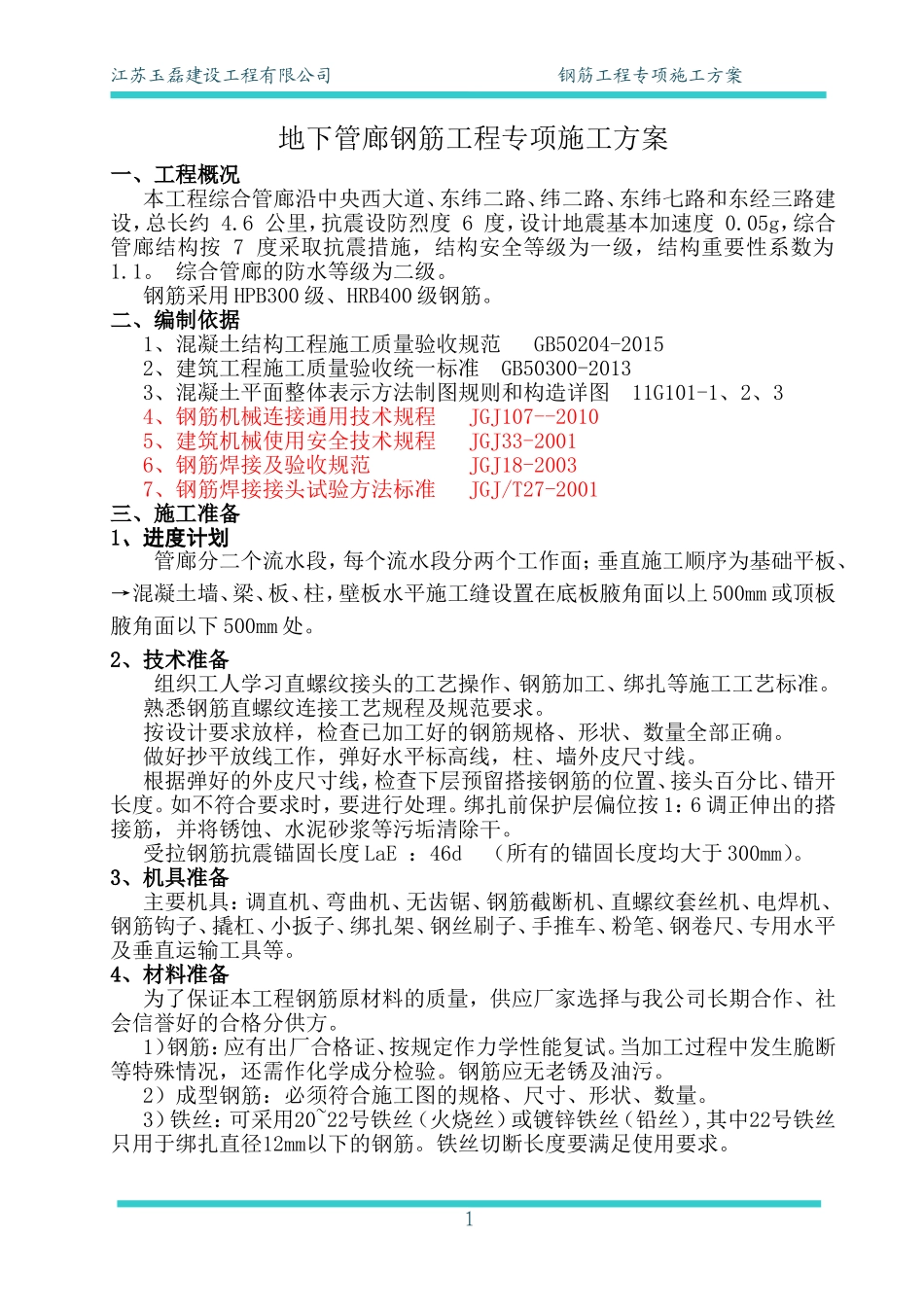

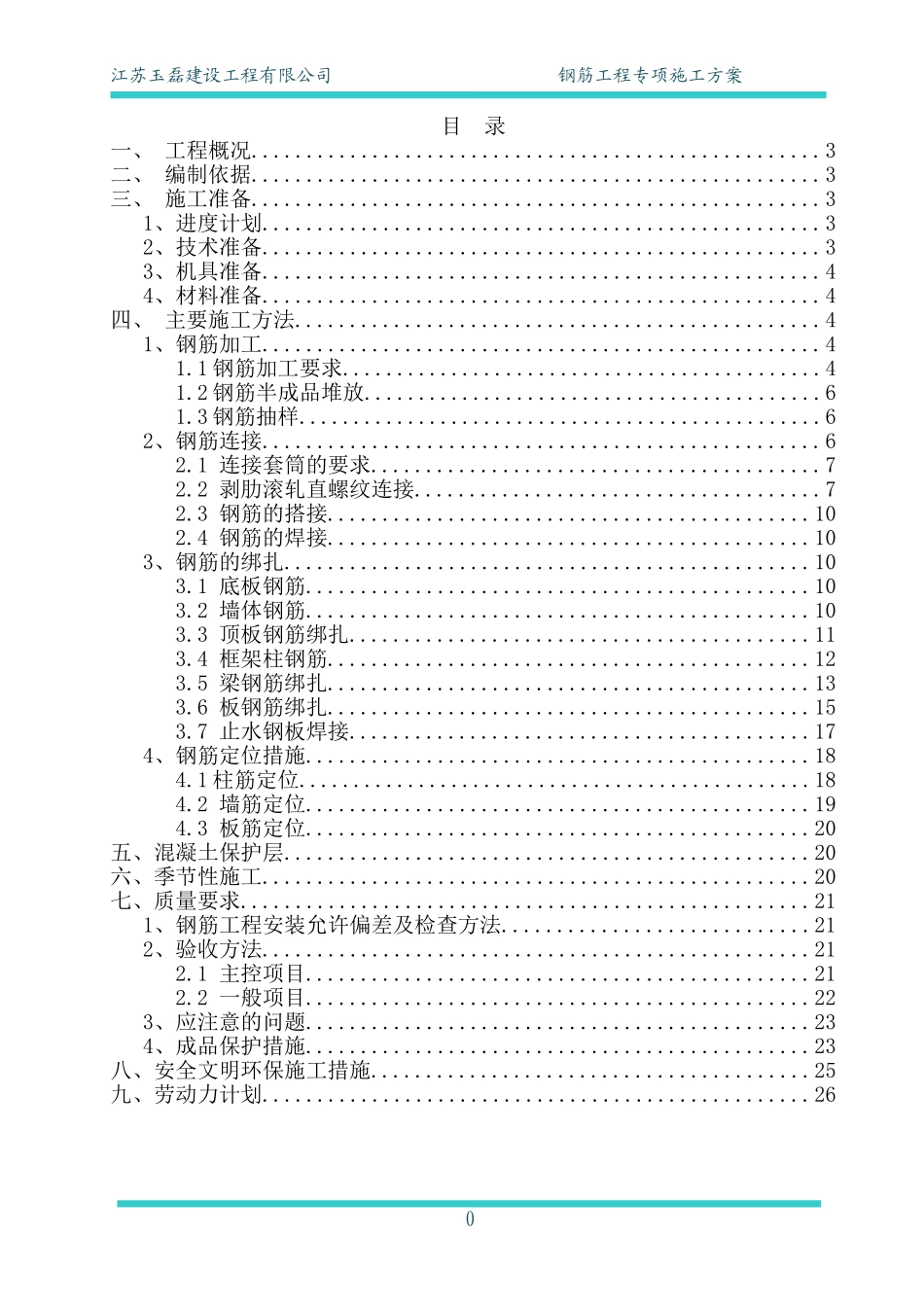

二连浩特跨境经济合作区管廊工程钢筋工程施工方案编制:审核:审批:江苏玉磊建设工程有限公司2018年5月15日江苏玉磊建设工程有限公司钢筋工程专项施工方案目录一、工程概况....................................................3二、编制依据....................................................3三、施工准备....................................................31、进度计划...................................................32、技术准备...................................................33、机具准备...................................................44、材料准备...................................................4四、主要施工方法................................................41、钢筋加工...................................................41.1钢筋加工要求............................................41.2钢筋半成品堆放..........................................61.3钢筋抽样................................................62、钢筋连接...................................................62.1连接套筒的要求.........................................72.2剥肋滚轧直螺纹连接.....................................72.3钢筋的搭接............................................102.4钢筋的焊接............................................103、钢筋的绑扎................................................103.1底板钢筋..............................................103.2墙体钢筋..............................................103.3顶板钢筋绑扎..........................................113.4框架柱钢筋............................................123.5梁钢筋绑扎............................................133.6板钢筋绑扎............................................153.7止水钢板焊接..........................................174、钢筋定位措施..............................................184.1柱筋定位...............................................184.2墙筋定位..............................................194.3板筋定位..............................................20五、混凝土保护层................................................20六、季节性施工..................................................20七、质量要求....................................................211、钢筋工程安装允许偏差及检查方法............................212、验收方法..................................................212.1主控项目..............................................212.2一般项目..............................................223、应注意的问题..............................................234、成品保护措施..............................................23八、安全文明环保施工措施........................................25九、劳动力计划..................................................260江苏玉磊建设工程有限公司钢筋工程专项施工方案地下管廊钢筋工程专项施工方案一、工程概况本工程综合管廊沿中央西大道、东纬二路、纬二路、东纬七路和东经三路建设,总长约4.6公里,抗震设防烈度6度,设计地震基本加速度0.05g,综合管廊结构按7度采取抗震措施,结构安全等级为一级,结构重要性系数为1.1。综合管廊的防水等级为二级。钢筋采用HPB300级、HRB400级钢筋。二、编制依据1、混凝土结构工程施工质量验收规范GB50204-20152、建筑工程施工质量验收统一标准GB50300-20133、混凝土平面整体表示方法制图规则和构造详图11G101-1、2、34、钢筋机械连接通用技术规程JGJ107--20105、建筑机械使用安全技术规程JGJ33-20016、钢筋焊接及验收规范JGJ18-20037、钢筋焊接接头试验方法标准JGJ/T27-2001三、施工准备1、进度计划管廊分二个流水段,每个流水段分两个工作面;...
