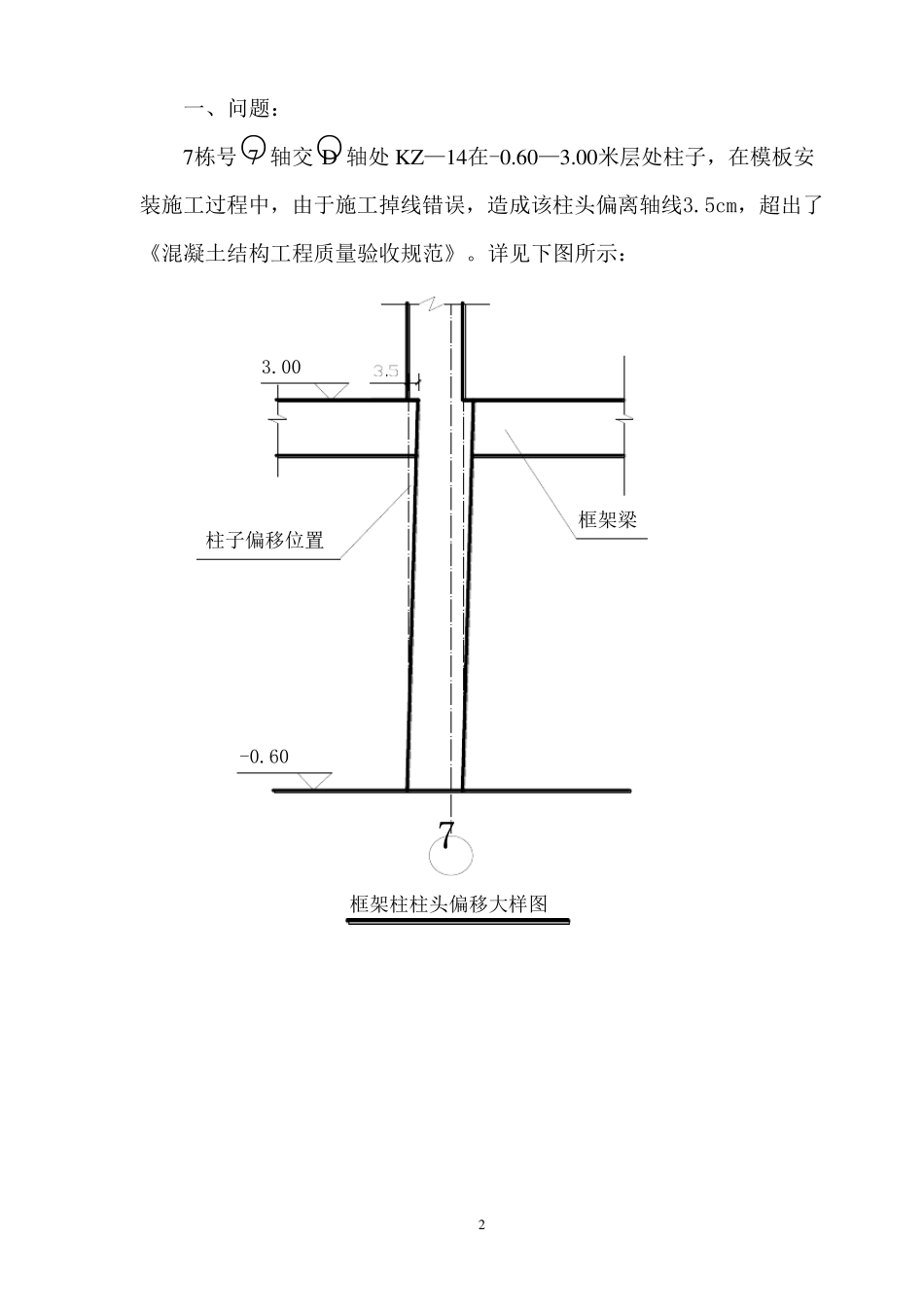

1 目 录 一、问题: ........................................................................................................ 2 二、解决方案:................................................................................................ 3 1 框架柱截面增大施工流程: ............................................................................................................ 3 2 混凝土面凿毛 ..................................................................................................................................... 3 3 植筋 ...................................................................................................................................................... 3 4 放置钢丝网 ......................................................................................................................................... 6 5 模板安装 ............................................................................................................................................. 6 6 混凝土浇筑 ......................................................................................................................................... 6 7 砼养护 ................................................................................................................................................ 8 2 一、问题: 7栋号○7 轴交○D 轴处KZ—14在-0.60—3.00米层处柱子,在模板安装施工过程中,由于施工掉线错误,造成该柱头偏离轴线3.5cm,超出了《混凝土结构工程质量验收规范》。详见下图所示: 框架柱柱头偏移大样图-0.603.007柱子偏移位置框架梁 3 二、解决方案: 将该处1.20米至3.00米段偏移面的柱侧面进行凿毛,植筋,铺设钢板网,安装模板,然后浇筑细石混凝土,其细石混凝土标号比原构件高一等级,保证该框架柱柱截面达到设计要求。 1 框架柱截面增大施工流程: 与KL18○7 —○8 轴段连接侧框架柱面凿毛→植筋→放置钢丝网→安装模板→浇筑混凝土→混凝土养护 2 混凝土面凿毛 将要补浇砼的柱侧面砼面进行凿毛,凿毛应凿到看到粗骨料,把表面浮浆凿除,把松动的石子清理干净。 3 ...
