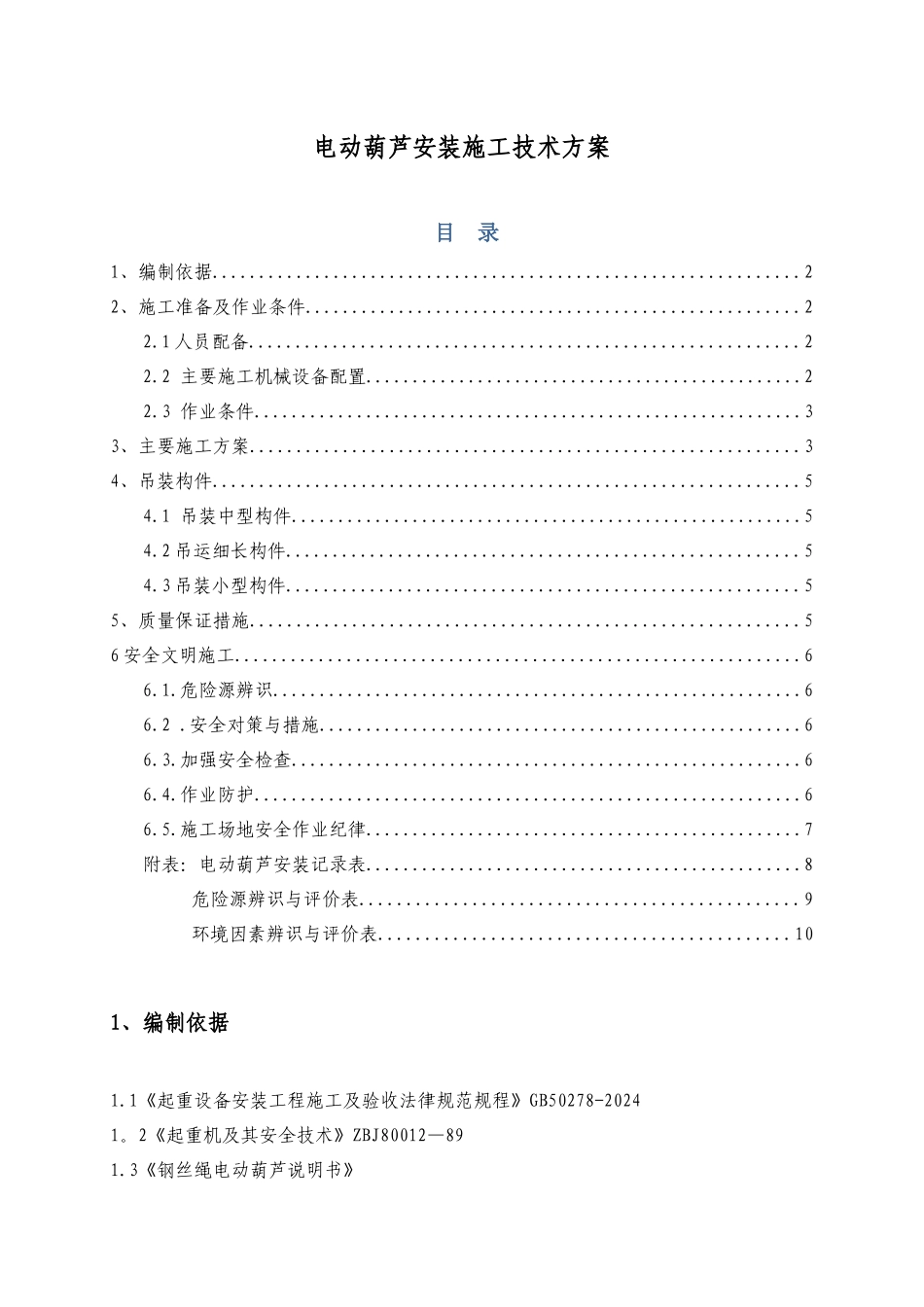

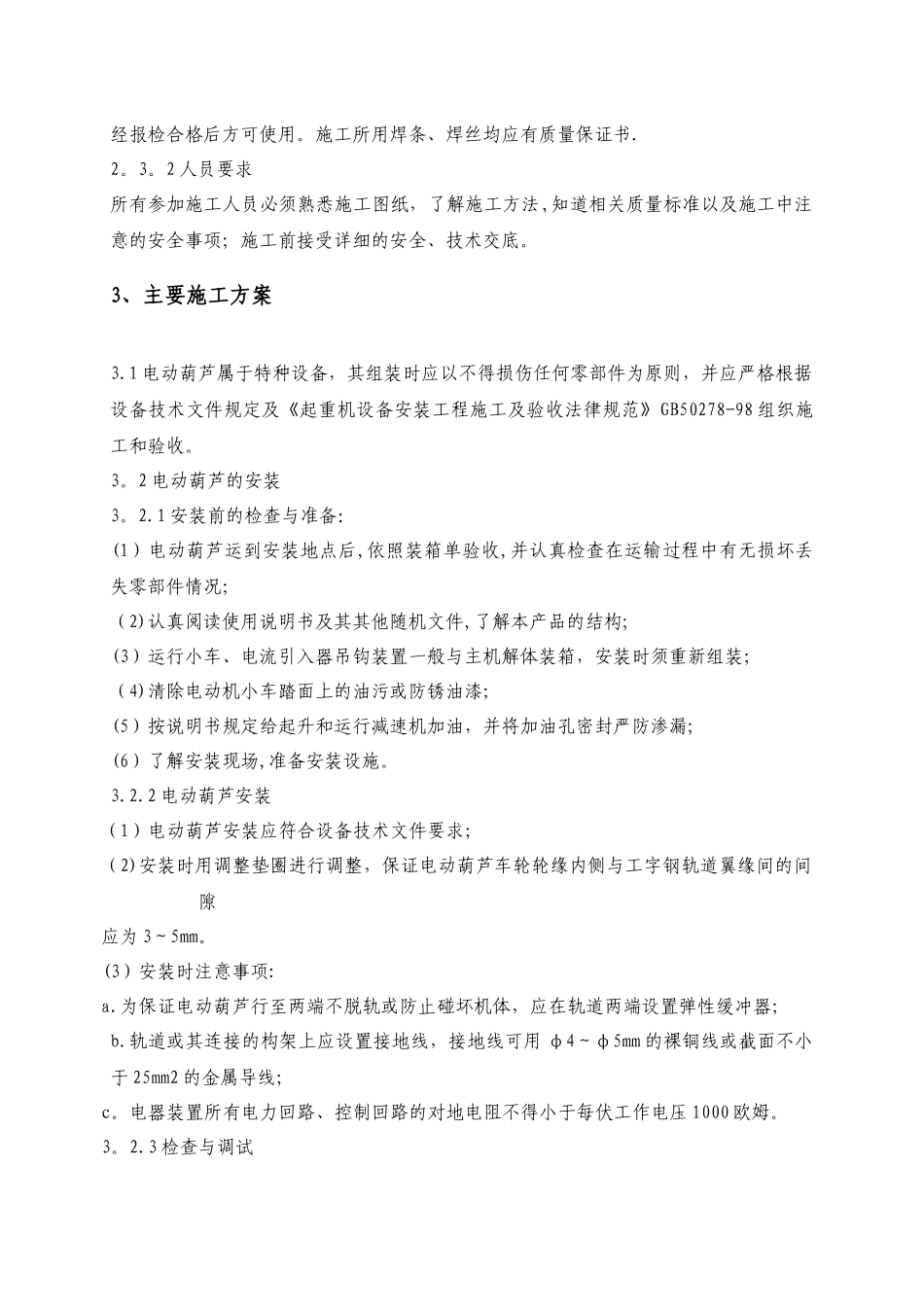

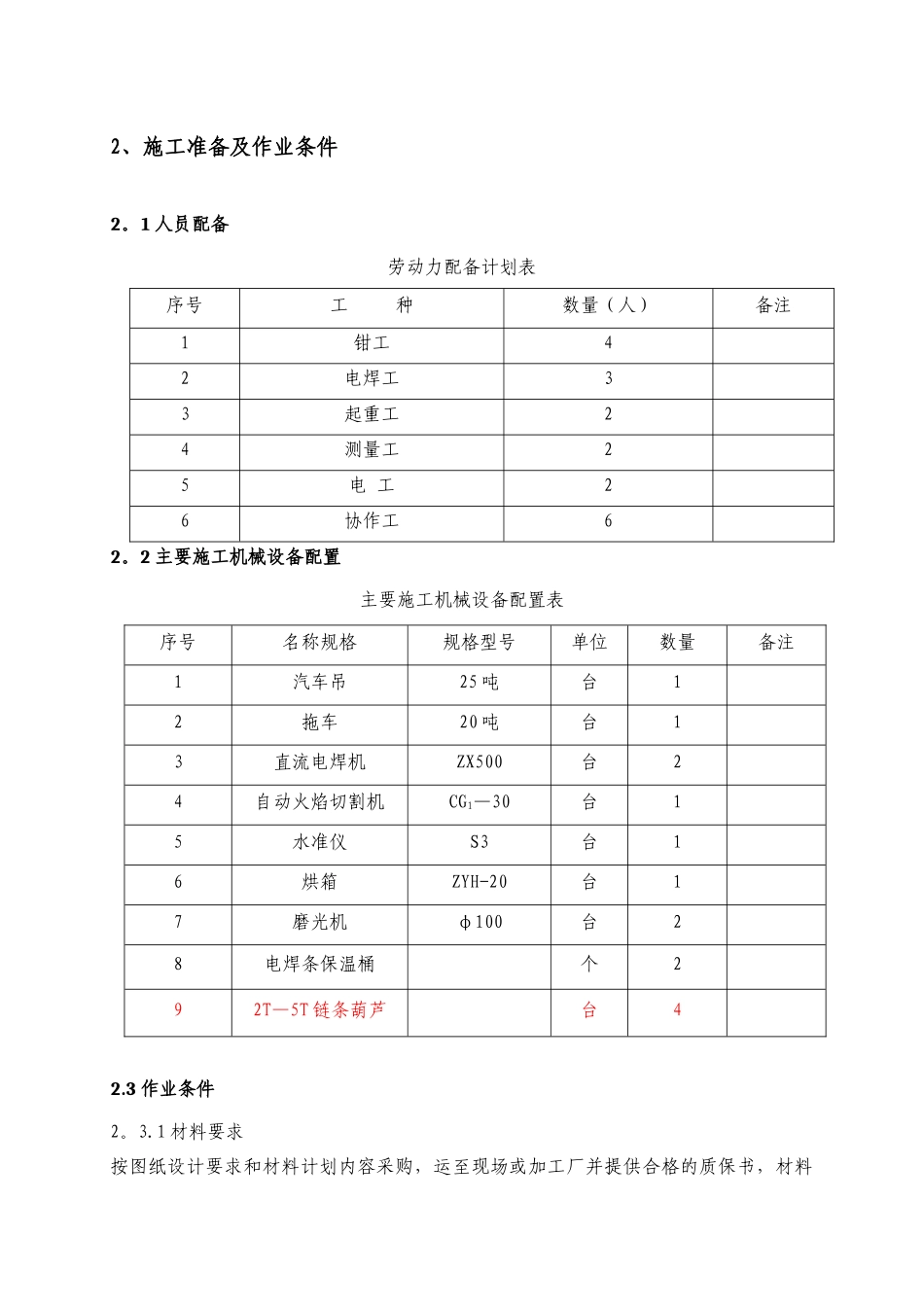

电动葫芦安装施工技术方案目 录1、编制依据...............................................................22、施工准备及作业条件.....................................................22.1 人员配备...........................................................22.2 主要施工机械设备配置...............................................22.3 作业条件...........................................................33、主要施工方案...........................................................34、吊装构件...............................................................54.1 吊装中型构件.......................................................54.2 吊运细长构件.......................................................54.3 吊装小型构件.......................................................55、质量保证措施...........................................................56 安全文明施工.............................................................66.1.危险源辨识.........................................................66.2 .安全对策与措施....................................................66.3.加强安全检查.......................................................66.4.作业防护...........................................................66.5.施工场地安全作业纪律...............................................7附表:电动葫芦安装记录表...............................................8危险源辨识与评价表...............................................9环境因素辨识与评价表............................................101、编制依据1.1《起重设备安装工程施工及验收法律规范规程》GB50278-20241。2《起重机及其安全技术》ZBJ80012—891.3《钢丝绳电动葫芦说明书》2、施工准备及作业条件2。1 人员配备劳动力配备计划表序号工 种数量(人)备注1钳工42电焊工33起重工24测量工25电 工26协作工62。2 主要施工机械设备配置主要施工机械设备配置表2.3 作业条件2。3.1 材料要求按图纸设计要求和材料计划内容采购,运至现场或加工厂并提供合格的质保书,材料序号名称规格规格型号单位数量备注1汽车吊25 吨台12拖车20 吨台13直流电焊机ZX500台24自动火焰切割机CG1—30台15...
