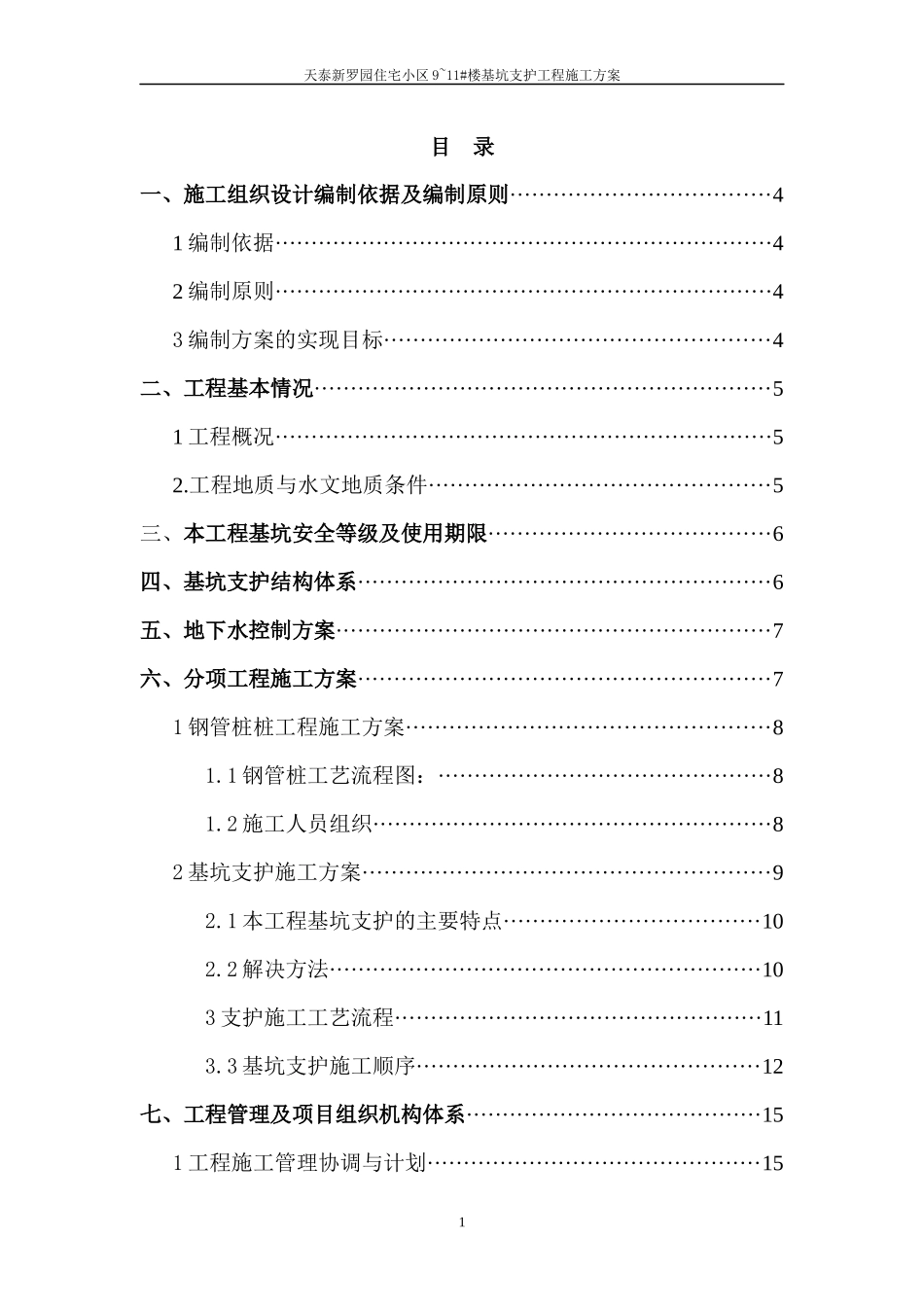

天泰新罗园住宅小区9~11#楼基坑支护工程施工方案天泰新罗住宅小区基坑支护工程施工方案编制:审核:1天泰新罗园住宅小区9~11#楼基坑支护工程施工方案批准:建设单位:青岛天泰新罗置地有限公司编制单位:青岛海川建设集团有限公司编制时间:2011年3月17日2天泰新罗园住宅小区9~11#楼基坑支护工程施工方案目录一、施工组织设计编制依据及编制原则····································41编制依据·····································································42编制原则·····································································43编制方案的实现目标·····················································4二、工程基本情况·······························································51工程概况·····································································52.工程地质与水文地质条件···············································5三、本工程基坑安全等级及使用期限·······································6四、基坑支护结构体系·························································6五、地下水控制方案····························································7六、分项工程施工方案·························································71钢管桩桩工程施工方案··················································81.1钢管桩工艺流程图:··············································81.2施工人员组织·······················································82基坑支护施工方案························································92.1本工程基坑支护的主要特点···································102.2解决方法····························································103支护施工工艺流程···················································113.3基坑支护施工顺序···············································12七、工程管理及项目组织机构体系·········································151工程施工管理协调与计划··············································151天泰新罗园住宅小区9~11#楼基坑支护工程施工方案1.1施工管理特点及针对措施······································151.2施工协调与配合··················································162工程项目组织机构体系·················································17八、...
