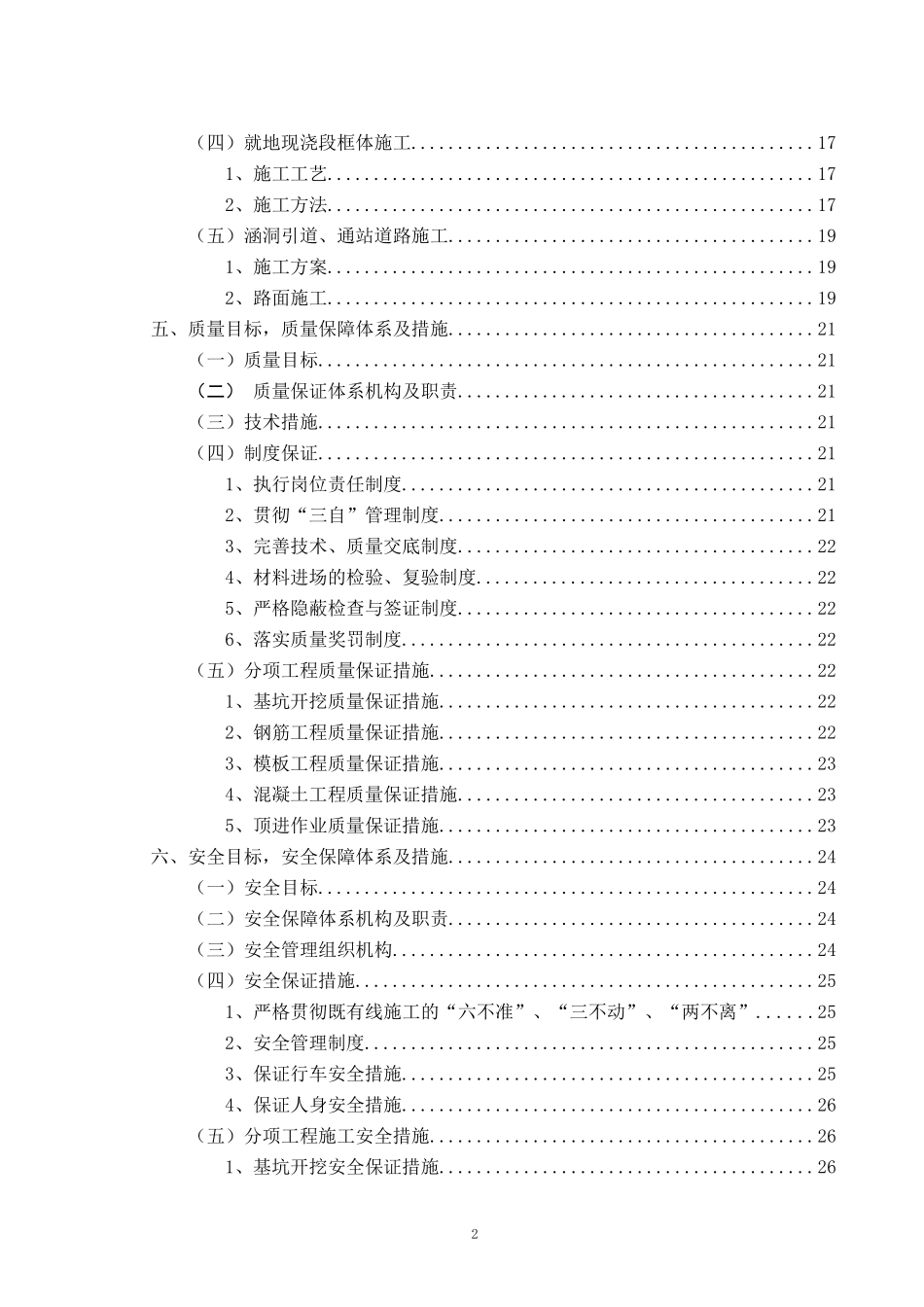

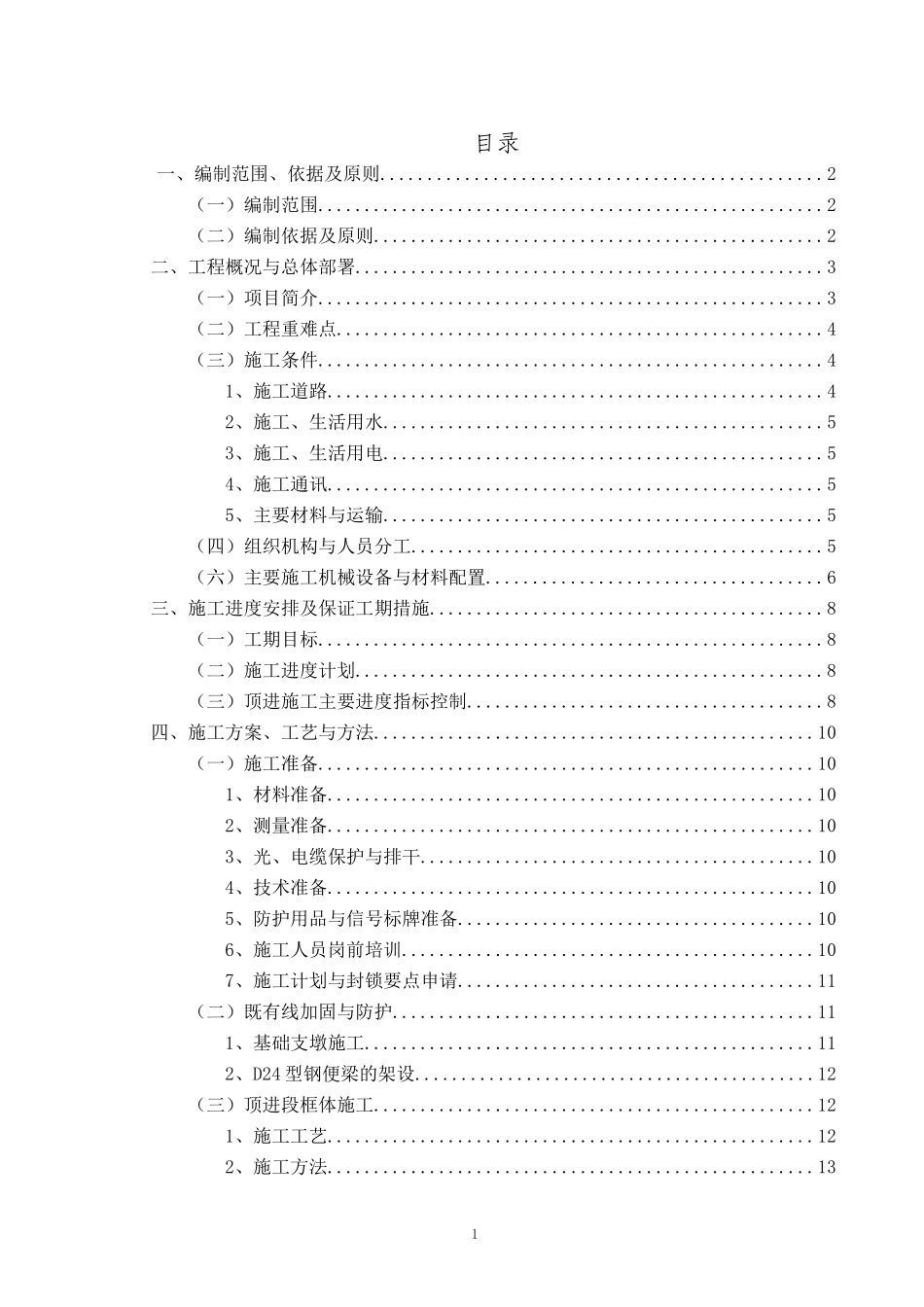

实施性施工组织设计(DK53+590(1-4m)框架涵及引道、通站道路)编制:审核:目录一、编制范围、依据及原则...............................................2(一)编制范围......................................................2(二)编制依据及原则................................................2二、工程概况与总体部署..................................................3(一)项目简介......................................................3(二)工程重难点....................................................4(三)施工条件......................................................41、施工道路.....................................................42、施工、生活用水...............................................53、施工、生活用电...............................................54、施工通讯.....................................................55、主要材料与运输...............................................5(四)组织机构与人员分工............................................5(六)主要施工机械设备与材料配置....................................6三、施工进度安排及保证工期措施..........................................8(一)工期目标......................................................8(二)施工进度计划..................................................8(三)顶进施工主要进度指标控制......................................8四、施工方案、工艺与方法...............................................10(一)施工准备.....................................................101、材料准备....................................................102、测量准备....................................................103、光、电缆保护与排干..........................................104、技术准备....................................................105、防护用品与信号标牌准备......................................106、施工人员岗前培训............................................107、施工计划与封锁要点申请......................................11(二)既有线加固与防护.............................................111、基础支墩施工................................................112、D24型钢便梁的架设...........................................12(三)顶进段框体施工...............................................121、施工工艺....................................................122、施工方法....................................................131(四)就地现浇段框体施工...........................................171、施工工艺....................................................172、施工方法....................................................17(五)涵洞引道、通站道路施工.......................................191、施工方案....................................................192、路面施工....................................................19五、质量目标,质量保障体系及措施.......................................21(一)质量目标.....................................................21(二)质量保证体系机构及职责......................................21(三)技术措施.....................................................21(四)制度保证.....................................................211、执行岗位责任制度............................................212、贯彻“三自”管理制度........................................213、完善技术、质量交底制度......................................224、材料进场的检验、复验制度....................................225、严格隐蔽检查与签...
