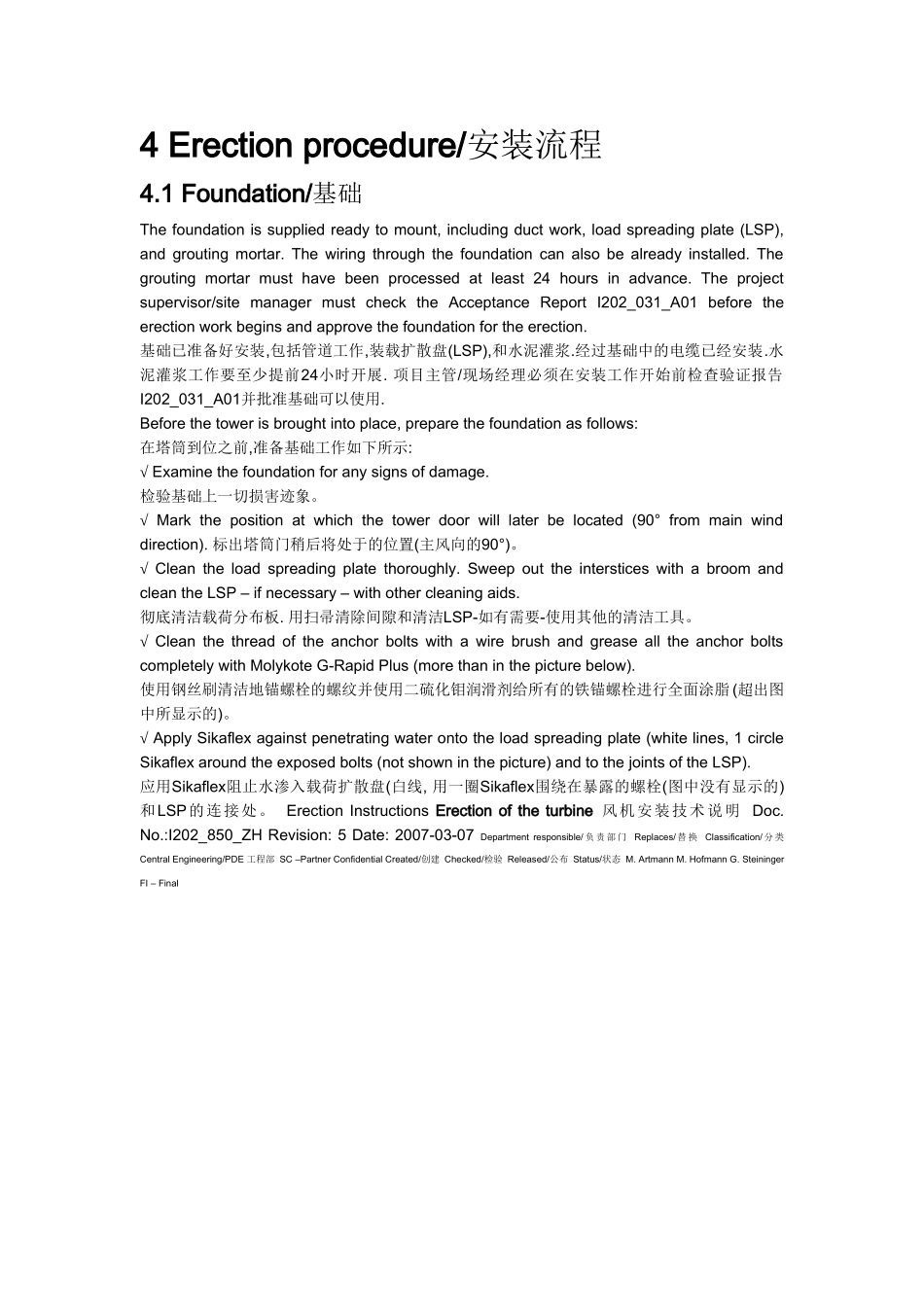

4Erectionprocedure/安装流程4

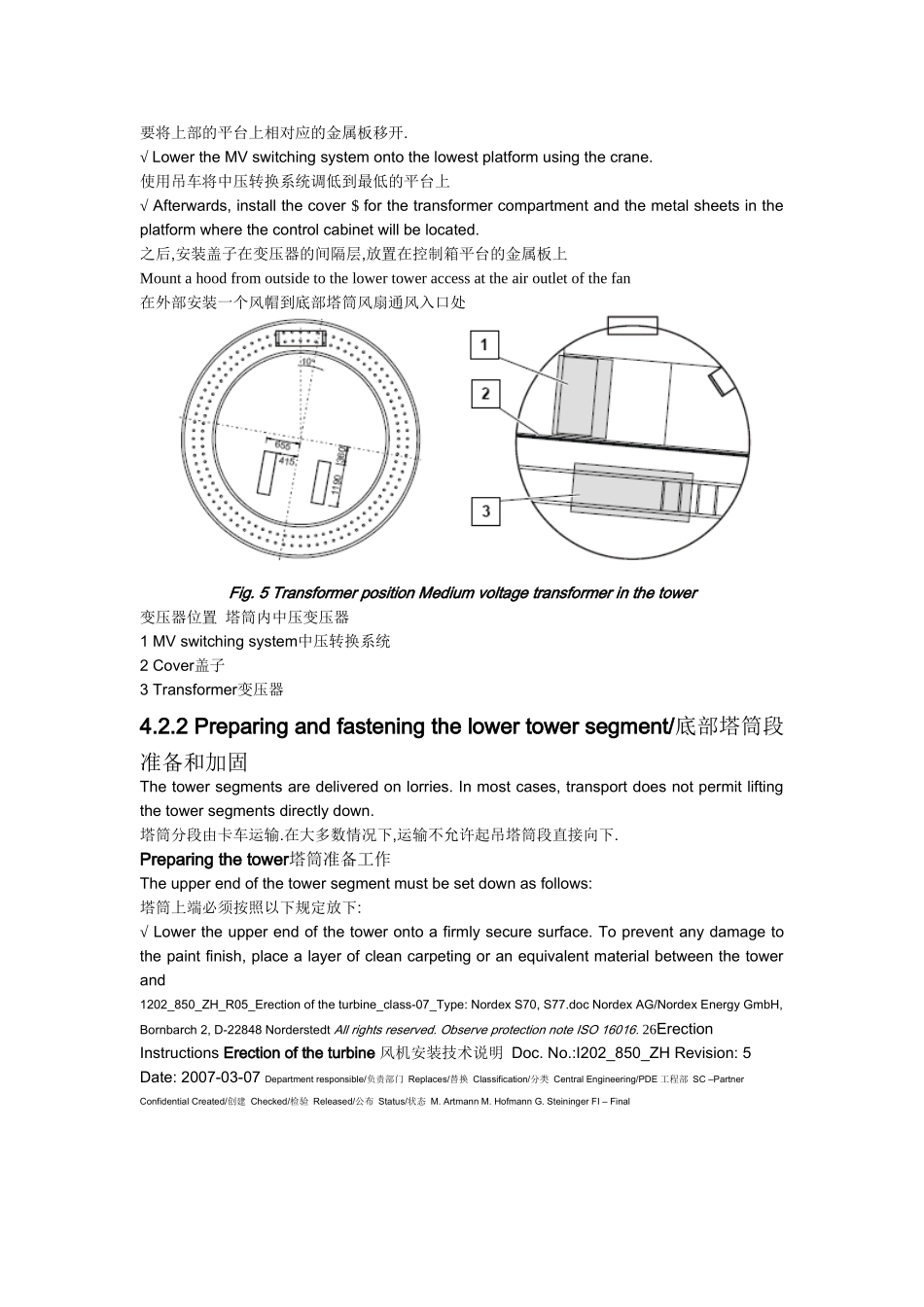

1Foundation/基础Thefoundationissuppliedreadytomount,includingductwork,loadspreadingplate(LSP),andgroutingmortar
Thewiringthroughthefoundationcanalsobealreadyinstalled
Thegroutingmortarmusthavebeenprocessedatleast24hoursinadvance
Theprojectsupervisor/sitemanagermustchecktheAcceptanceReportI202_031_A01beforetheerectionworkbeginsandapprovethefoundationfortheerection
基础已准备好安装,包括管道工作,装载扩散盘(LSP),和水泥灌浆
经过基础中的电缆已经安装
水泥灌浆工作要至少提前24小时开展
项目主管/现场经理必须在安装工作开始前检查验证报告I202_031_A01并批准基础可以使用
Beforethetowerisbroughtintoplace,preparethefoundationasfollows:在塔筒到位之前,准备基础工作如下所示:√Examinethefoundationforanysignsofdamage
检验基础上一切损害迹象
√Markthepositionatwhichthetowerdoorwilllaterbelocated(90°frommainwinddirection)
标出塔筒门稍后将处于的位置(主风向的90°)
√Cleantheloadspreadingplatethoroughly

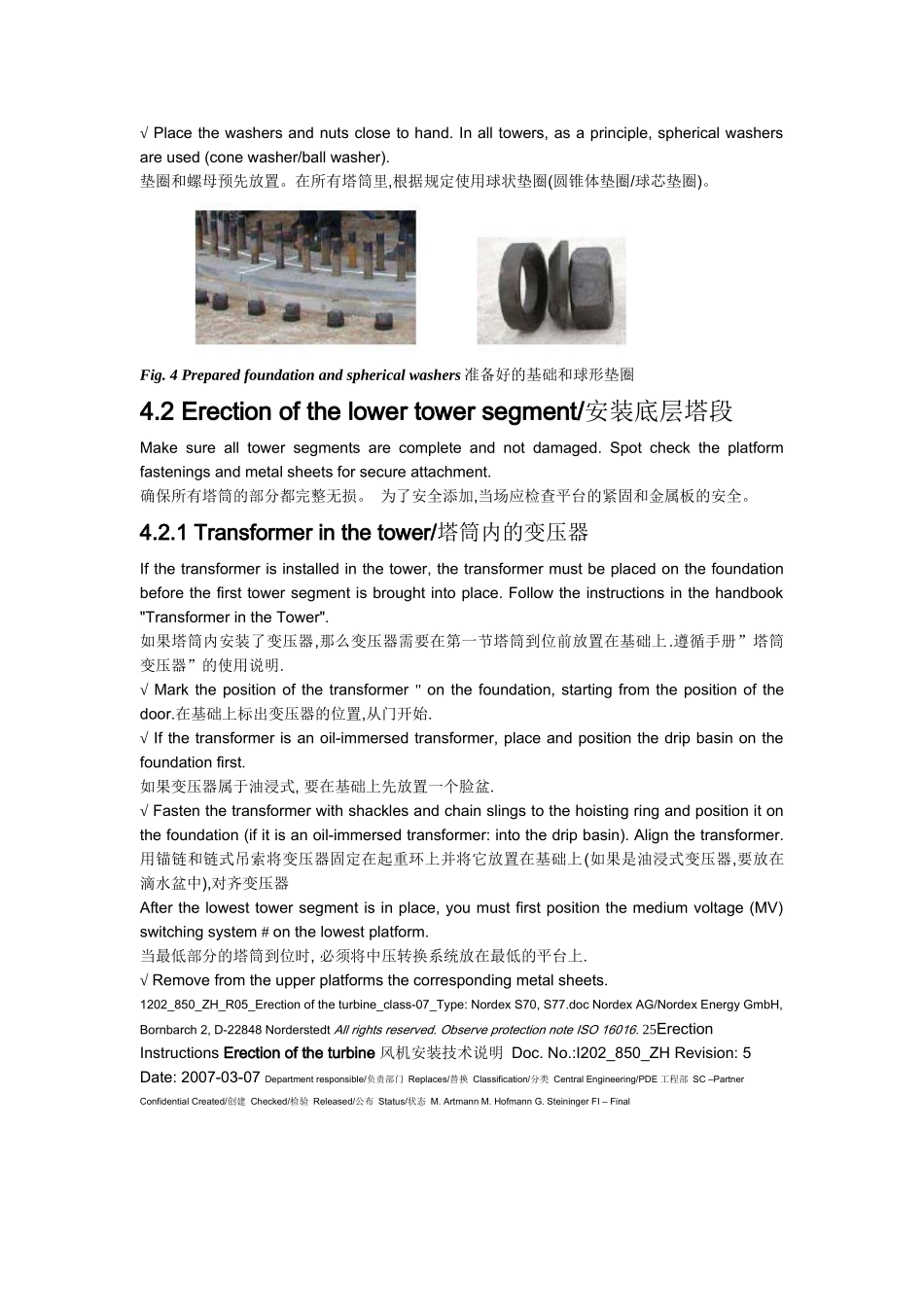

Sweepouttheintersticeswi
