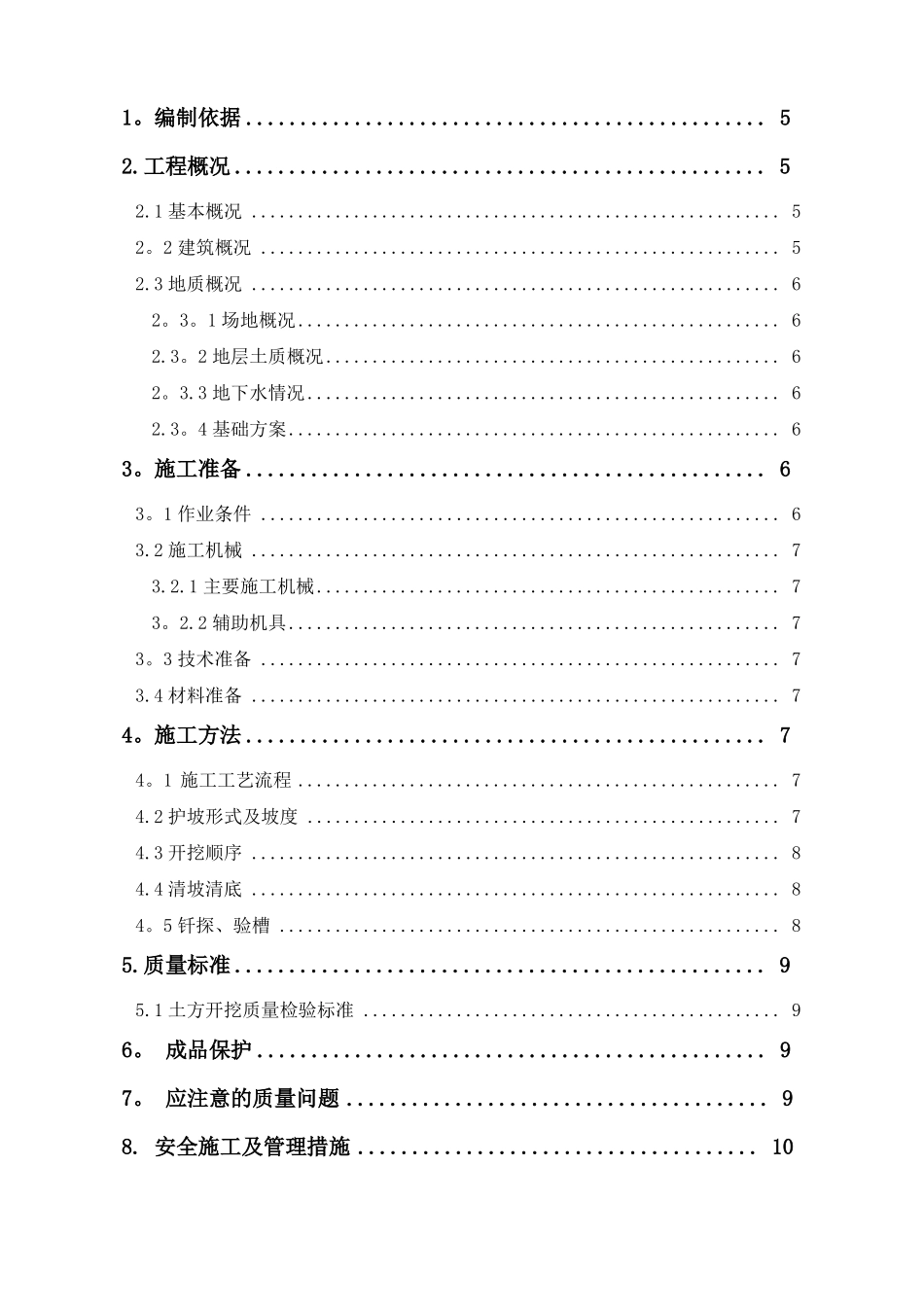

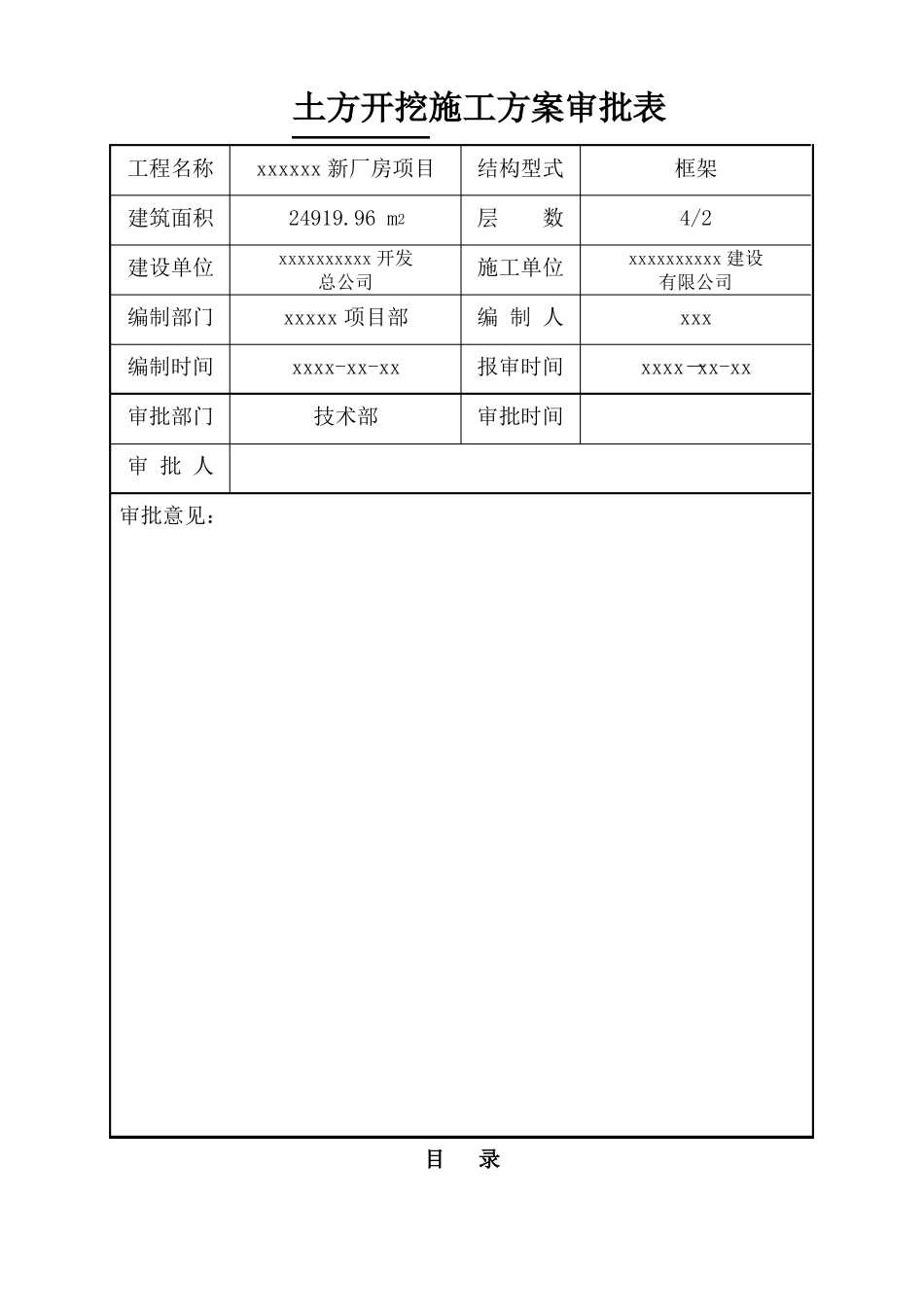

xxxxx有限公司新厂房项目土方开挖施工方案Xx建设xxxxxxxxxx建设有限公司xxxxxx项目经理部xxxx年xx月xx日土方开挖施工方案审批表工程名称建筑面积建设单位编制部门编制时间审批部门审批人审批意见:xxxxxx新厂房项目24919.96m2xxxxxxxxxx开发总公司结构型式层数施工单位编制人报审时间审批时间框架4/2xxxxxxxxxx建设有限公司xxxxx项目部xxxx-xx-xx技术部xxxxxxx—xx-xx目录1。编制依据................................................52.工程概况.................................................52.1基本概况.........................................................52。2建筑概况........................................................52.3地质概况.........................................................62。3。1场地概况....................................................62.3。2地层土质概况.................................................62。3.3地下水情况...................................................62.3。4基础方案.....................................................63。施工准备................................................63。1作业条件........................................................63.2施工机械.........................................................73.2.1主要施工机械..................................................73。2.2辅助机具.....................................................73。3技术准备........................................................73.4材料准备.........................................................74。施工方法................................................74。1施工工艺流程....................................................74.2护坡形式及坡度...................................................74.3开挖顺序.........................................................84.4清坡清底.........................................................84。5钎探、验槽......................................................85.质量标准.................................................95.1土方开挖质量检验标准.............................................96。成品保护...............................................97。应注意的质量问题.......................................98.安全施工及管理措施.....................................108.1土方分项工程安全施工的监控重点:................................108.2组织保障:......................................................108.3制度保障:......................................................108。4安全施工措施...................................................108.4。1土方施工安全:...............................................108.4.2场内外交通安全...............................................118.4.3施工机械安全.................................................118。4。4夜间施工安全...............................................118.4.5临时用电安全.................................................118。4.6消防保卫....................................................129。文明施工措施..........................................121.编制依据1。1《建筑地基基础工程施工质量验收规范》(GB50202—2002)1。2《建筑边坡工程技术规范》(GB50330—2002)1。3《北京市建筑工程施工安全操作规程》(DBJ01-62-2002)1.4《xxxxxxxxxxxxxxx有限公司新厂房项目勘察报告》1。5《xxxxxxxxxxxxxxx有限公司新厂房项目设计图纸》1.6《建筑基坑支护技术规程》(JGJ120—99)1.7《建筑地基处理技术规范》(JGJ79—2002)1。8《北京地区建筑地基基础勘察设计规范》(DBJ01-501—92)1.9《建筑工程施工技术管理规程》(DBJ01-80—2003)1。10《建...
