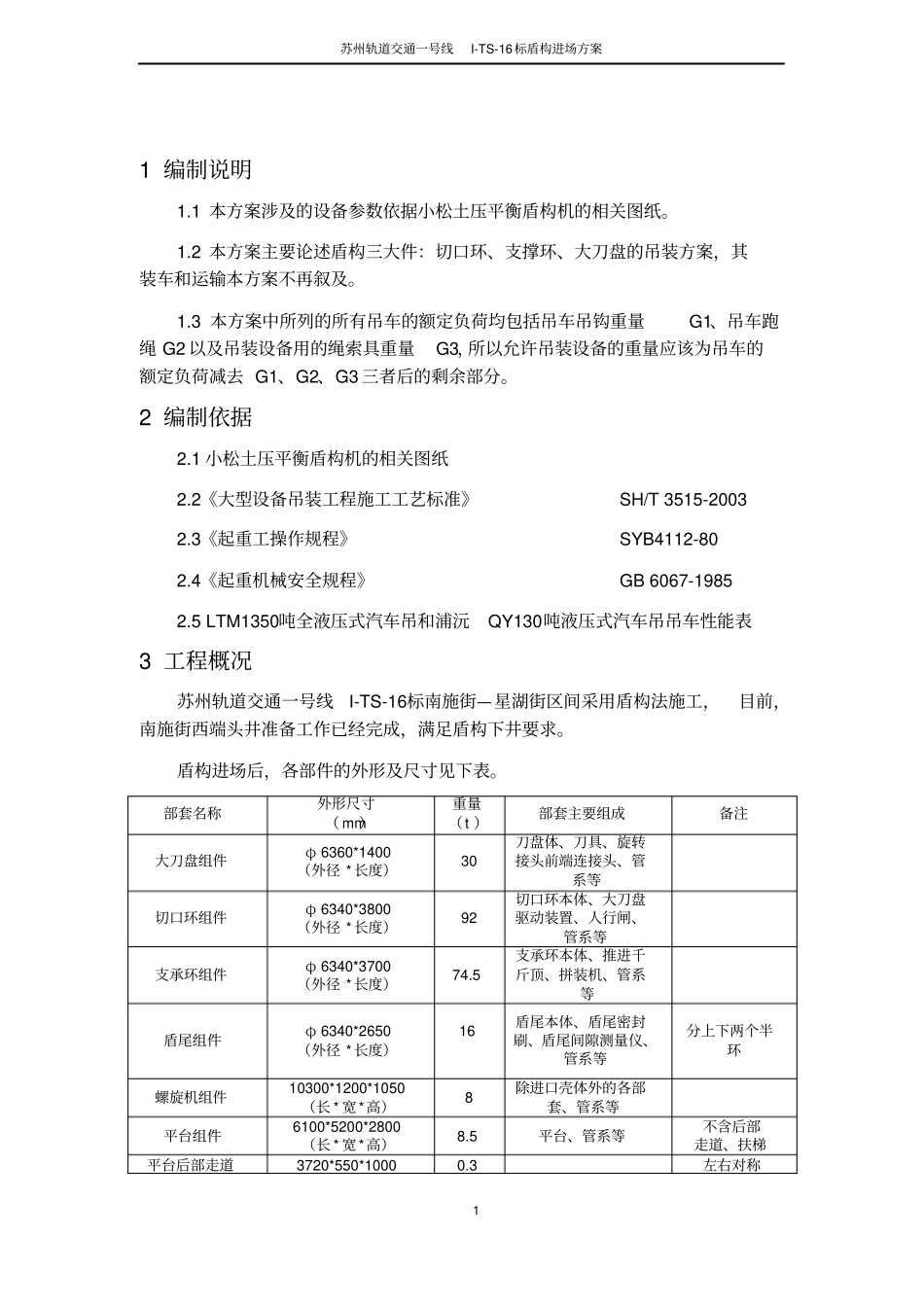

苏州轨道交通一号线I-TS-16标盾构进场方案1目录1编制说明...................................................................................................................12编制依据...................................................................................................................13工程概况...................................................................................................................14盾构进场主要施工设备...........................................................................................35盾构进场端头井要求...............................................................................................36盾构进场进度计划...................................................................................................47盾构机运输方案.......................................................................................................47.1概况................................................................................................................47.2设备参数........................................................................................................57.3作业时间及运输路线....................................................................................57.4运输作业要求................................................................................................57.5车辆配备........................................................................................................57.6作业程序及方法............................................................................................98盾构进场施工步骤.................................................................................................109盾构机吊装.............................................................................................................129.1总体吊装方案概述......................................................................................129.2设备吊装方法确定及吊装方法..................................................................139.3设备吊装工艺流程图..................................................................................149.4设备吊装能力安全计算书..........................................................................159.5设备吊装岗位职责.......................................................................................189.6装机索具选择..............................................................................................1910安全技术保障.......................................................................................................1910.1安全确认.....................................................................................................19苏州轨道交通一号线I-TS-16标盾构进场方案210.2安全确认的内容.........................................................................................1910.3安全确认的要点.........................................................................................2110.4文明施工的意义及实施要点.....................................................................2110.5盾构施工安全保障措施.............................................................................2210.6起吊作业注意事项.....................................................................................2311相关证件............................................................................................
