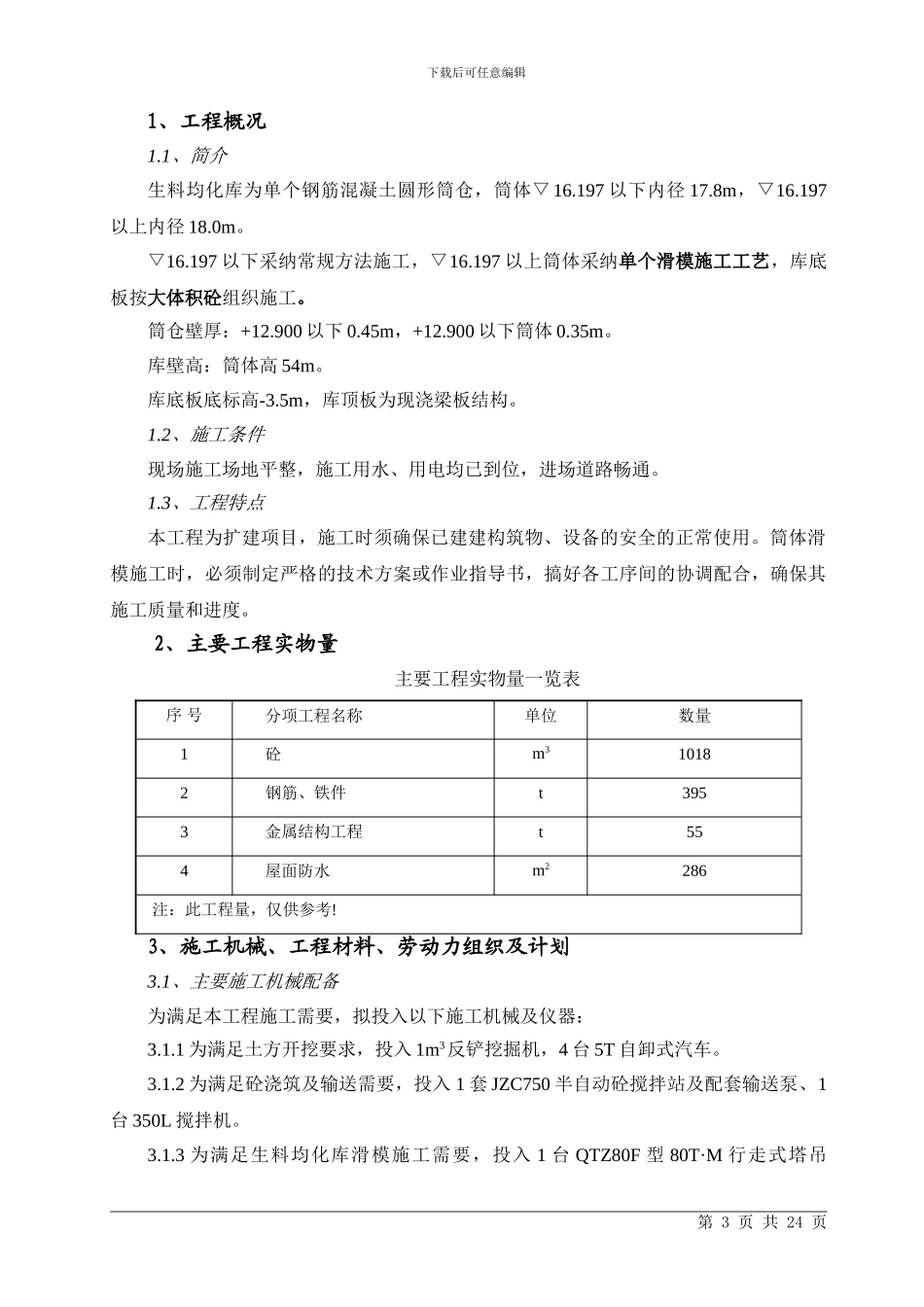

下载后可任意编辑目 录1、工程概况···················································022、主要工程实物量·············································023、施工机械、工程材料、劳动力组织及计划·······················024、进度计划及保证措施·········································055、主要施工方法及技术措施·····································06第 1 页 共 24 页下载后可任意编辑6、季节施工措施···············································177、质量保证体系及措施·········································178、安全保证体系及措施·········································209、文明及环保施工措施·········································22第 2 页 共 24 页下载后可任意编辑1、工程概况1
1、简介生料均化库为单个钢筋混凝土圆形筒仓,筒体▽16
197 以下内径 17
8m,▽16
197以上内径 18
197 以下采纳常规方法施工,▽16
197 以上筒体采纳单个滑模施工工艺,库底板按大体积砼组织施工
筒仓壁厚:+12
900 以下 0
45m,+12
900 以下筒体 0
库壁高:筒体高 54m
库底板底标高-3
5m,库顶板为现浇梁板结构
2、施工条件现场施工场地平整,施工用水、用电均已到位,进场道路畅通
3、工程特点本工程为扩建项目,施工时须确保已建建构筑
