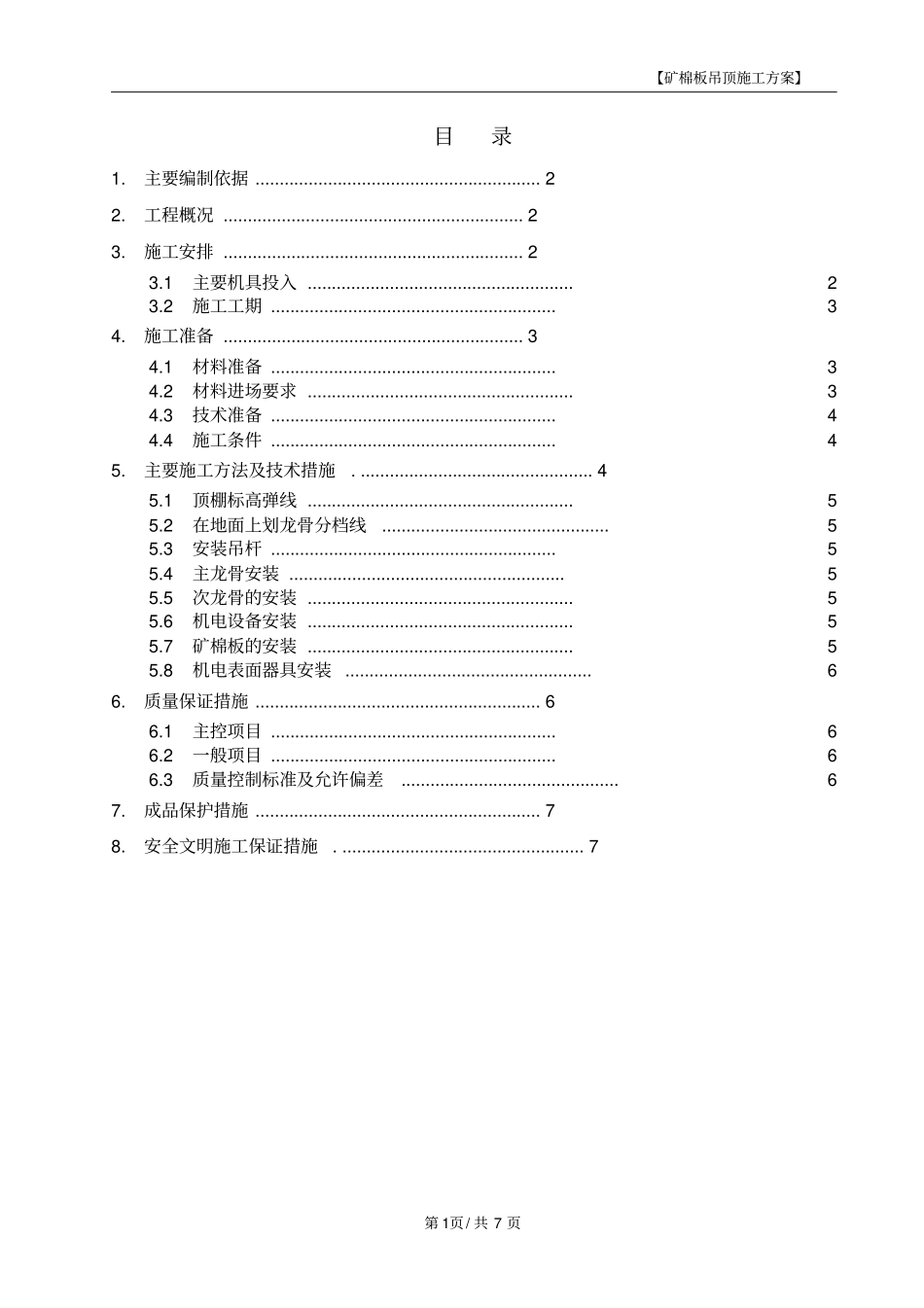

【矿棉板吊顶施工方案】第 1页/ 共 7 页目录1.主要编制依据 ........................................................... 22.工程概况 .............................................................. 23.施工安排 .............................................................. 23.1主要机具投入 ....................................................... 23.2施工工期 ........................................................... 34.施工准备 .............................................................. 34.1材料准备 ........................................................... 34.2材料进场要求 ....................................................... 34.3技术准备 ........................................................... 44.4施工条件 ........................................................... 45.主要施工方法及技术措施. ................................................ 45.1顶棚标高弹线 ....................................................... 55.2在地面上划龙骨分档线............................................... 55.3安装吊杆 ........................................................... 55.4主龙骨安装 ......................................................... 55.5次龙骨的安装 ....................................................... 55.6机电设备安装 ....................................................... 55.7矿棉板的安装 ....................................................... 55.8机电表面器具安装 ................................................... 66.质量保证措施 ........................................................... 66.1主控项目 ........................................................... 66.2一般项目 ........................................................... 66.3质量控制标准及允许偏差............................................. 67.成品保护措施 ........................................................... 78.安全文明施工保证措施. .................................................. 7【矿棉板吊顶施工方案】第 2页/ 共 7 页1. 主要编制依据1....
