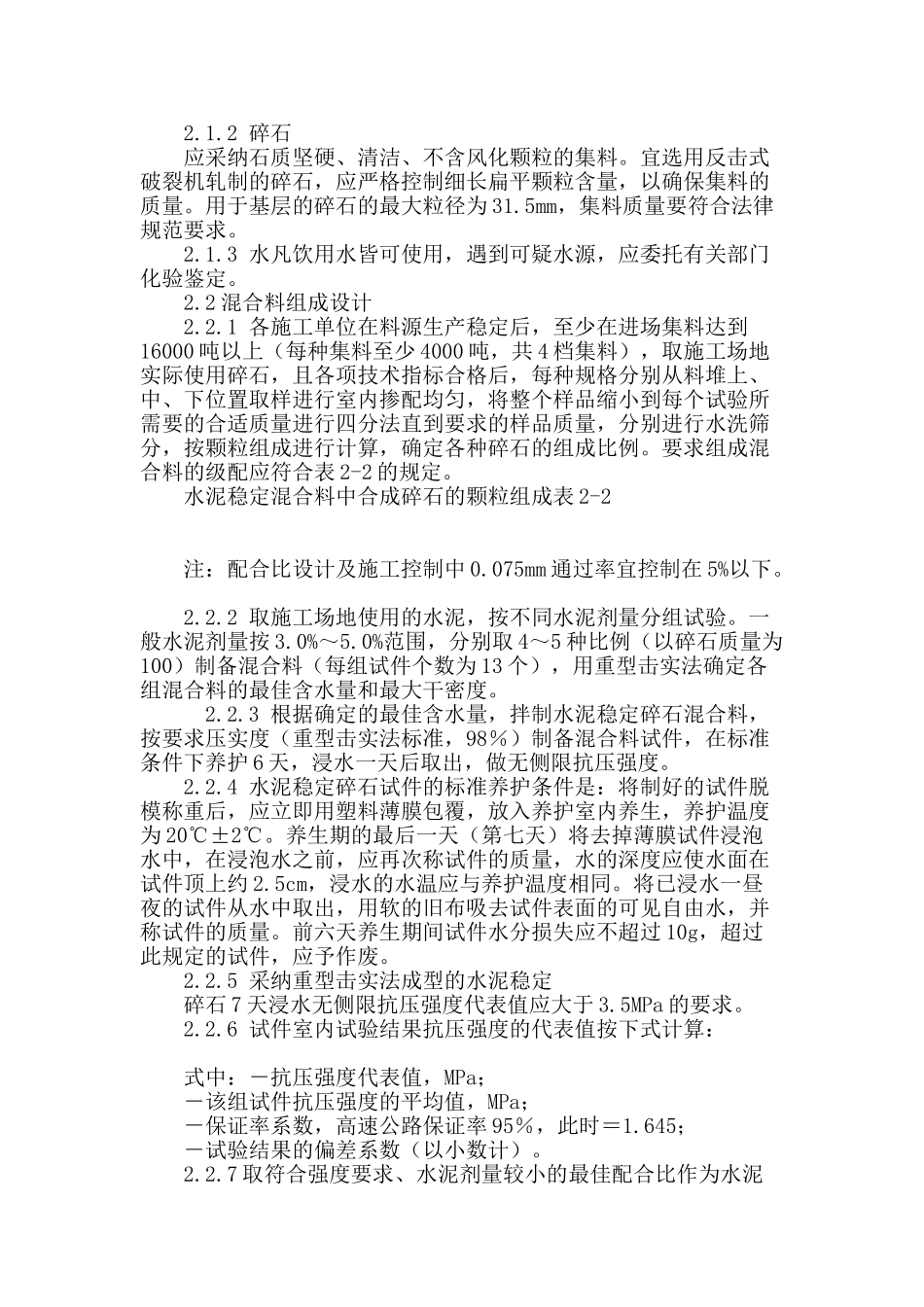

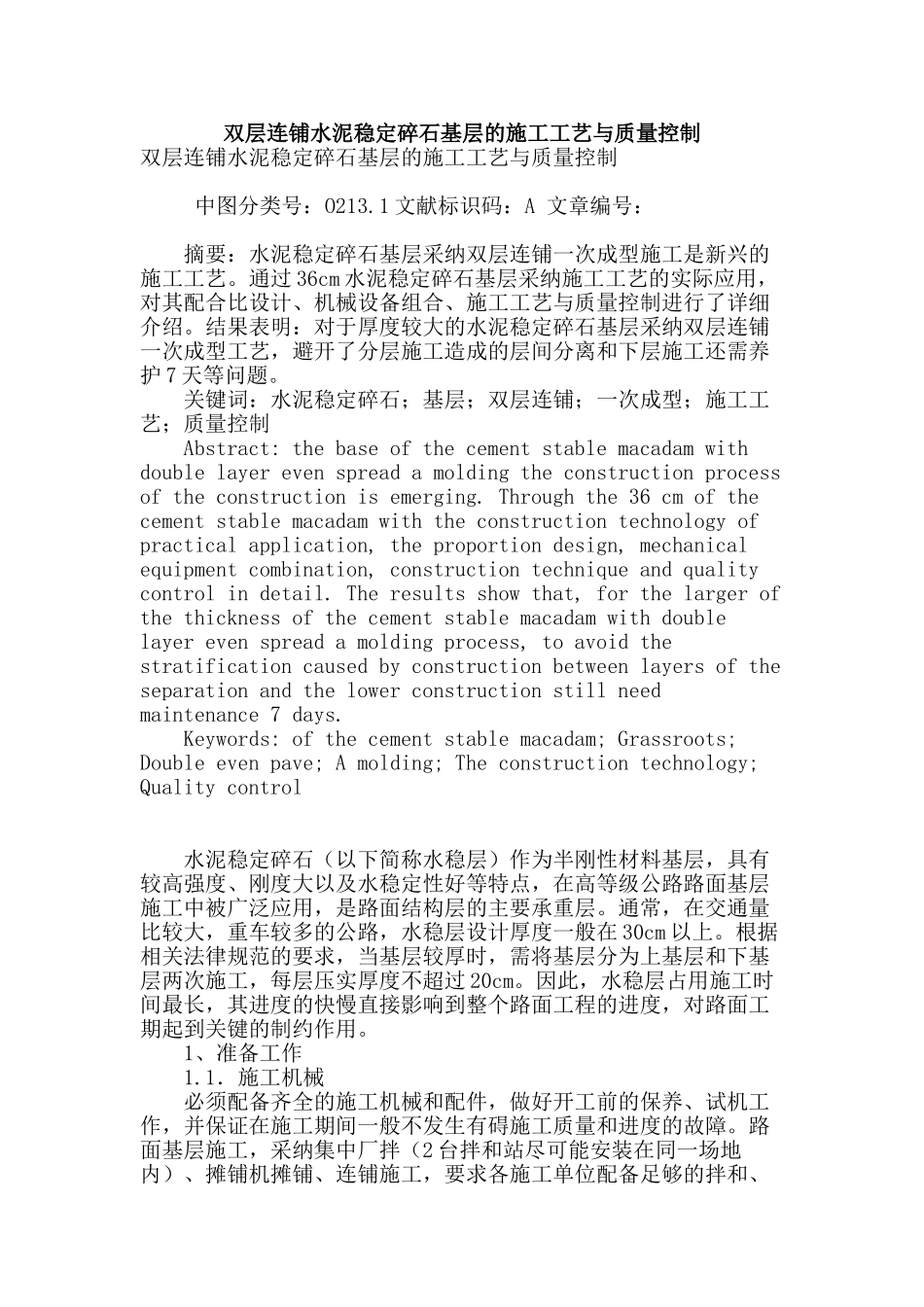

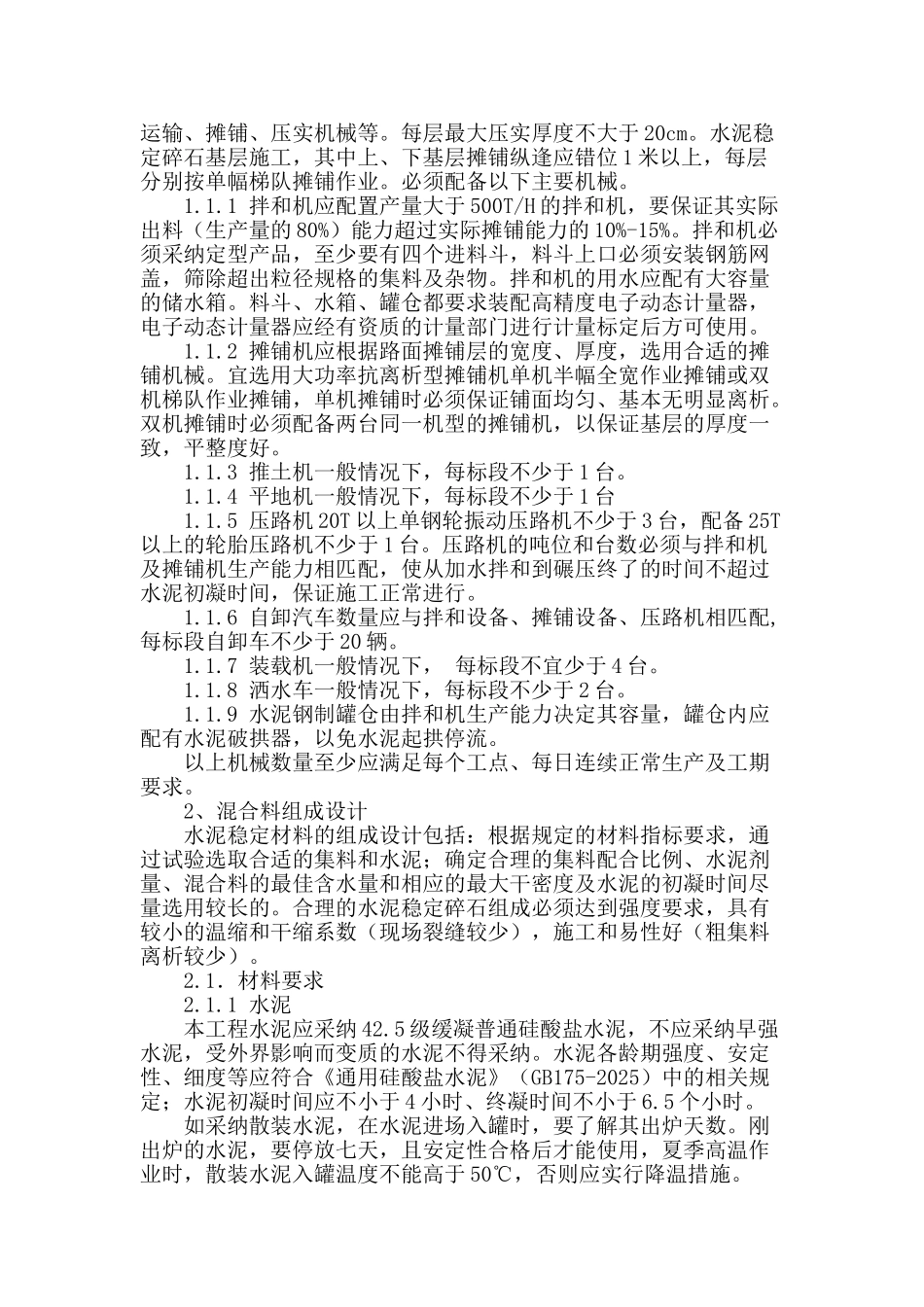

双层连铺水泥稳定碎石基层的施工工艺与质量控制双层连铺水泥稳定碎石基层的施工工艺与质量控制 中图分类号:O213.1 文献标识码:A 文章编号: 摘要:水泥稳定碎石基层采纳双层连铺一次成型施工是新兴的施工工艺。通过 36cm 水泥稳定碎石基层采纳施工工艺的实际应用,对其配合比设计、机械设备组合、施工工艺与质量控制进行了详细介绍。结果表明:对于厚度较大的水泥稳定碎石基层采纳双层连铺一次成型工艺,避开了分层施工造成的层间分离和下层施工还需养护 7 天等问题。 关键词:水泥稳定碎石;基层;双层连铺;一次成型;施工工艺;质量控制 Abstract: the base of the cement stable macadam with double layer even spread a molding the construction process of the construction is emerging. Through the 36 cm of the cement stable macadam with the construction technology of practical application, the proportion design, mechanical equipment combination, construction technique and quality control in detail. The results show that, for the larger of the thickness of the cement stable macadam with double layer even spread a molding process, to avoid the stratification caused by construction between layers of the separation and the lower construction still need maintenance 7 days. Keywords: of the cement stable macadam; Grassroots; Double even pave; A molding; The construction technology; Quality control 水泥稳定碎石(以下简称水稳层)作为半刚性材料基层,具有较高强度、刚度大以及水稳定性好等特点,在高等级公路路面基层施工中被广泛应用,是路面结构层的主要承重层。通常,在交通量比较大,重车较多的公路,水稳层设计厚度一般在 30cm 以上。根据相关法律规范的要求,当基层较厚时,需将基层分为上基层和下基层两次施工,每层压实厚度不超过 20cm。因此,水稳层占用施工时间最长,其进度的快慢直接影响到整个路面工程的进度,对路面工期起到关键的制约作用。 1、准备工作 1.1.施工机械 必须配备齐全的施工机械和配件,做好开工前的保养、试机工作,并保证在施工期间一般不发生有碍施工质量和进度的故障。路面基层施工,采纳集中厂拌(2 台拌...
