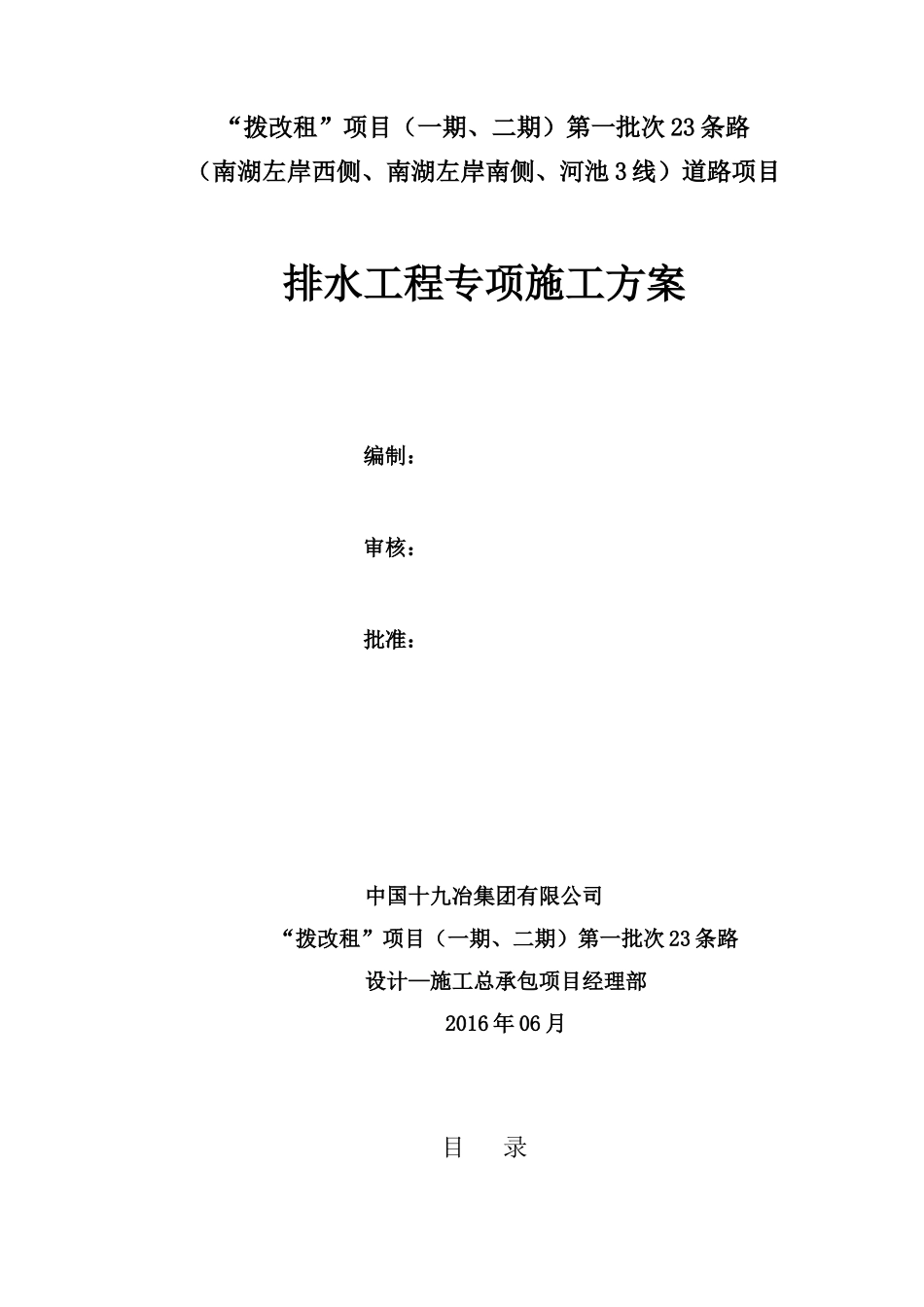

“拨改租”项目(一期、二期)第一批次23条路(南湖左岸西侧、南湖左岸南侧、河池3线)道路项目排水工程专项施工方案编制:审核:批准:中国十九冶集团有限公司“拨改租”项目(一期、二期)第一批次23条路设计—施工总承包项目经理部2016年06月目录一编制原则及依据......................................................................................................41.1、编制原则........................................................................................................41.2、编制依据........................................................................................................4二排水工程概况.........................................................................................................52.1、排水工程概况.................................................................................................5三施工组织及部署......................................................................................................93.1、施工总体目标.................................................................................................93.2、施工部署........................................................................................................93.3、物资准备......................................................................................................103.4、机械设备准备...............................................................................................10四施工工艺...............................................................................................................114.1、排水管道施工工艺.......................................................................................114.2、雨、污水检查井施工...................................................................................234.3、管道闭水试验...............................................................................................254.4、管道及附属设施...........................................................................................29五雨季施工措施.......................................................................................................31六工期保证措施.......................................................................................................336.1、工期要求......................................................................................................336.2、工期保证措施...............................................................................................36七工程质量管理体系及保证措施............................................................................397.1、质量保证体系...............................................................................................397.2、工程质量保证措施.......................................................................................427.3、组织保证措施...............................................................................................427.4、思想教育保证措施.......................................................................................437.5、技术管理保证措施.......................................................................................43八安全保证体系及保证措施....................................................................................448.1、安全目标......................................................................................................4...
